Committee of the Whole/Documents/SITE REPORT No. 27 - 1122 VIEW ROYAL PUBLIC SAFETY BUILDING
Staff Report

SITE REPORT No. 27 - 1122 VIEW ROYAL PUBLIC SAFETY BUILDING

April 8, 2014Pages 34–442 sections

Construction progress report for the new Public Safety Building, including site photos and financial budget status.

April 2, 2014Total revised budget: $7,402,160Projected expenditures to date: $2,788,481Construction activities include floor framing and concrete pouring for Level 2

SITE REPORT No. 27

TO: Ledcor Construction Ltd. Mike Forsyth / Jan Coetzee 203 - 830 Shamrock Street Victoria, BC V8X 2V1

FROM: Heather Spinney

CC: Paul Hurst / Kim Anema + Gary Faykes (Bldg Inspector) View Royal Adam Fawkes, Roger Hughes, HCMA Jonathan Reiter, RJC Tom Wilson, AME Iain Barnes, AES Jeff Ball / Gene Mazza, Associated Engineering Shane Moore, Ryzuk

PROJECT: 1122 VIEW ROYAL PUBLIC SAFETY BUILDING DATE: 2014.04.02

Date of visit: 2014.03.27 Weather: 12°C, Mix of Sun & Cloud Present: Heather Spinney

Item Work in Progress - Observations Action
SITE PANORAMAS – 2014.03.27
High view from west looking to east
High view from west looking to east
High view from west looking to east. (above) Low view from north looking to south. (below)
Low view from north looking to south
Low view from north looking to south
High view from south looking north (top photo)
High view from south looking north (top photo)
High view from south looking north. (above & below)
High view from south looking north (middle photo)
High view from south looking north (middle photo)
27.1 Support Wing
Photo of Support Wing construction
Photo of Support Wing construction
27.2 Administration Wing
Photo of Administration Wing construction
Photo of Administration Wing construction
27.3 Work associated w. PCN 23 + CD 03 in progress. (left) Civil infrastructure @ Heddle Path (right) INFO
Work associated w. PCN 23 + CD 03 in progress (left)
Work associated w. PCN 23 + CD 03 in progress (left)
Civil infrastructure @ Heddle Path (right)
Civil infrastructure @ Heddle Path (right)
27.4 A significant amount of blasting work remains as part of base contract – including, but not necessarily limited to the areas circled in red: Training Ground (left) Upper Parking (right) INFO
27.5 A significant amount of material has been removed – either off-site or used for backfill. INFO
27.6 Preparation of cut slope in progress as noted in Ryzuk preliminary site sections, issued informally for discussion following the meeting on site 2014.03.13. PCN to be issued now that slope is partially exposed and Geotechnical can confirm parameters for retaining slope. Area circled in red indicates approximate area to be blasted as part of base contract. INFO
SUPPORT WING:
27.7 View of support wing from driveway (left) and from Heddle Park (right). INFO

27.8 Preparations for concrete pour in progress. Electrical infrastructure crossing towards GL4 (noted by yellow tape in right photo) INFO
27.9 Suspended slab placed. Installation of structural steel in progress. It should noted that the columns are part of the Apparatus Bay, which is identified as a “wet area” and requires a different paint system, including primer, per specification. It is understood that this issue is currently being addressed by the Contractor in conversation with MPDA technical representative. LED
HOSE TOWER:
27.10 Additional formwork removed. Concrete repairs to follow. Sequencing meeting to be held to discuss concrete repair, sandblasting and installation of steel components. Contractor to arrange. LED
27.11 Steel components for hose tower on site. Galvanized stair appears to conform to specification. Detail photo of galvanized stair courtesy of LCL. INFO
ADMINISTRATION WING:
27.12 Floor framing + wall framing in progress – view from Level 1 INFO
27.13 It is understood that this bracket is being adjusted to suit beam location. (left) There may be other brackets that require some form of adjustment. (right) LED
27.14 Floor framing in progress – view from Level 2. INFO
27.15 Forming for Level 2 concrete in progress. INFO
APPARATUS BAY:

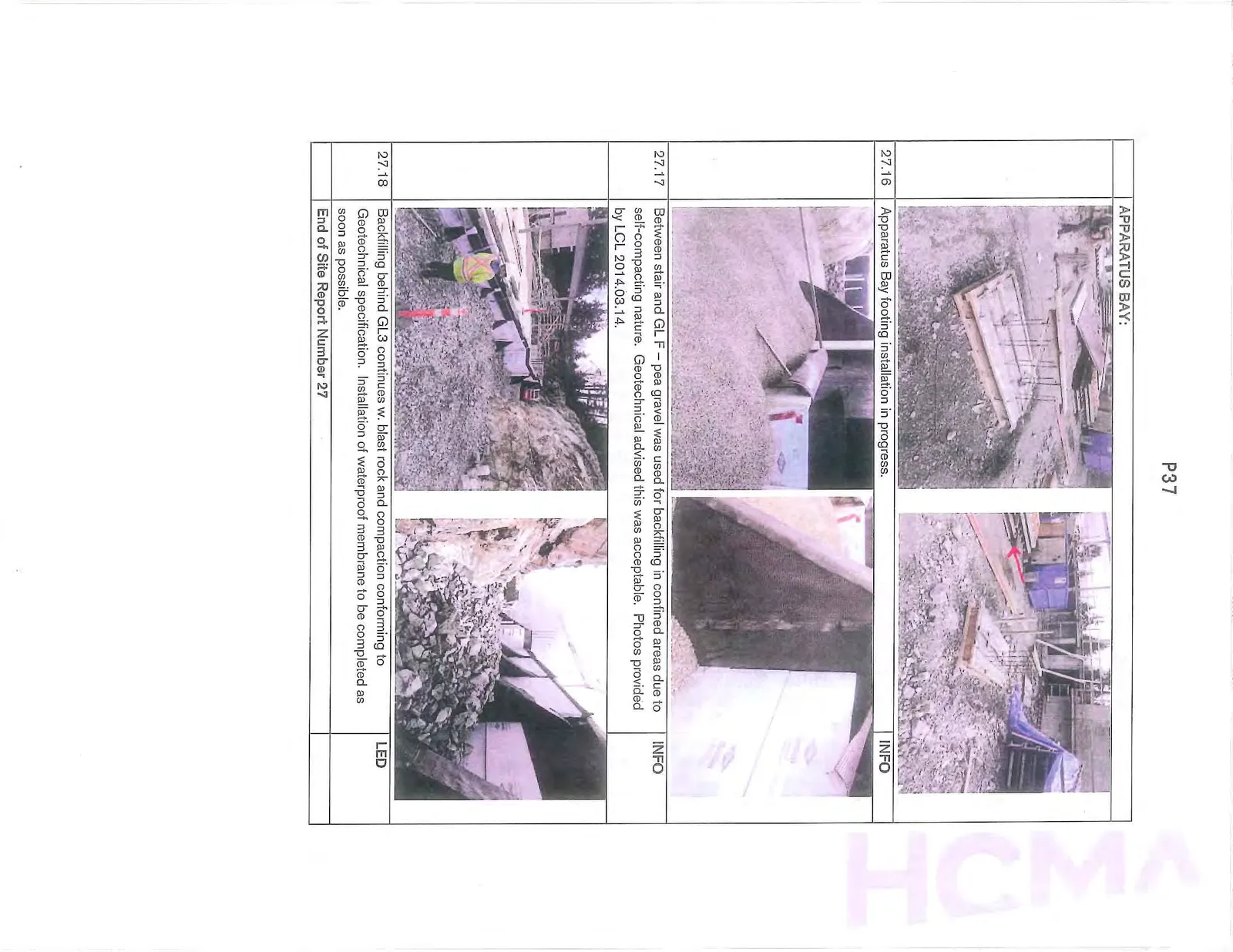

27.16 Apparatus Bay footing installation in progress. INFO
27.17 Between stair and GL F – pea gravel was used for backfilling in confined areas due to self-compacting nature. Geotechnical advised this was acceptable. Photos provided by LCL 2014.03.14. INFO
27.18 Backfilling behind GL3 continues w. blast rock and compaction conforming to Geotechnical specification. Installation of waterproof membrane to be completed as soon as possible. LED

End of Site Report Number 27

Page 34–44

PUBLIC SAFETY BUILDING

Budget Table - Part 1
Budget Table - Part 1
Budget after Tender Revisions Revised Budget As at Mar. 31, 2014 Committed Total Budget Variance

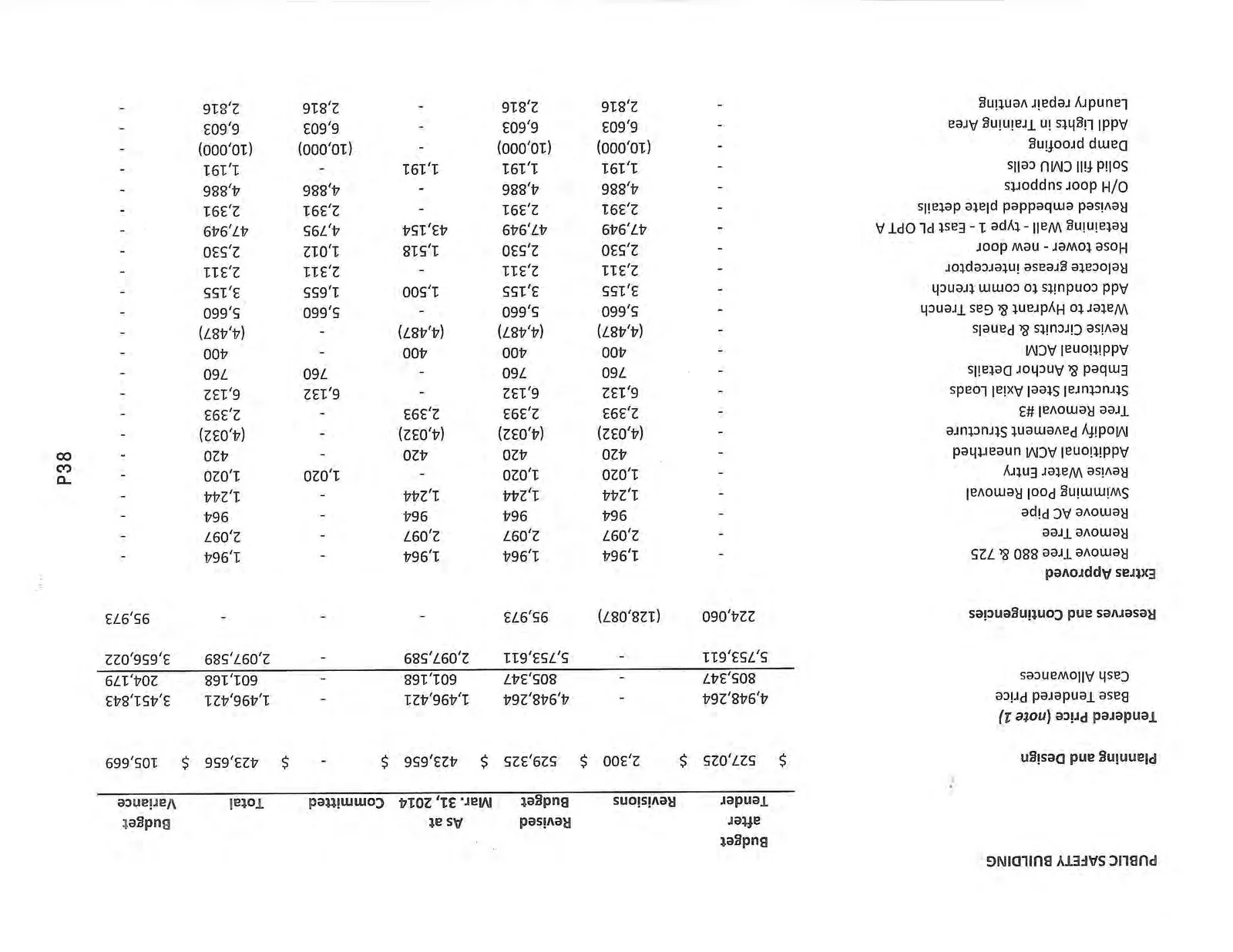

Planning and Design $ 527,025 $ 2,300 $ 529,325 $ 423,656 $ - $ 423,656 $ 105,669
Tendered Price (note 1)
Base Tendered Price 4,948,264 - 4,948,264 1,496,421 - 1,496,421 3,451,843
Cash Allowances 805,347 - 805,347 601,168 - 601,168 204,179
5,753,611 - 5,753,611 2,097,589 - 2,097,589 3,656,022
Reserves and Contingencies 224,060 (128,087) 95,973 - - - 95,973
Extras Approved
Remove Tree 880 & 725 - 1,964 1,964 1,964 - 1,964 -
Remove Tree - 2,097 2,097 2,097 - 2,097 -
Remove AC Pipe - 964 964 964 - 964 -
Swimming Pool Removal - 1,244 1,244 1,244 - 1,244 -
Revise Water Entry - 1,020 1,020 - 1,020 1,020 -
Additional ACM unearthed - 420 420 420 - 420 -
Modify Pavement Structure - (4,032) (4,032) (4,032) - (4,032) -
Tree Removal #3 - 2,393 2,393 2,393 - 2,393 -
Structural Steel Axial Loads - 6,132 6,132 - 6,132 6,132 -
Embed & Anchor Details - 760 760 - 760 760 -
Additional ACM - 400 400 400 - 400 -
Revise Circuits & Panels - (4,487) (4,487) (4,487) - (4,487) -
Water to Hydrant & Gas Trench - 5,660 5,660 - 5,660 5,660 -
Add conduits to comm trench - 3,155 3,155 1,500 1,655 3,155 -
Relocate grease interceptor - 2,311 2,311 - 2,311 2,311 -
Hose tower - new door - 2,530 2,530 1,518 1,012 2,530 -
Retaining Wall - type 1 - East PL OPT A - 47,949 47,949 43,154 4,795 47,949 -
Revised embedded plate details - 2,391 2,391 - 2,391 2,391 -
O/H door supports - 4,886 4,886 - 4,886 4,886 -
Solid fill CMU cells - 1,191 1,191 1,191 - 1,191 -
Damp proofing - (10,000) (10,000) - (10,000) (10,000) -
Addl Lights in Training Area - 6,603 6,603 - 6,603 6,603 -
Laundry repair venting - 2,816 2,816 - 2,816 2,816 -
Budget Table - Part 2
Budget Table - Part 2
Budget after Tender Revisions Revised Budget As at Mar. 31, 2014 Committed Total Budget Variance

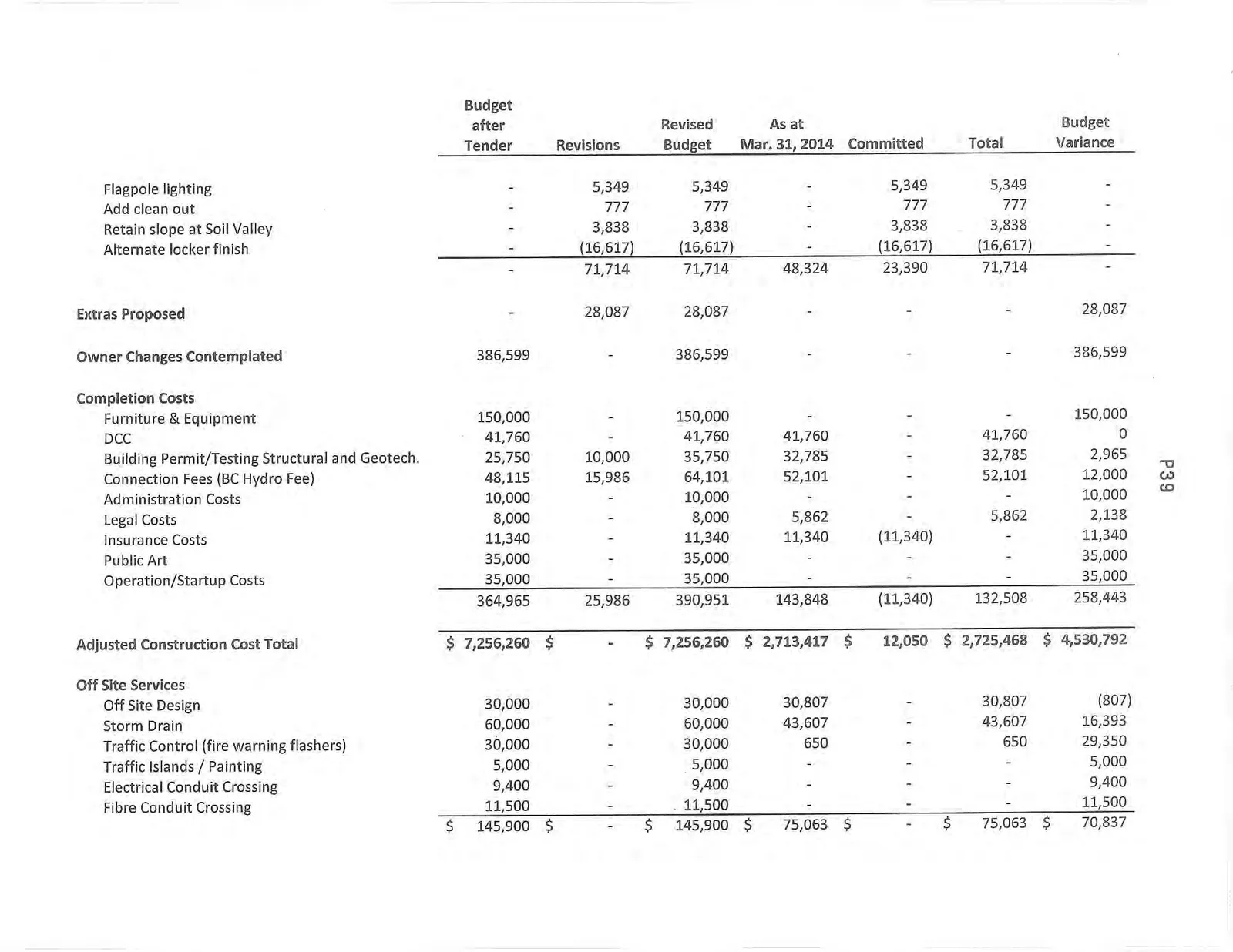

Flagpole lighting - 5,349 5,349 - 5,349 5,349 -
Add clean out - 777 777 - 777 777 -
Retain slope at Soil Valley - 3,838 3,838 - 3,838 3,838 -
Alternate locker finish - (16,617) (16,617) - (16,617) (16,617) -
- 71,714 71,714 48,324 23,390 71,714 -
Extras Proposed - 28,087 28,087 - - - 28,087
Owner Changes Contemplated 386,599 - 386,599 - - - 386,599
Completion Costs
Furniture & Equipment 150,000 - 150,000 - - - 150,000
DCC 41,760 - 41,760 41,760 - 41,760 0
Building Permit/Testing Structural and Geotech. 25,750 10,000 35,750 32,785 - 32,785 2,965
Connection Fees (BC Hydro Fee) 48,115 15,986 64,101 52,101 - 52,101 12,000
Administration Costs 10,000 - 10,000 - - - 10,000
Legal Costs 8,000 - 8,000 5,862 - 5,862 2,138
Insurance Costs 11,340 - 11,340 11,340 (11,340) - 11,340
Public Art 35,000 - 35,000 - - - 35,000
Operation/Startup Costs 35,000 - 35,000 - - - 35,000
364,965 25,986 390,951 143,848 (11,340) 132,508 258,443
Adjusted Construction Cost Total $ 7,256,260 $ - $ 7,256,260 $ 2,713,417 $ 12,050 $ 2,725,468 $ 4,530,792
Off Site Services
Off Site Design 30,000 - 30,000 30,807 - 30,807 (807)
Storm Drain 60,000 - 60,000 43,607 - 43,607 16,393
Traffic Control (fire warning flashers) 30,000 - 30,000 650 - 650 29,350
Traffic Islands / Painting 5,000 - 5,000 - - - 5,000
Electrical Conduit Crossing 9,400 - 9,400 - - - 9,400
Fibre Conduit Crossing 11,500 - 11,500 - - - 11,500
$ 145,900 $ - $ 145,900 $ 75,063 $ - $ 75,063 $ 70,837
Budget Table - Part 3
Budget Table - Part 3
Budget after Tender Revisions Revised Budget As at Mar. 31, 2014 Committed Total Budget Variance
Total Construction and Off Site Services $ 7,402,160 $ - $ 7,402,160 $ 2,788,481 $ 12,050 $ 2,800,531 $ 4,601,629

Note 1 Tendered price: 5,753,611 Tax charged (rebatable): 287,681 Total including tax: 6,041,292

Page 34–44
Extracted from: 2014 04 08 Committee of the Whole Agenda
