Council Meeting/Documents/STAFF REPORT - RESIDENTIAL DEVELOPMENT UPDATE REPORT
Staff Report

STAFF REPORT - RESIDENTIAL DEVELOPMENT UPDATE REPORT

May 7, 2024Pages 97–1012 sections

Report providing an update on major residential projects currently under construction or approved in the Town, totaling 772 new units.

1 CALL TO ORDER- Mayor Tobias called the meeting to order at 7:00 p.m.
April 29, 2024Deliver 772 new dwelling units within two yearsIncludes 550 rental units and 222 strata unitsAddress: 244 Island HwyAddress: 258 Helmcken RdAddress: Erskine LaneAddress: 1449 Burnside Rd WAddress: 181 Island HwyAddress: 2000 West Park Lane

TOWN OF VIEW ROYAL

COUNCIL REPORT

TO: Council
DATE: April 29, 2024
FROM: L.Taylor, RPP, MCIP Director of Development Services
MEETING DATE: May 7, 2024

Page 97–101

RESIDENTIAL DEVELOPMENT UPDATE REPORT

RECOMMENDATION

THAT the report dated April 29, 2024, titled “Housing Supply Update Report” prepared by the Director of Development Services be received.

PURPOSE

The purpose of this report is to provide Council with an update on the total number of dwelling units in large projects, including mixed-use and multi-unit residential developments, that are: currently under construction; or approved by Council but not yet under construction (no building permit).

BACKGROUND

At the Committee of the Whole Meeting on April 11, 2023, Council requested that staff bring forward an update on approved large projects (mixed-use and residential developments) in the Town to further understand the current and future housing supply being delivered by the development industry.

The last residential development update report was presented at the Committee of the Whole Meeting on October 10, 2023. This report gives Council an update on how the large projects have progressed through the fall and winter months.

DISCUSSION

Figure 1 below is a map identifying the total number of dwelling units currently under construction in the Town, as of April 28, 2024.

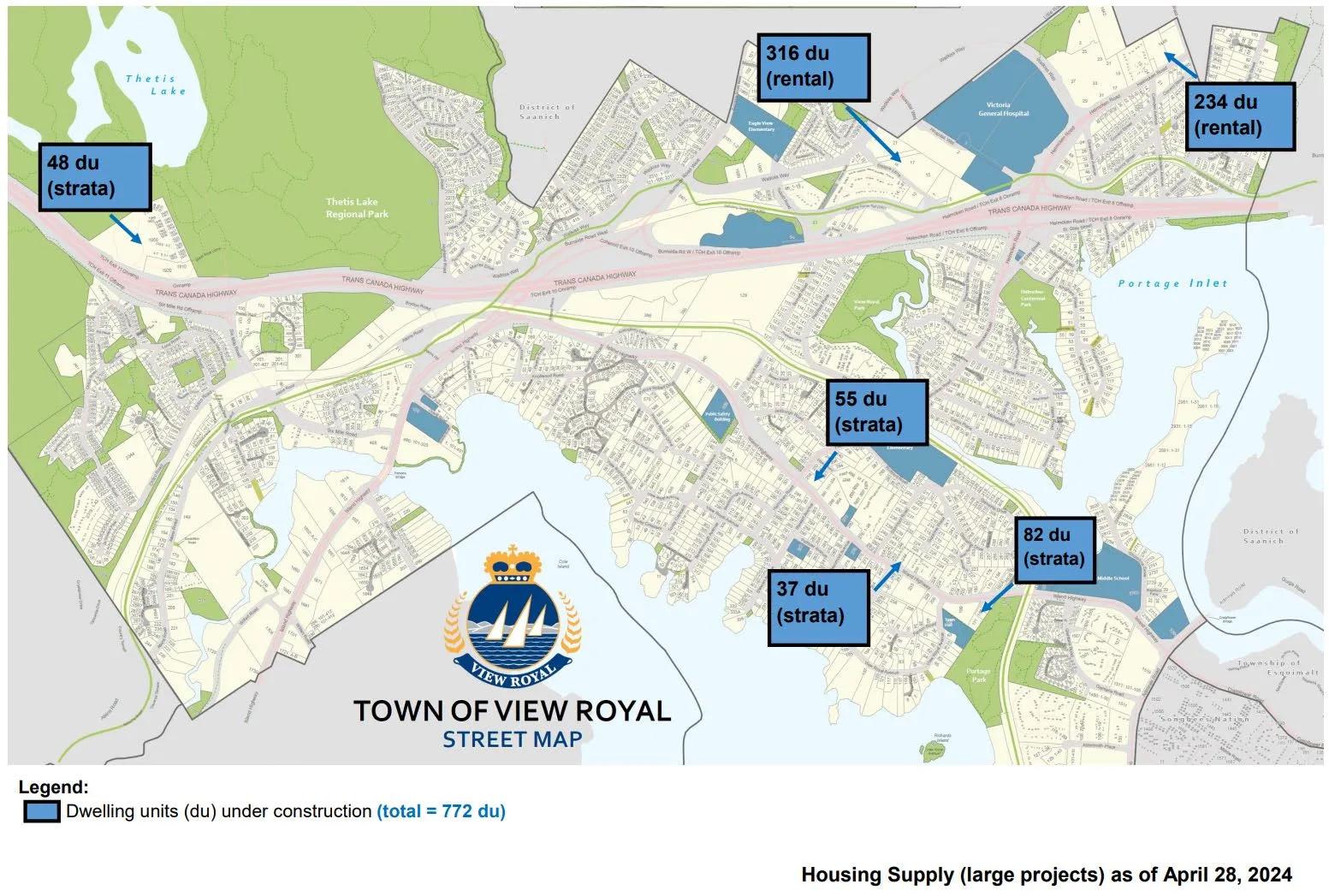

Map identifying total number of dwelling units under construction in View Royal as of April 28, 2024
Map identifying total number of dwelling units under construction in View Royal as of April 28, 2024

Table 1 below provides a summary of each large residential development that is either under construction; or development permit approved by Council, but a building permit has not been received or issued yet.

Table 1. Summary of large developments

Number Address Photo Project Details
1 244 Island Hwy (Skyview)

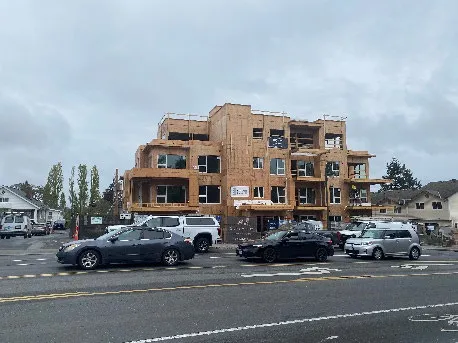

Construction photo of the multi-unit residential building at 244 Island Hwy
Construction photo of the multi-unit residential building at 244 Island Hwy
Zoning: RM-3, Mixed Residential
Use: multi-unit residential
Total number of units: 37 du (strata)
Number of Unit Types: 1 bdr – 21; 2 bdr - 16
Affordable/Accessible Units: none
Building Permit (BP) Issued: BP issued on April 18, 2021 for 37 units
Construction Period: 2yrs
Construction Status: In progress
2 258 Helmcken Rd (Royalle)

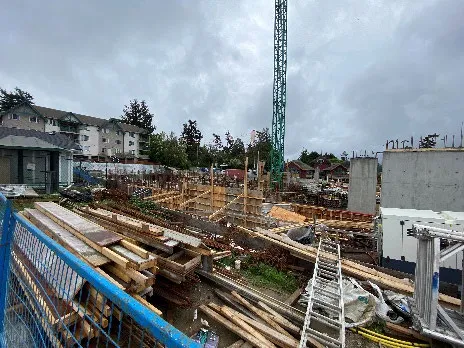

Construction site photo showing foundations and crane at 258 Helmcken Rd
Construction site photo showing foundations and crane at 258 Helmcken Rd
Zoning: CD-26 Zone, Island Highway/Helmcken Comprehensive Development
Use: mixed-use (commercial- residential) building
Total Number of Units: 55 du (strata)
Number of Unit Types: 1 bdr – 19; 2 bdr – 35; 3 bdr - 1
Affordable/Accessible Units: none
Building Permit (BP) Issued: BP issued on December 9, 2022 for 55 units
Construction Period: 2 yrs
Construction Status: In progress
3 15, 17, 21 and 23 Erskine Lane (The Blueprint)

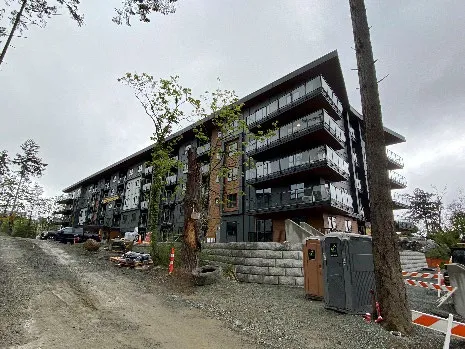

15 Erskine Lane (D) building under construction
15 Erskine Lane (D) building under construction

17 Erskine Lane (C) building under construction
17 Erskine Lane (C) building under construction

21 Erskine Lane (B) building under construction
21 Erskine Lane (B) building under construction

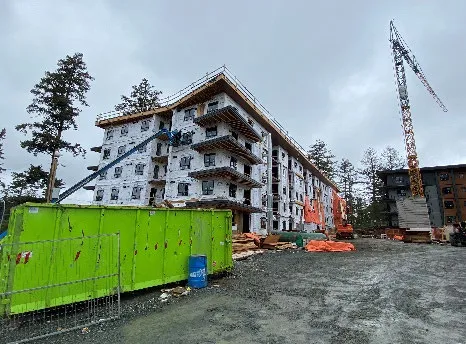

23 Erskine Lane (A) building under construction
23 Erskine Lane (A) building under construction
Zoning: CD-25 Zone, Erskine Lane Residential
Use: multi-unit residential
Total Number of Units: 316 du (rental)
Number of Unit Types: studio – 8; 1bdr – 148; 2bdr – 120; 3bdr - 40
Affordable/Accessible Units: none
Building Permit (BP) Issued: BP issued for Buildings C and D (15 and 17 Erskine Lane) on July 26, 2022 for 158 units; and BP issued for Building A and B (9 Erskine Lane on July 31, 2023 for 158 units.
Construction Period: 2 years
Construction Status: 4 out of 4 buildings in progress (Building A – 65% complete; Building B – 70% complete; Building C – 80% complete; and Building D – 95% complete)
4 1449 Burnside Rd W (Aspire)

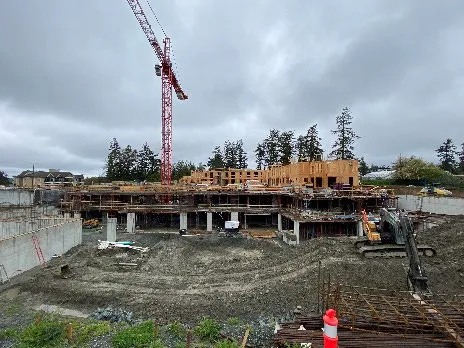

Construction site photo with crane at 1449 Burnside Rd W
Construction site photo with crane at 1449 Burnside Rd W
Zoning: CD-24 Zone, Burnside Helmcken Centennial
Use: multi-unit residential
Total Number of Units: 234 du (rental)
Number of Unit Types: 1bdr – 76; 2bdr – 132; 3bdr - 26
Affordable/Accessible Units: none
Building Permit (BP) Issued: BP issued for both buildings on September 27, 2023, for 234 dwelling units
Construction Period: 2 years
Construction Status: in progress
5 181 Island Hwy (Portage Park)

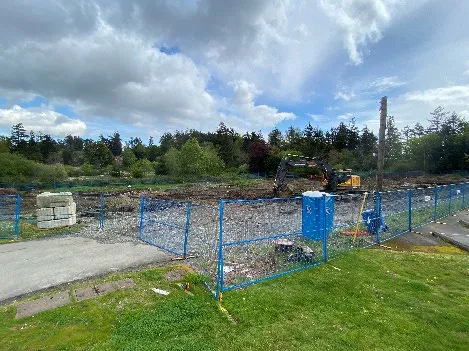

Photo of the development site at 181 Island Hwy
Photo of the development site at 181 Island Hwy
Zoning: CD-27: Comprehensive Development (Island Highway – Portage)
Use: multi-unit residential
Total Number of Units: approx. 82 du (strata)
Number of Unit Types: 1bdr – 63; 2bdr - 16; 3bdr – 3
Building Permit (BP) Status: BP issued on April 9, 2024, for 82 units
Construction Status: in progress
6 2000 West Park Lane (West Park 1)

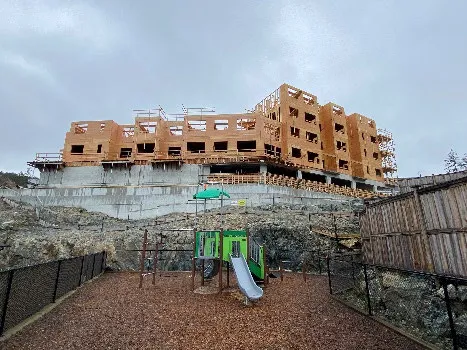

Construction photo of the residential building at 2000 West Park Lane
Construction photo of the residential building at 2000 West Park Lane
Zoning: CD-23: Comprehensive Development (Thetis Lake)
Use: multi-unit residential
Total Number of Units: 48 du (strata)
Number of Unit Types: 1bdr – 25; 2br - 23
Affordable/Accessible Units: none
Building Permit (BP) Status: BP issued on July 6, 2023 for 48 units
Construction Status: in progress
7 7 Erskine Lane
Architectural rendering of the proposed multi-unit residential building at 7 Erskine Lane
Architectural rendering of the proposed multi-unit residential building at 7 Erskine Lane
Zoning: RM-3, Mixed Residential
Use: multi-unit residential
Total Number of Units: 79 du (rental)
Number of Unit Types: 1bdr – 42; 2br – 35; 3br - 2
Affordable/Accessible Units: none
Building Permit (BP) Status: BP received on November 1, 2023. Currently under review.
Construction Status: not in progress

CONCLUSION:

There are a total of six large projects that are currently under construction and on large project with an approved development permit; however, building permit is currently under review. Each category can be summarized as follows:

  • six large residential developments currently under construction will deliver 772 new dwelling units, including 550 rental units and 222 strata units, within the next two years.
  • one large residential development is currently under review for a building permit. When this building permit is approved, it will deliver another 79 rental dwelling units.

To conclude, staff recommend that Council receive this report for information.

CONCURRENCE: Initials Comments
Chief Administrative Officer SS I concur with the recommendation.
REVIEWED BY: Initials
Director of Corporate Administration n/a
Director of Finance n/a
Director of Development Services LT
