This site is in beta — data may be incomplete and features are still being added.
Council Meeting/Documents/Policing Facilities Expansion Project Presentation
Presentation

Policing Facilities Expansion Project Presentation

January 17, 2023Pages 96–12510 sections

A slide deck presentation summarizing the background, requirements, and recommendations of the Policing Facilities Expansion Project.

8.1.d) Policing Facilities Expansion Project
Benchmarks future space against Kelowna facilityBuilding to 2045 population estimates (167,301 total served)Estimated capital cost: $82.4M (+/- 25%)

Policing Facilities Expansion Project

Page 96–125

Background

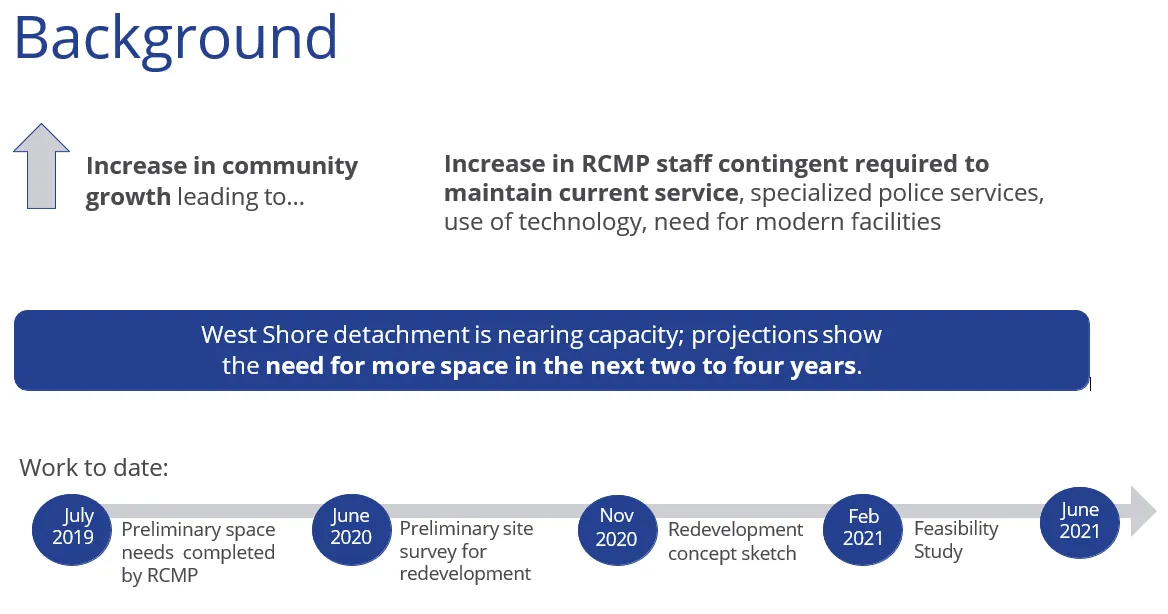

Background slide with community growth text and "Work to date" timeline
Background slide with community growth text and "Work to date" timeline
  • Increase in community growth leading to...
  • Increase in RCMP staff contingent required to maintain current service, specialized police services, use of technology, need for modern facilities

West Shore detachment is nearing capacity; projections show the need for more space in the next two to four years.

Work to date:

  • July 2019: Preliminary space needs completed by RCMP
  • June 2020: Preliminary site survey for redevelopment
  • Nov 2020: Redevelopment concept sketch
  • Feb 2021: Feasibility Study
  • June 2021: (End of timeline bar)
Page 96–125

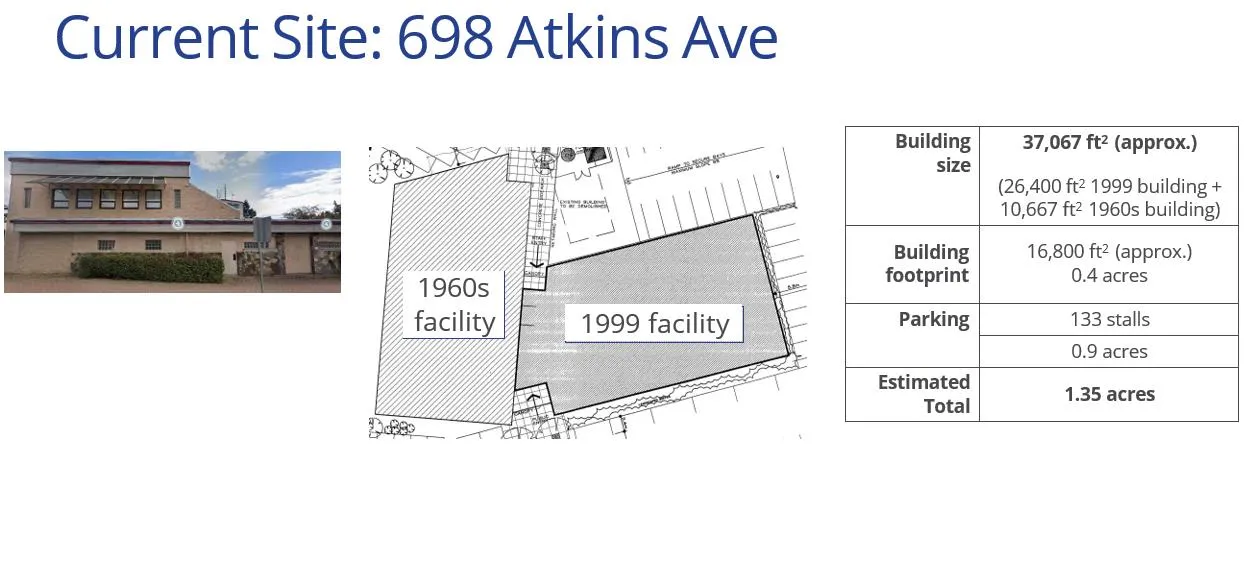

Current Site: 698 Atkins Ave

Current Site details for 698 Atkins Ave including building photo, site plan, and specifications table
Current Site details for 698 Atkins Ave including building photo, site plan, and specifications table
Category Details
Building size 37,067 ft² (approx.)
(26,400 ft² 1999 building + 10,667 ft² 1960s building)
Building footprint 16,800 ft² (approx.)
0.4 acres
Parking 133 stalls
0.9 acres
Estimated Total 1.35 acres
Page 96–125

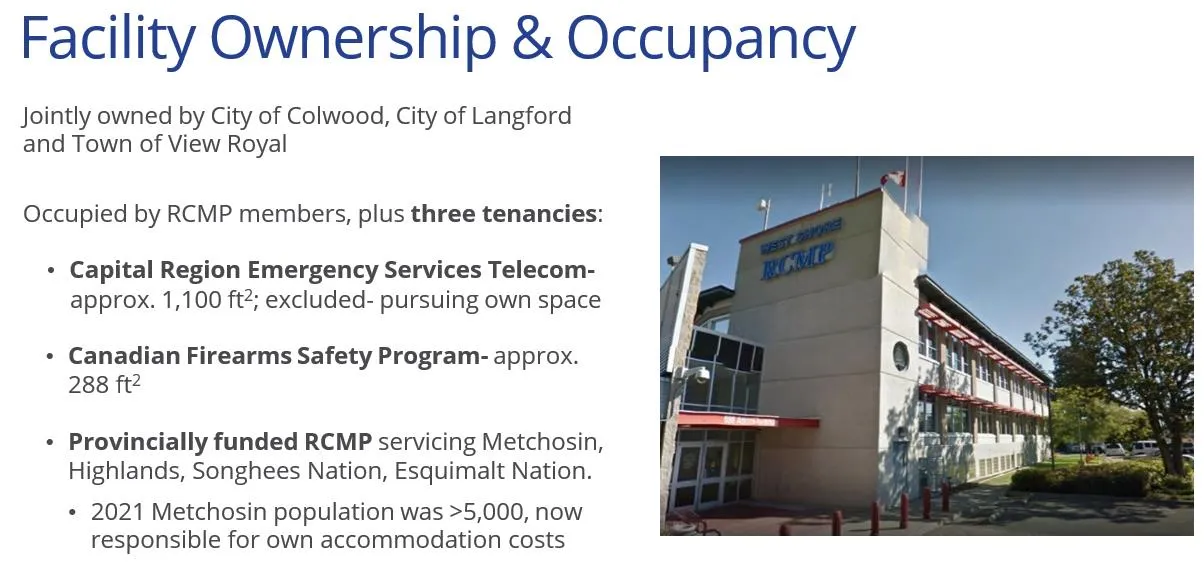

Facility Ownership & Occupancy

Facility Ownership & Occupancy details with a building photo and tenancy list
Facility Ownership & Occupancy details with a building photo and tenancy list

Jointly owned by City of Colwood, City of Langford and Town of View Royal

Occupied by RCMP members, plus three tenancies:

  • Capital Region Emergency Services Telecom- approx. 1,100 ft²; excluded- pursuing own space
  • Canadian Firearms Safety Program- approx. 288 ft²
  • Provincially funded RCMP servicing Metchosin, Highlands, Songhees Nation, Esquimalt Nation.
    • 2021 Metchosin population was >5,000, now responsible for own accommodation costs
Page 96–125

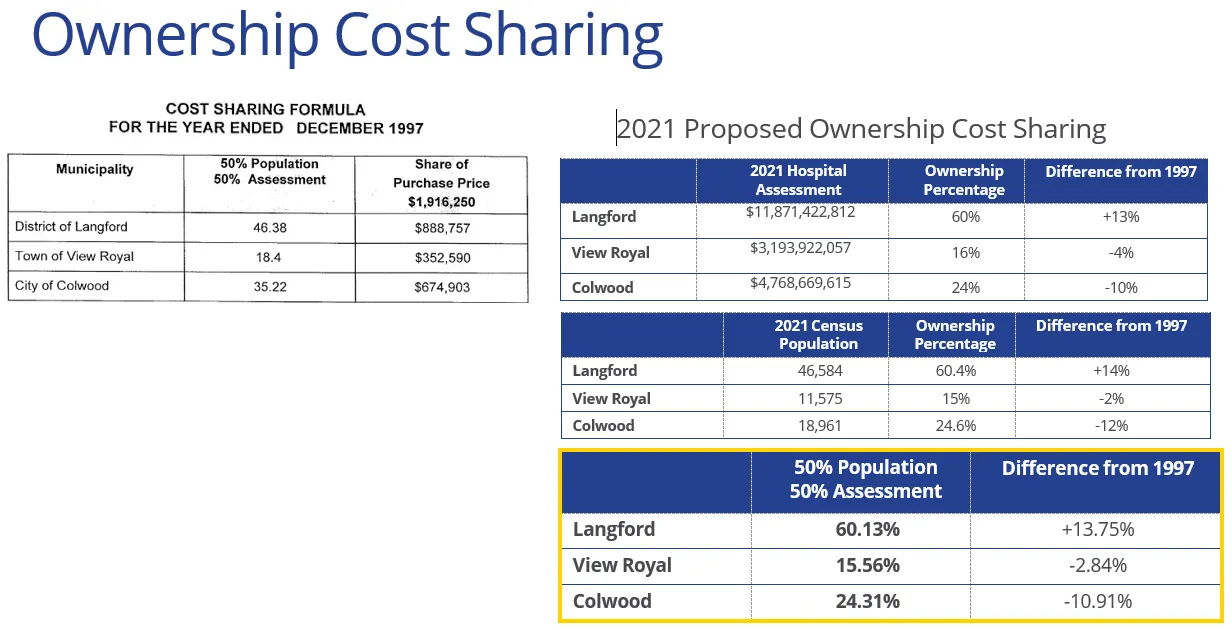

Ownership Cost Sharing

Ownership Cost Sharing tables comparing 1997 and 2021 formulas
Ownership Cost Sharing tables comparing 1997 and 2021 formulas

COST SHARING FORMULA FOR THE YEAR ENDED DECEMBER 1997

Municipality 50% Population 50% Assessment Share of Purchase Price $1,916,250
District of Langford 46.38 $888,757
Town of View Royal 18.4 $352,590
City of Colwood 35.22 $674,903

2021 Proposed Ownership Cost Sharing

Municipality 2021 Hospital Assessment Ownership Percentage Difference from 1997
Langford $11,871,422,812 60% +13%
View Royal $3,193,922,057 16% -4%
Colwood $4,768,669,615 24% -10%
Municipality 2021 Census Population Ownership Percentage Difference from 1997
Langford 46,584 60.4% +14%
View Royal 11,575 15% -2%
Colwood 18,961 24.6% -12%

Summary: 2021 Proposed Ownership Cost Sharing

Municipality 50% Population 50% Assessment Difference from 1997
Langford 60.13% +13.75%
View Royal 15.56% -2.84%
Colwood 24.31% -10.91%
Page 96–125

Future Requirements

How much space do we need?

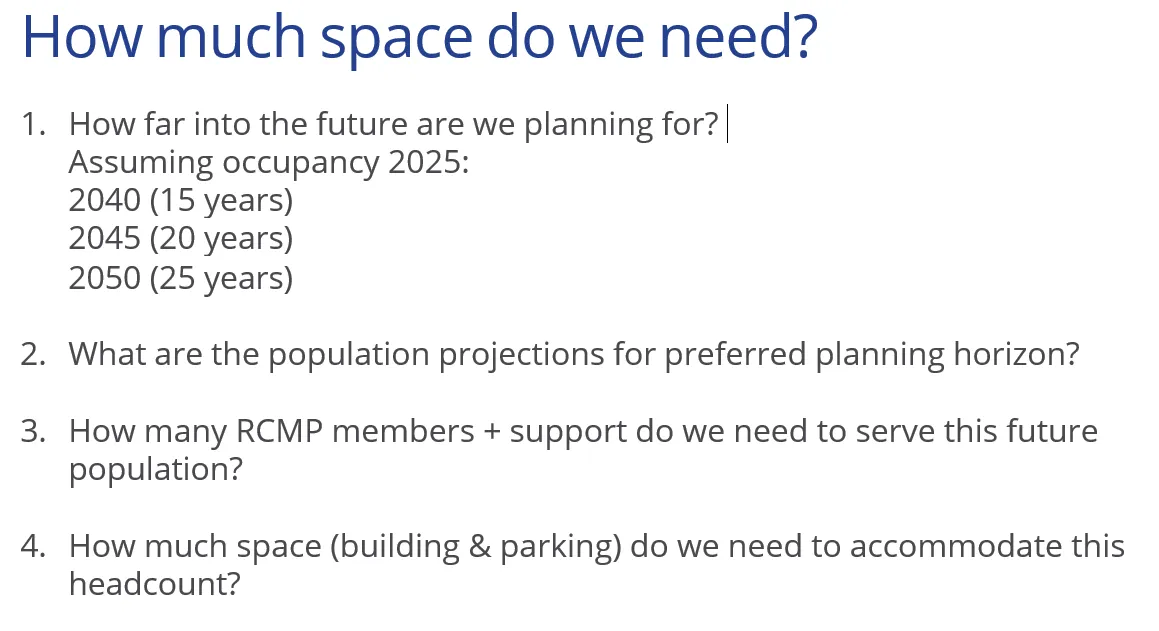

List of planning questions for determining future space needs
List of planning questions for determining future space needs
  1. How far into the future are we planning for? Assuming occupancy 2025: 2040 (15 years) 2045 (20 years) 2050 (25 years)
  2. What are the population projections for preferred planning horizon?
  3. How many RCMP members + support do we need to serve this future population?
  4. How much space (building & parking) do we need to accommodate this headcount?

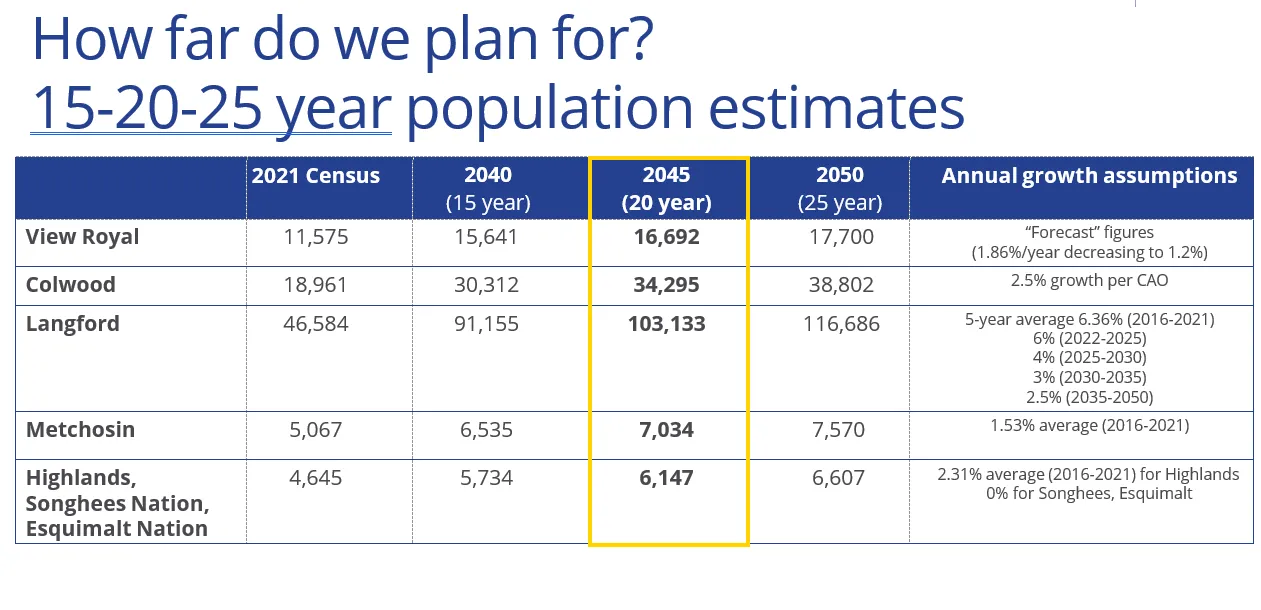

How far do we plan for? 15-20-25 year population estimates

Table showing 15-20-25 year population estimates and growth assumptions
Table showing 15-20-25 year population estimates and growth assumptions
2021 Census 2040 (15 year) 2045 (20 year) 2050 (25 year) Annual growth assumptions
View Royal 11,575 15,641 16,692 17,700 "Forecast" figures (1.86%/year decreasing to 1.2%)
Colwood 18,961 30,312 34,295 38,802 2.5% growth per CAO
Langford 46,584 91,155 103,133 116,686 5-year average 6.36% (2016-2021); 6% (2022-2025); 4% (2025-2030); 3% (2030-2035); 2.5% (2035-2050)
Metchosin 5,067 6,535 7,034 7,570 1.53% average (2016-2021)
Highlands, Songhees Nation, Esquimalt Nation 4,645 5,734 6,147 6,607 2.31% average (2016-2021) for Highlands; 0% for Songhees, Esquimalt

How many RCMP to serve 2045 population?

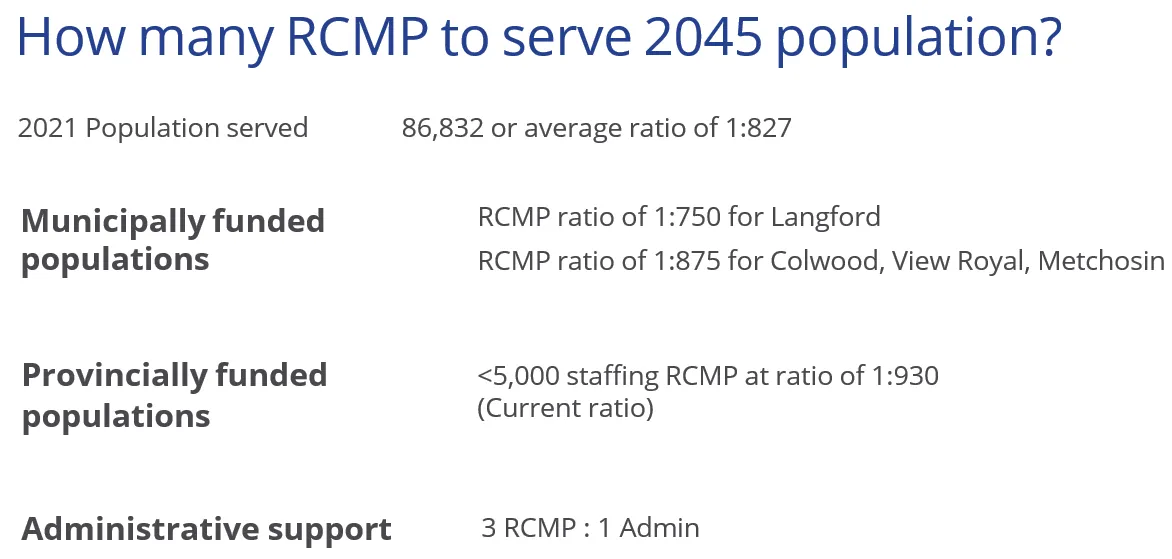

Breakdown of RCMP ratios for serving different populations
Breakdown of RCMP ratios for serving different populations

2021 Population served: 86,832 or average ratio of 1:827

  • Municipally funded populations:
    • RCMP ratio of 1:750 for Langford
    • RCMP ratio of 1:875 for Colwood, View Royal, Metchosin
  • Provincially funded populations:
    • <5,000 staffing RCMP at ratio of 1:930 (Current ratio)
  • Administrative support:
    • 3 RCMP : 1 Admin

RCMP headcount for 20-year (2045) population

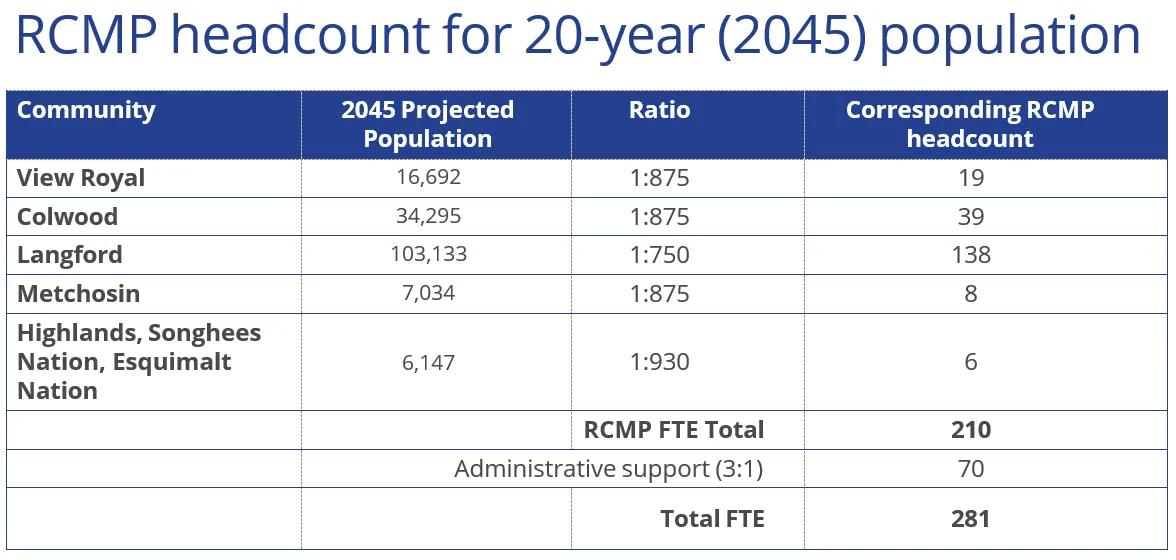

Table calculating RCMP headcount for the 2045 population
Table calculating RCMP headcount for the 2045 population
Community 2045 Projected Population Ratio Corresponding RCMP headcount
View Royal 16,692 1:875 19
Colwood 34,295 1:875 39
Langford 103,133 1:750 138
Metchosin 7,034 1:875 8
Highlands, Songhees Nation, Esquimalt Nation 6,147 1:930 6
RCMP FTE Total 210
Administrative support (3:1) 70
Total FTE 281

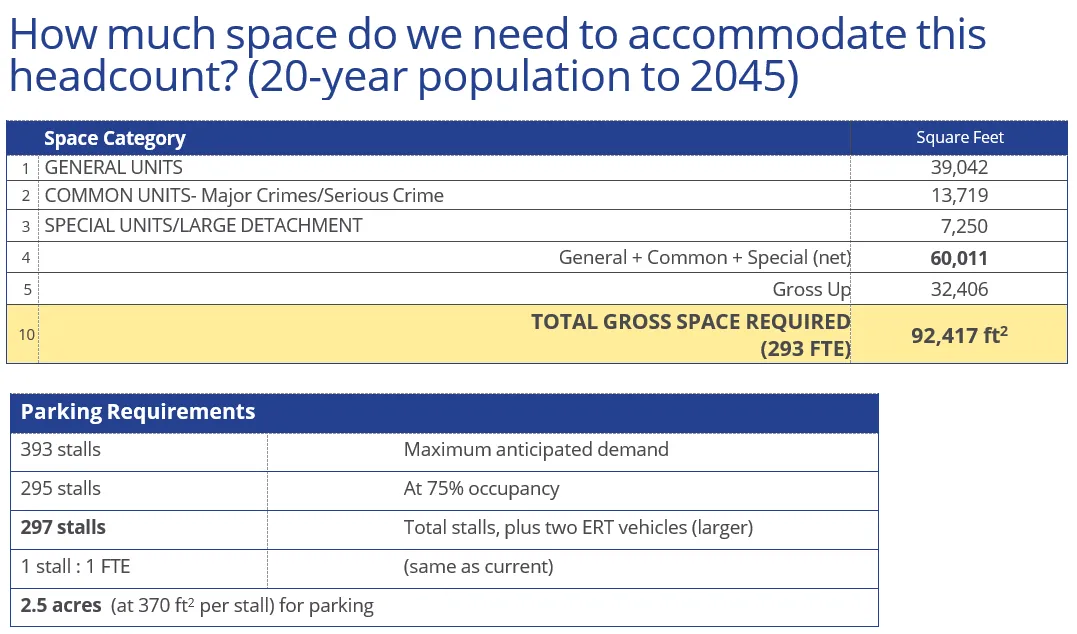

How much space do we need to accommodate this headcount? (20-year population to 2045)

Space and parking requirement tables for the 20-year population
Space and parking requirement tables for the 20-year population
Space Category Square Feet
1 GENERAL UNITS 39,042
2 COMMON UNITS - Major Crimes/Serious Crime 13,719
3 SPECIAL UNITS/LARGE DETACHMENT 7,250
4 General + Common + Special (net) 60,011
5 Gross Up 32,406
10 TOTAL GROSS SPACE REQUIRED (293 FTE) 92,417 ft²

Parking Requirements

393 stalls Maximum anticipated demand
295 stalls At 75% occupancy
297 stalls Total stalls, plus two ERT vehicles (larger)
1 stall : 1 FTE (same as current)
2.5 acres (at 370 ft² per stall) for parking

Benchmarking future space requirements

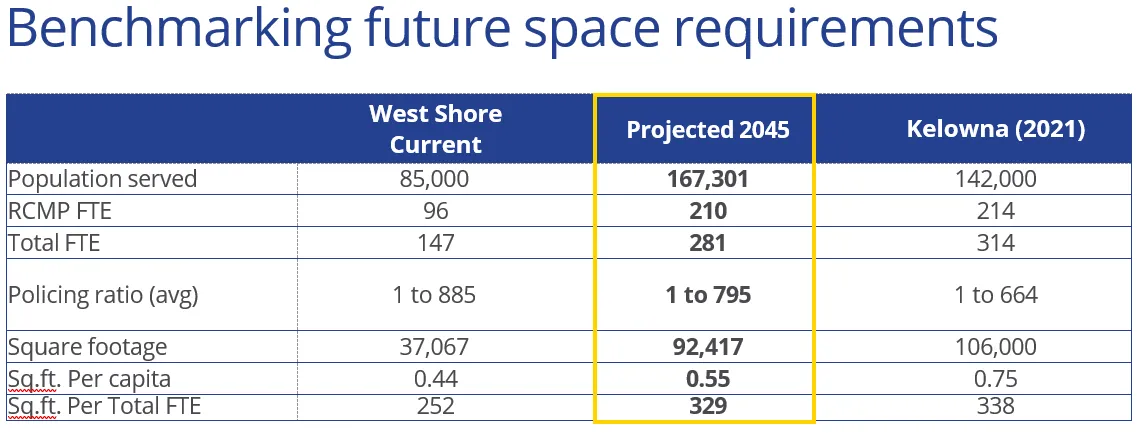

Table benchmarking future space requirements against current and Kelowna (2021)
Table benchmarking future space requirements against current and Kelowna (2021)
West Shore Current Projected 2045 Kelowna (2021)
Population served 85,000 167,301 142,000
RCMP FTE 96 210 214
Total FTE 147 281 314
Policing ratio (avg) 1 to 885 1 to 795 1 to 664
Square footage 37,067 92,417 106,000
Sq.ft. Per capita 0.44 0.55 0.75
Sq.ft. Per Total FTE 252 329 338

Summary Future Requirements to 2045

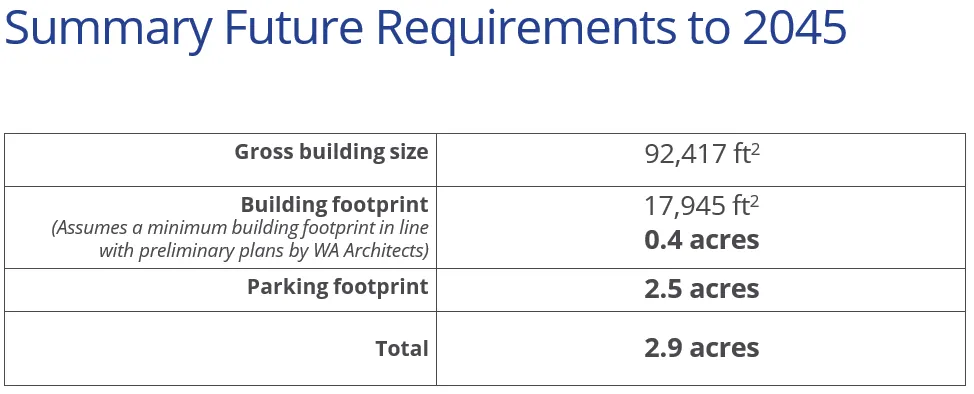

Summary table of future requirements to 2045 including building and parking footprints
Summary table of future requirements to 2045 including building and parking footprints
Gross building size 92,417 ft²
Building footprint
(Assumes a minimum building footprint in line with preliminary plans by WA Architects)
17,945 ft²
0.4 acres
Parking footprint 2.5 acres
Total 2.9 acres
Page 96–125

Site Options

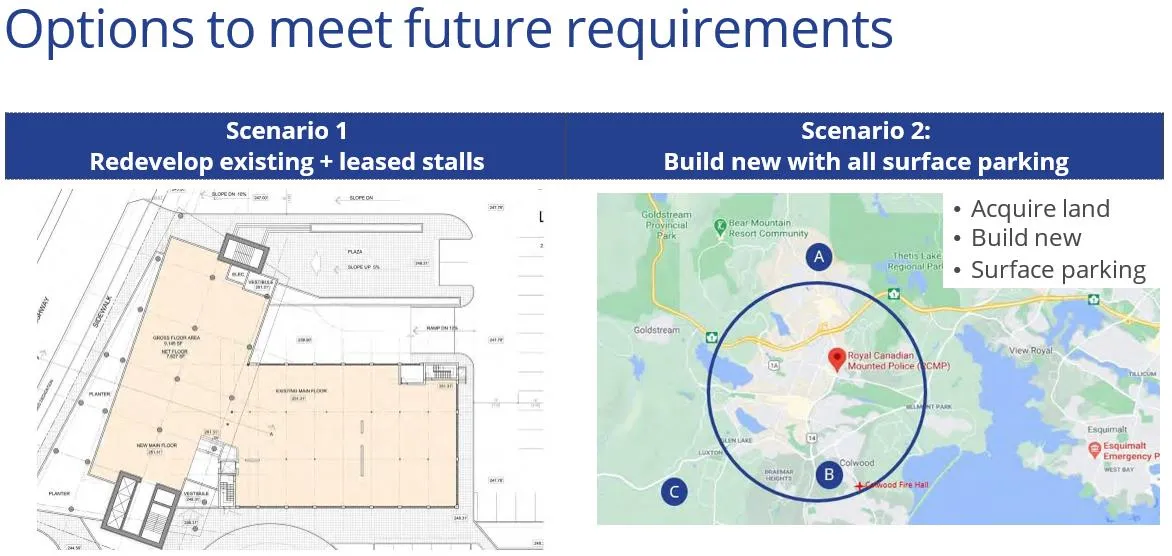

Options to meet future requirements

Comparison map and diagrams for Scenario 1 (Redevelop) vs Scenario 2 (Build new)
Comparison map and diagrams for Scenario 1 (Redevelop) vs Scenario 2 (Build new)
  • Scenario 1: Redevelop existing + leased stalls
  • Scenario 2: Build new with all surface parking
    • Acquire land
    • Build new
    • Surface parking

Scenario 1: Redevelop existing

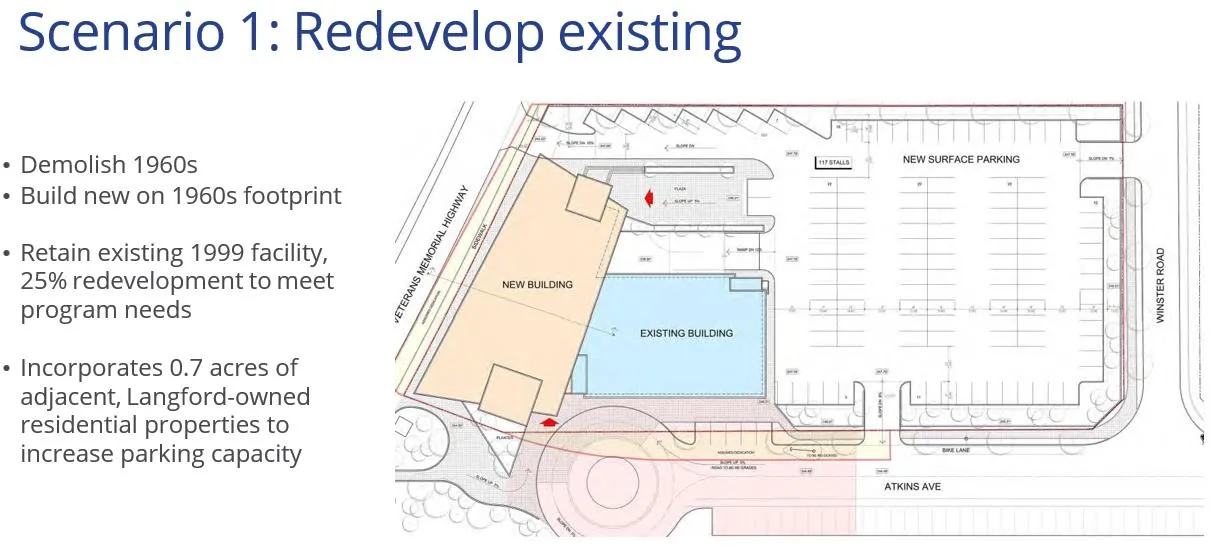

Site plan for Scenario 1: Redevelop existing
Site plan for Scenario 1: Redevelop existing
  • Demolish 1960s
  • Build new on 1960s footprint
  • Retain existing 1999 facility, 25% redevelopment to meet program needs
  • Incorporates 0.7 acres of adjacent, Langford-owned residential properties to increase parking capacity

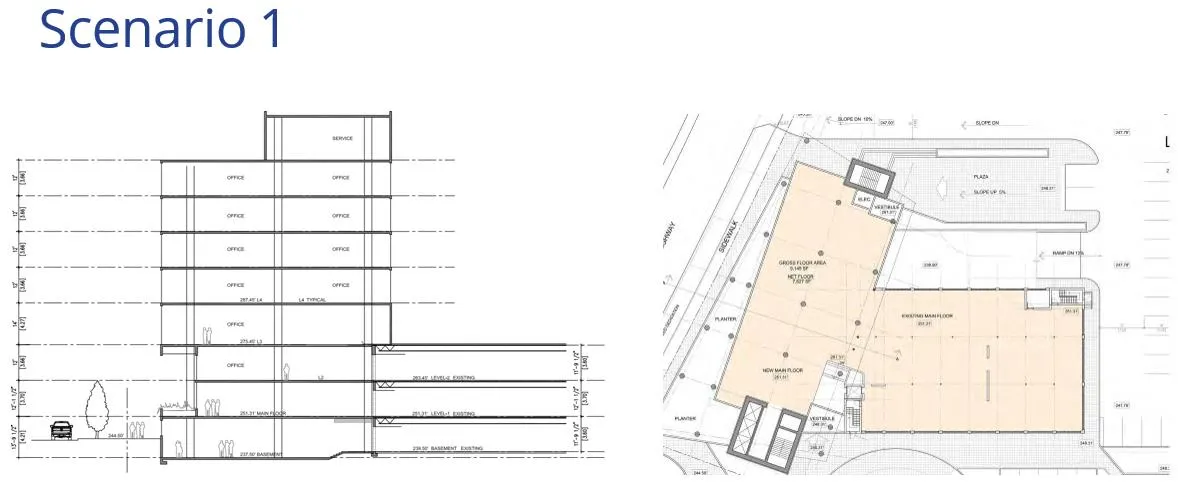

Architectural elevation and floor plan diagrams for Scenario 1
Architectural elevation and floor plan diagrams for Scenario 1

Scenario 1: Future parking requirements

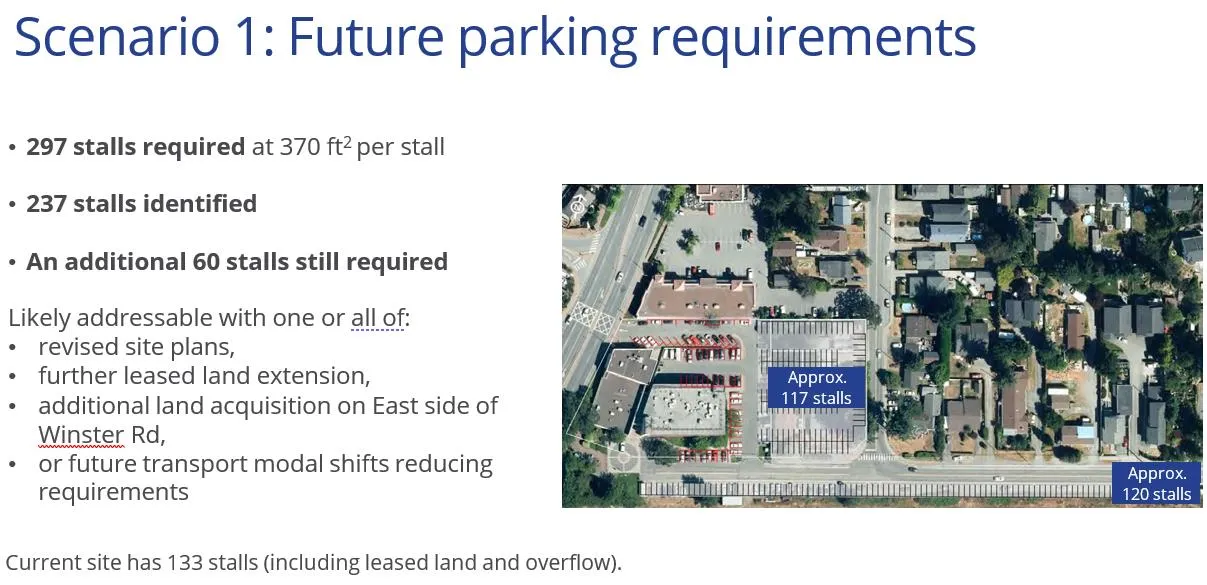

Aerial map showing future parking requirements for Scenario 1
Aerial map showing future parking requirements for Scenario 1
  • 297 stalls required at 370 ft² per stall
  • 237 stalls identified
  • An additional 60 stalls still required

Likely addressable with one or all of:

  • revised site plans,
  • further leased land extension,
  • additional land acquisition on East side of Winster Rd,
  • or future transport modal shifts reducing requirements

Current site has 133 stalls (including leased land and overflow).

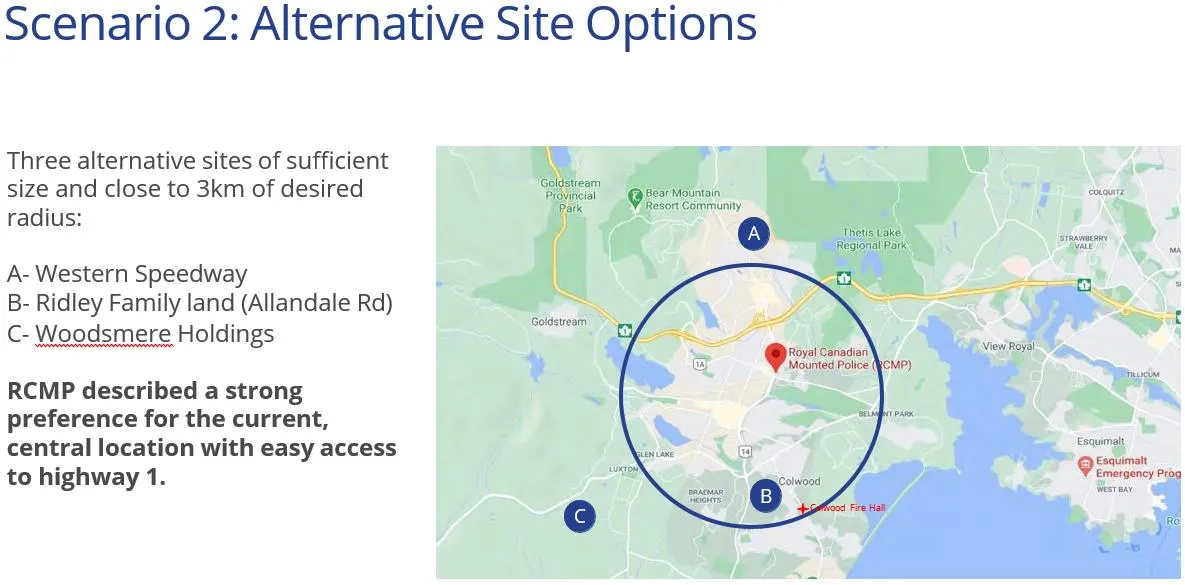

Scenario 2: Alternative Site Options

Map showing alternative site options (A, B, C) for Scenario 2
Map showing alternative site options (A, B, C) for Scenario 2

Three alternative sites of sufficient size and close to 3km of desired radius:

  • A- Western Speedway
  • B- Ridley Family land (Allandale Rd)
  • C- Woodsmere Holdings

RCMP described a strong preference for the current, central location with easy access to highway 1.

Page 96–125

Options Evaluation

Capital Costs

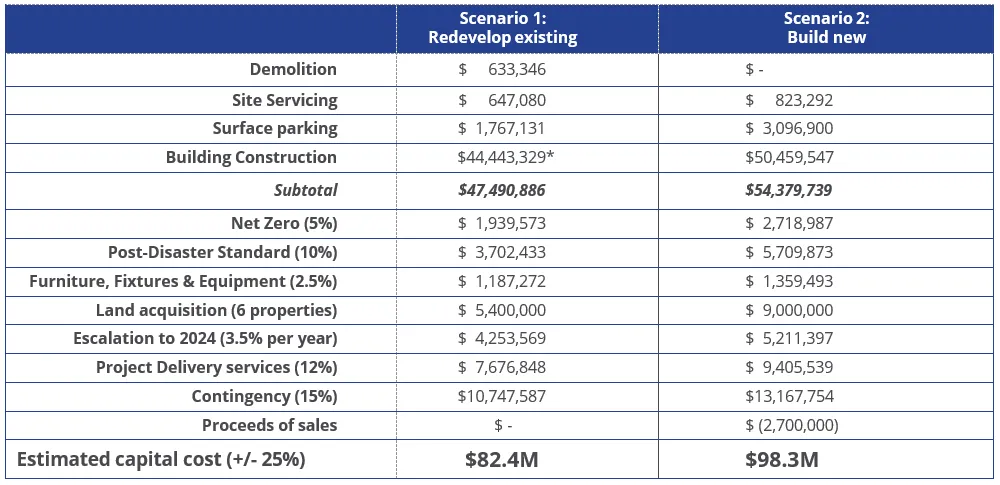

Table comparing estimated capital costs for building to 2045 under Scenario 1 and 2
Table comparing estimated capital costs for building to 2045 under Scenario 1 and 2

Estimated capital costs: building to 2045

Category Scenario 1: Redevelop existing Scenario 2: Build new
Demolition $ 633,346 $ -
Site Servicing $ 647,080 $ 823,292
Surface parking $ 1,767,131 $ 3,096,900
Building Construction $44,443,329* $50,459,547
Subtotal $47,490,886 $54,379,739
Net Zero (5%) $ 1,939,573 $ 2,718,987
Post-Disaster Standard (10%) $ 3,702,433 $ 5,709,873
Furniture, Fixtures & Equipment (2.5%) $ 1,187,272 $ 1,359,493
Land acquisition (6 properties) $ 5,400,000 $ 9,000,000
Escalation to 2024 (3.5% per year) $ 4,253,569 $ 5,211,397
Project Delivery services (12%) $ 7,676,848 $ 9,405,539
Contingency (15%) $10,747,587 $13,167,754
Proceeds of sales $ - $ (2,700,000)
Estimated capital cost (+/- 25%) $82.4M $98.3M

*includes $6M in seismic upgrading costs added to the 1999 facility in Scenario 1 to enable useful life beyond 2045

Whole Life Costs

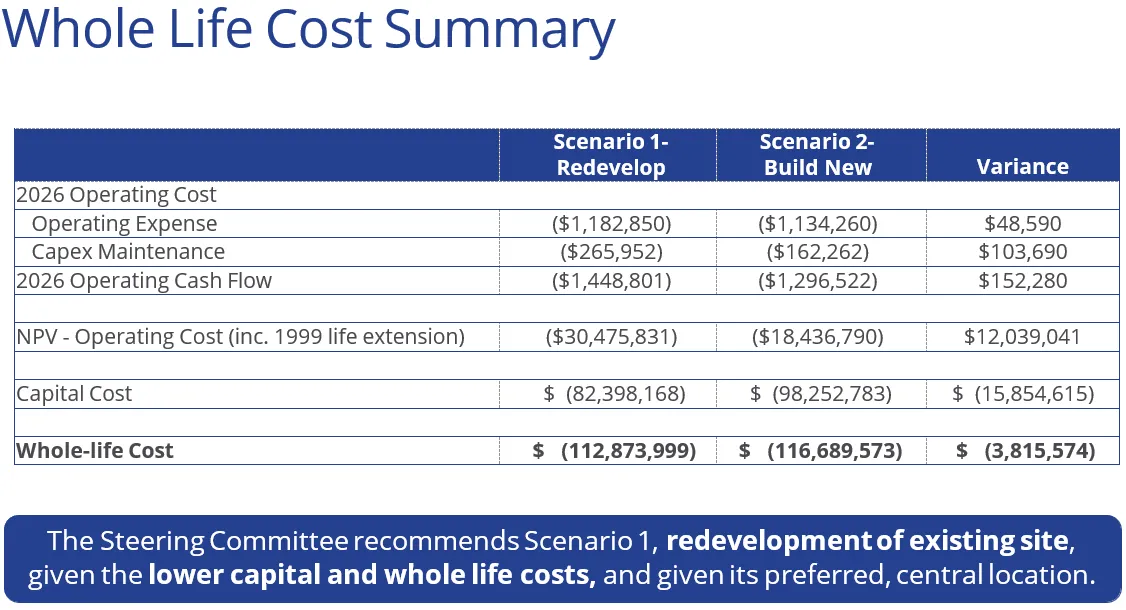

Whole Life Cost Summary table comparing scenarios
Whole Life Cost Summary table comparing scenarios

Whole Life Cost Summary

Category Scenario 1 - Redevelop Scenario 2 - Build New Variance
2026 Operating Cost
Operating Expense ($1,182,850) ($1,134,260) $48,590
Capex Maintenance ($265,952) ($162,262) $103,690
2026 Operating Cash Flow ($1,448,801) ($1,296,522) $152,280
NPV - Operating Cost (inc. 1999 life extension) ($30,475,831) ($18,436,790) $12,039,041
Capital Cost $ (82,398,168) $ (98,252,783) $ (15,854,615)
Whole-life Cost $ (112,873,999) $ (116,689,573) $ (3,815,574)

Steering Committee Recommendation:

The Steering Committee recommends Scenario 1, redevelopment of existing site, given the lower capital and whole life costs, and given its preferred, central location.

Do we build 15, 20, or 25 year requirements?

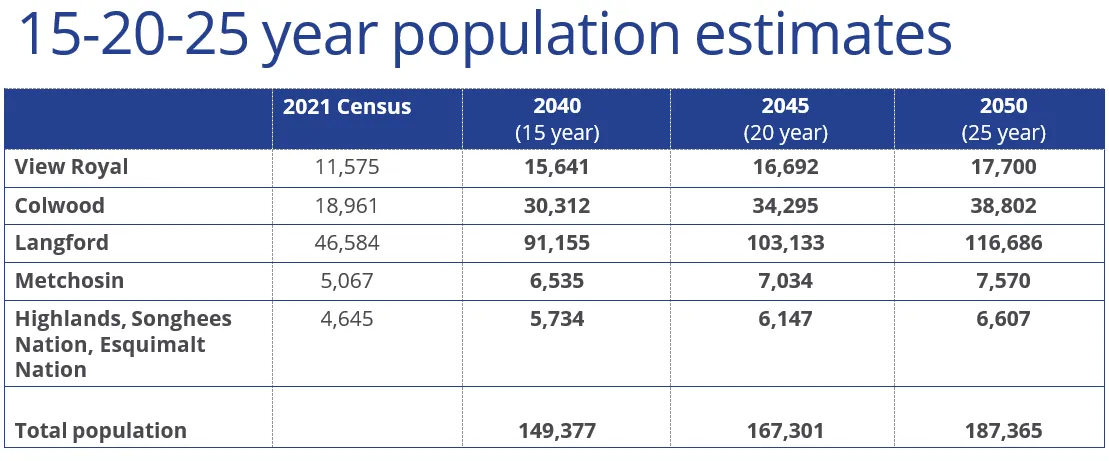

Population estimates table for 15, 20, and 25-year planning horizons
Population estimates table for 15, 20, and 25-year planning horizons

15-20-25 year population estimates

2021 Census 2040 (15 year) 2045 (20 year) 2050 (25 year)
View Royal 11,575 15,641 16,692 17,700
Colwood 18,961 30,312 34,295 38,802
Langford 46,584 91,155 103,133 116,686
Metchosin 5,067 6,535 7,034 7,570
Highlands, Songhees Nation, Esquimalt Nation 4,645 5,734 6,147 6,607
Total population 149,377 167,301 187,365
Table comparing facility sizes and costs for 15, 20, and 25-year horizons

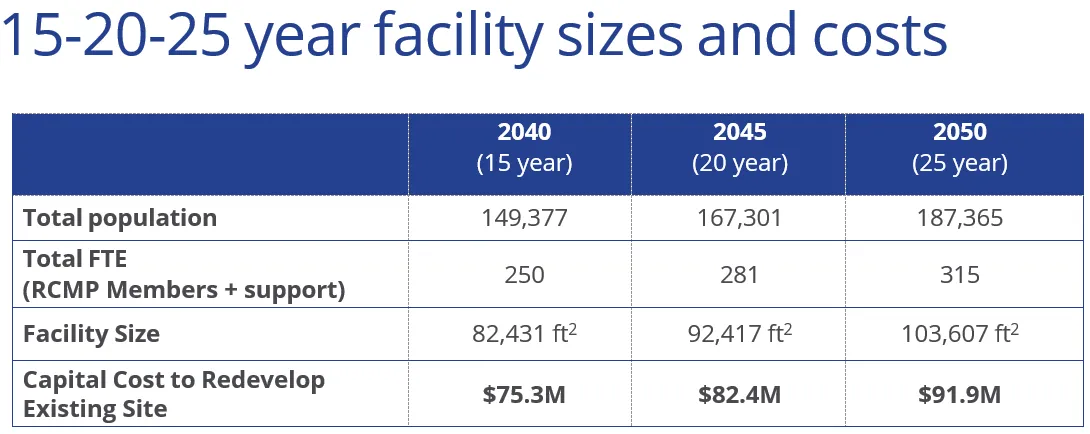

Table comparing facility sizes and costs for 15, 20, and 25-year horizons

15-20-25 year facility sizes and costs

2040 (15 year) 2045 (20 year) 2050 (25 year)
Total population 149,377 167,301 187,365
Total FTE (RCMP Members + support) 250 281 315
Facility Size 82,431 ft² 92,417 ft² 103,607 ft²
Capital Cost to Redevelop Existing Site $75.3M $82.4M $91.9M

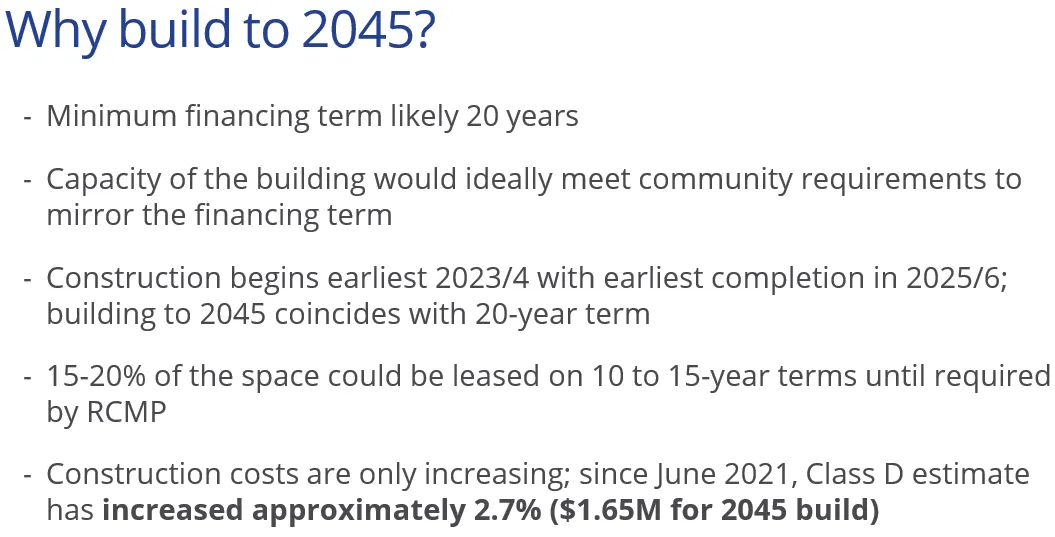

Why build to 2045?

List of reasons for building to meet 2045 requirements
List of reasons for building to meet 2045 requirements
  • Minimum financing term likely 20 years
  • Capacity of the building would ideally meet community requirements to mirror the financing term
  • Construction begins earliest 2023/4 with earliest completion in 2025/6; building to 2045 coincides with 20-year term
  • 15-20% of the space could be leased on 10 to 15-year terms until required by RCMP
  • Construction costs are only increasing; since June 2021, Class D estimate has increased approximately 2.7% ($1.65M for 2045 build)
Page 96–125

Recommendations

Summary recommendations for planning the future West Shore detachment with a cost contribution table
Summary recommendations for planning the future West Shore detachment with a cost contribution table

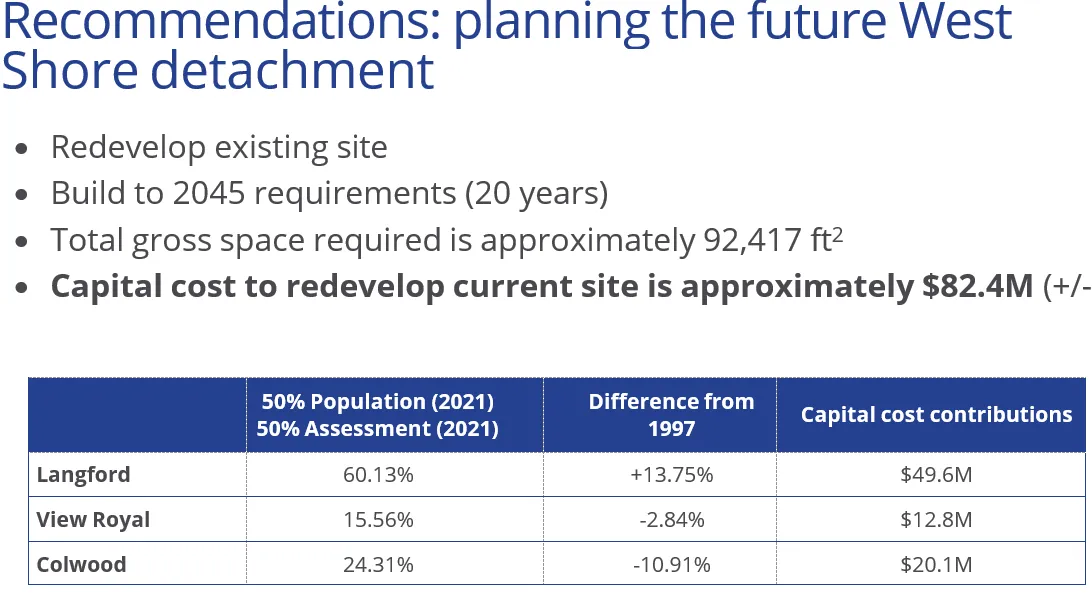

Recommendations: planning the future West Shore detachment

  • Redevelop existing site
  • Build to 2045 requirements (20 years)
  • Total gross space required is approximately 92,417 ft²
  • Capital cost to redevelop current site is approximately $82.4M (+/- 25%)
Municipality 50% Population (2021) 50% Assessment (2021) Difference from 1997 Capital cost contributions
Langford 60.13% +13.75% $49.6M
View Royal 15.56% -2.84% $12.8M
Colwood 24.31% -10.91% $20.1M
Page 96–125

Indicative Timeline & Next Steps

Key Actions Estimated Timing
Procure IPD Advisor (Pre-Validation Readiness Work) By November 2022
Procure IPD Team (Depends on procurement strategy) Complete Owner’s Pre-Validation Preparations March 2023
IPD Team Validation Phase Starts April 2023
Validation Report Submission (Including Owner’s Approval to Proceed) July 2023
Detailed Design & Documentation Phase Starts, followed by Construction Phase (Detailed schedule/planning to be developed by the IPD Team in Validation to align with base Target Cost) August 2023
Construction Substantial Completion (Estimated 24 months following Validation Report approval) August 2025
RCMP Moved in and Operationally Ready Q4 2025
Page 96–125
Extracted from: 2023 01 17 Council Agenda - Agenda - Pdf
