Committee of the Whole/Documents/PROJECTS FINAL UPDATE - 2012 CAPITAL - STATUS TABLE
Appendix

PROJECTS FINAL UPDATE - 2012 CAPITAL - STATUS TABLE

February 13, 2013Page 621 section

A table detailing the status and notes for various 2012 capital projects including roads, drainage, sewer, and parks.

Craigflower Bridge Tenders Close: February 20, 2013Duffus Trail Stairs 95% complete: March 2013Dump Truck 3-ton delivery: June 2013

Report to Committee of the Whole Projects Final Update – Capital 2012

Meeting Date: February 12, 2013

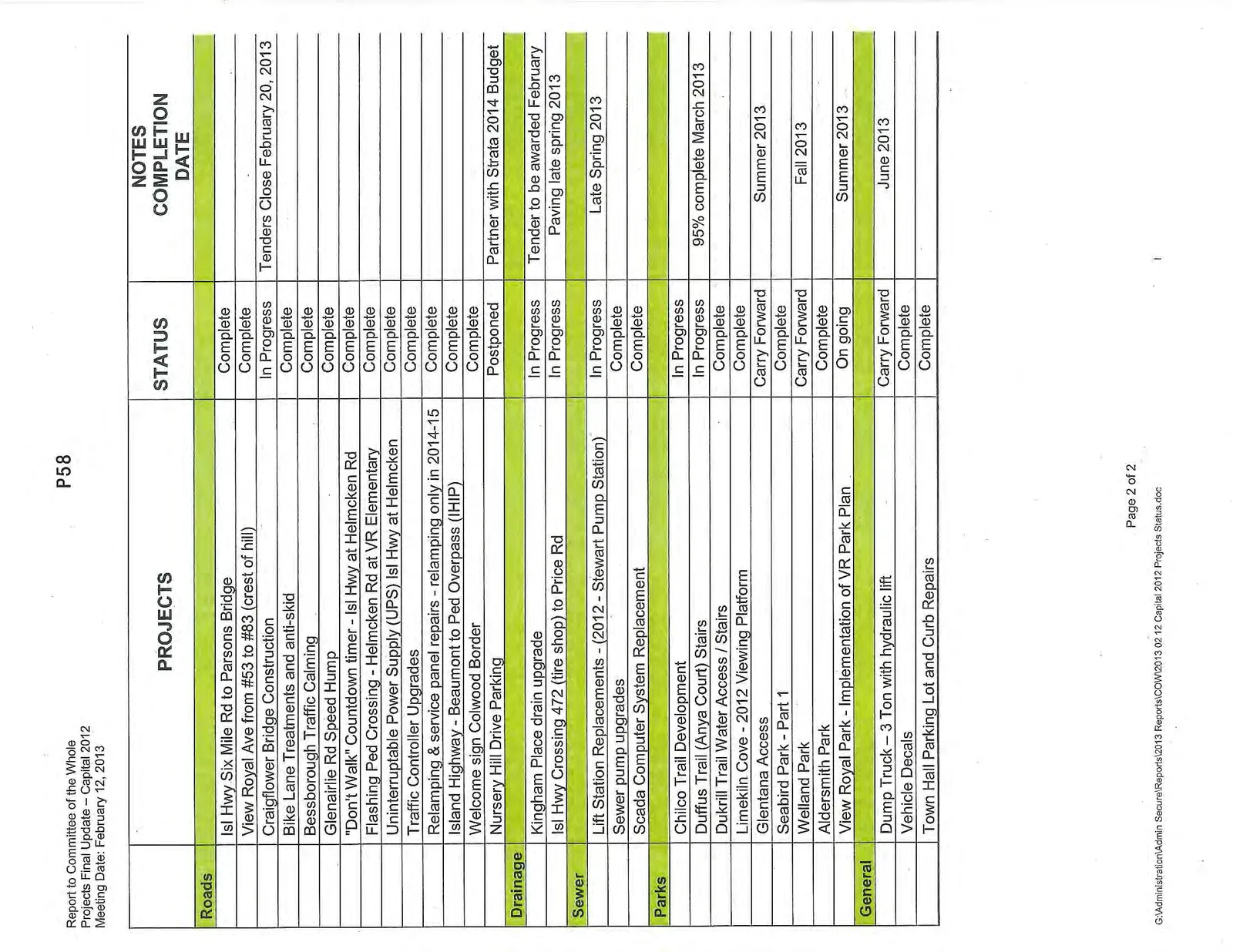

Table of Capital 2012 projects status update across Roads, Drainage, Sewer, Parks, and General categories.
Table of Capital 2012 projects status update across Roads, Drainage, Sewer, Parks, and General categories.

Roads

PROJECTS STATUS NOTES COMPLETION DATE
Isl Hwy Six Mile Rd to Parsons Bridge Complete
View Royal Ave from #53 to #83 (crest of hill) Complete
Craigflower Bridge Construction In Progress Tenders Close February 20, 2013
Bike Lane Treatments and anti-skid Complete
Bessborough Traffic Calming Complete
Glenairlie Rd Speed Hump Complete
"Don't Walk" Countdown timer - Isl Hwy at Helmcken Rd Complete
Flashing Ped Crossing - Helmcken Rd at VR Elementary Complete
Uninterruptable Power Supply (UPS) Isl Hwy at Helmcken Complete
Traffic Controller Upgrades Complete
Relamping & service panel repairs - relamping only in 2014-15 Complete
Island Highway - Beaumont to Ped Overpass (IHIP) Complete
Welcome sign Colwood Border Complete
Nursery Hill Drive Parking Postponed Partner with Strata 2014 Budget

Drainage

PROJECTS STATUS NOTES COMPLETION DATE
Kingham Place drain upgrade In Progress Tender to be awarded February
Isl Hwy Crossing 472 (tire shop) to Price Rd In Progress Paving late spring 2013

Sewer

PROJECTS STATUS NOTES COMPLETION DATE
Lift Station Replacements - (2012 - Stewart Pump Station) In Progress Late Spring 2013
Sewer pump upgrades Complete
Scada Computer System Replacement Complete

Parks

PROJECTS STATUS NOTES COMPLETION DATE
Chilco Trail Development In Progress
Duffus Trail (Anya Court) Stairs In Progress 95% complete March 2013
Dukrill Trail Water Access / Stairs Complete
Limekiln Cove - 2012 Viewing Platform Complete
Glentana Access Carry Forward Summer 2013
Seabird Park - Part 1 Complete
Welland Park Carry Forward Fall 2013
Aldersmith Park Complete
View Royal Park - Implementation of VR Park Plan On going Summer 2013

General

PROJECTS STATUS NOTES COMPLETION DATE
Dump Truck - 3 Ton with hydraulic lift Carry Forward June 2013
Vehicle Decals Complete
Town Hall Parking Lot and Curb Repairs Complete
Page 62
Extracted from: 2013 02 13 Committee of the Whole Agenda
