Staff Report

View Royal Public Safety Building Monthly Report for September 2013

October 8, 2013Pages 52–5710 sections

Construction progress report for the new Public Safety Building, noting status of meetings, contract documents, and field work.

6.1.3 c) Monthly RCMP Report for the month of September 2013
Contract documents signed on October 1, 2013Key tasks: drilling, blasting, and excavationChange Order 004: Old swimming pool unearthed on site

Monthly Report for September 2013

Page 52–57

View Royal Public Safety Building

Town of View Royal

Construction site excavation progress showing exposed rock and heavy equipment, 11 September 2013
Construction site excavation progress showing exposed rock and heavy equipment, 11 September 2013

Date of report: 04 October 2013

PREPARED FOR:

  • Kim Anema, Chief Administrative Officer, Town of View Royal
  • Paul Hurst, Fire Chief, Emergency Program Coordinator, View Royal Fire Rescue

PREPARED BY:

  • Heather Spinney, Architect AIBC, Hughes Condon Marler Architects
Page 52–57

CONTENTS

Section Page
Introduction 3
Status of Project 3
Work Progress 3
Progress Photographs 4-5
Supplemental Instructions 5
Change Orders 5
Appendix A
Schedule

Page 52–57

Introduction

This report summarizes the progress and status of the View Royal Public Safety Building up to the end of the month of September 2013.

Page 52–57

Status of Project

  • 4 Construction Coordination Meetings have been conducted. (meetings are currently scheduled weekly)
  • Contract Documents were signed by Contractor and delivered to Owner on October 1st 2013.
  • 3 sets were distributed as follows:
    • Town of View Royal (Owner)
    • Ledcor Construction Limited (Contractor)
    • Hughes Condon Marler Architects (Contract Administrator)
Page 52–57

Work Progress

Key tasks started, in progress or completed this month include:

  • Site Clearing
  • Drilling & Blasting
  • Excavation

Refer to the following pages for photographs illustrating the current progress of construction.

Page 52–57

Progress Photographs

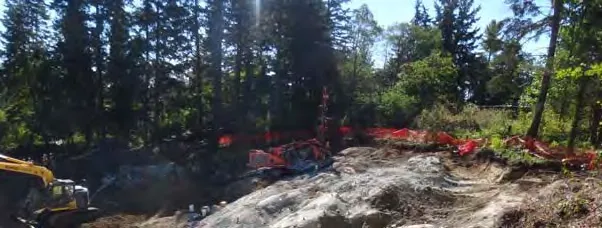

Wide panorama of the construction site during early excavation, 4 September 2013
Wide panorama of the construction site during early excavation, 4 September 2013

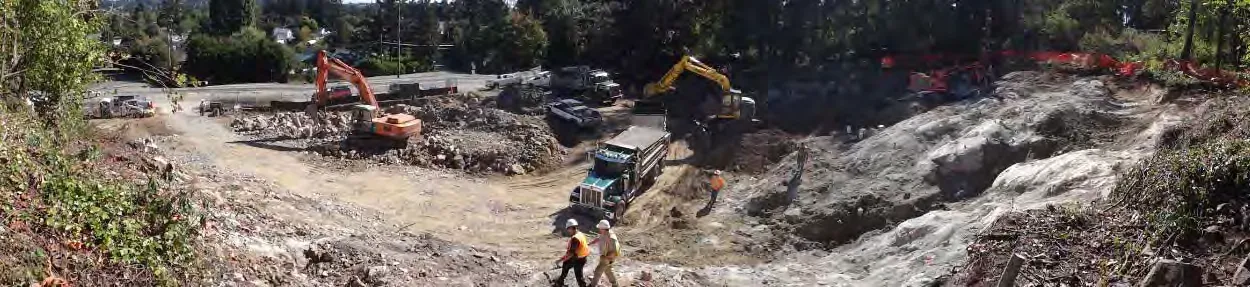

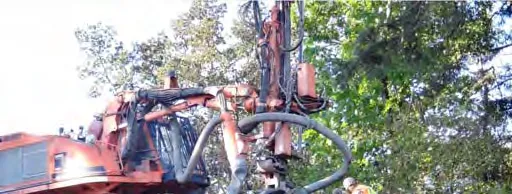

Elevated view of site excavation and equipment, 11 September 2013
Elevated view of site excavation and equipment, 11 September 2013

Close-up of drilling equipment on the rocky construction site, 25 September 2013
Close-up of drilling equipment on the rocky construction site, 25 September 2013

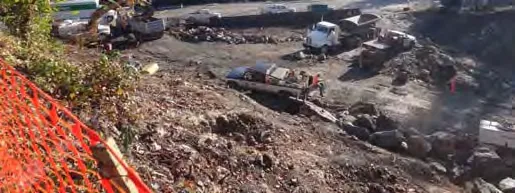

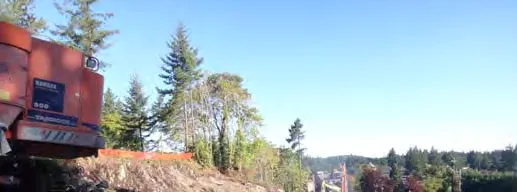

Overview of the excavation area with orange safety fencing in the background, 25 September 2013
Overview of the excavation area with orange safety fencing in the background, 25 September 2013

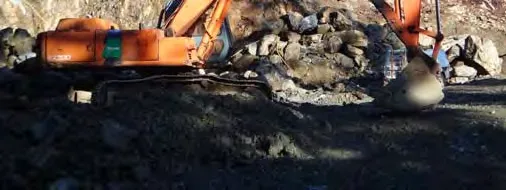

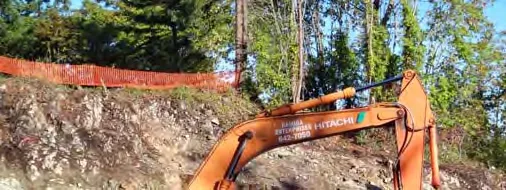

Construction equipment and excavator body on site, 25 September 2013
Construction equipment and excavator body on site, 25 September 2013

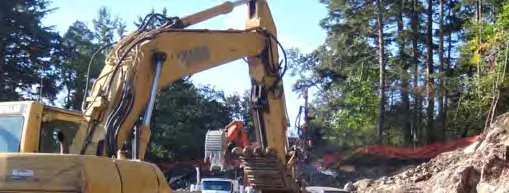

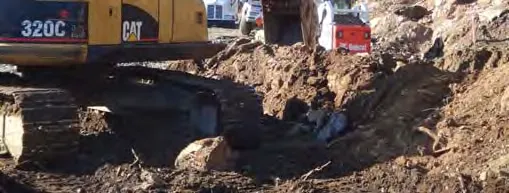

Excavator arm operating near protection fencing and trees, 25 September 2013
Excavator arm operating near protection fencing and trees, 25 September 2013

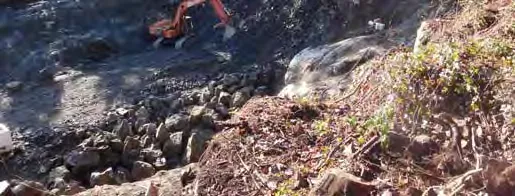

Caterpillar 320C excavator working in a trench, 25 September 2013
Caterpillar 320C excavator working in a trench, 25 September 2013

Page 52–57

Supplemental Instructions

The following Supplemental Instructions have been issued up to September 30, 2013:

  • SI No. 002 – Adjust Protection Fencing. Issued 4 September, 2013.
  • SI No. 003 – SSI 01 – Steel Stringer Support. Issued 27 September, 2013
Page 52–57

Change Orders

The following Change Orders have been issued up to September 30, 2013:

  • CO No. 003: Suspected ACM. Issued 10 September , 2013.
  • CO No. 004: Old Swimming Pool Unearthed. Issued 10 September, 2013

Page 52–57

Appendix A

Schedule

Page 52–57

Document Images

(7)
Document image
Document image
Document image
Document image
Document image
Document image
Document image
Extracted from: 2013 10 08 Committee of the Whole Agenda
