Committee of the Whole/Documents/Public Safety Building Budget Update - Apr. 30, 2014
Appendix

Public Safety Building Budget Update - Apr. 30, 2014

May 13, 2014Pages 59–611 section

Financial tracking table comparing tendered budget, revisions, and actual committed costs for the building project.

Tendered Price: $5,753,611Revised Budget: $7,402,160Total Committed as of Apr 30: $3,138,595

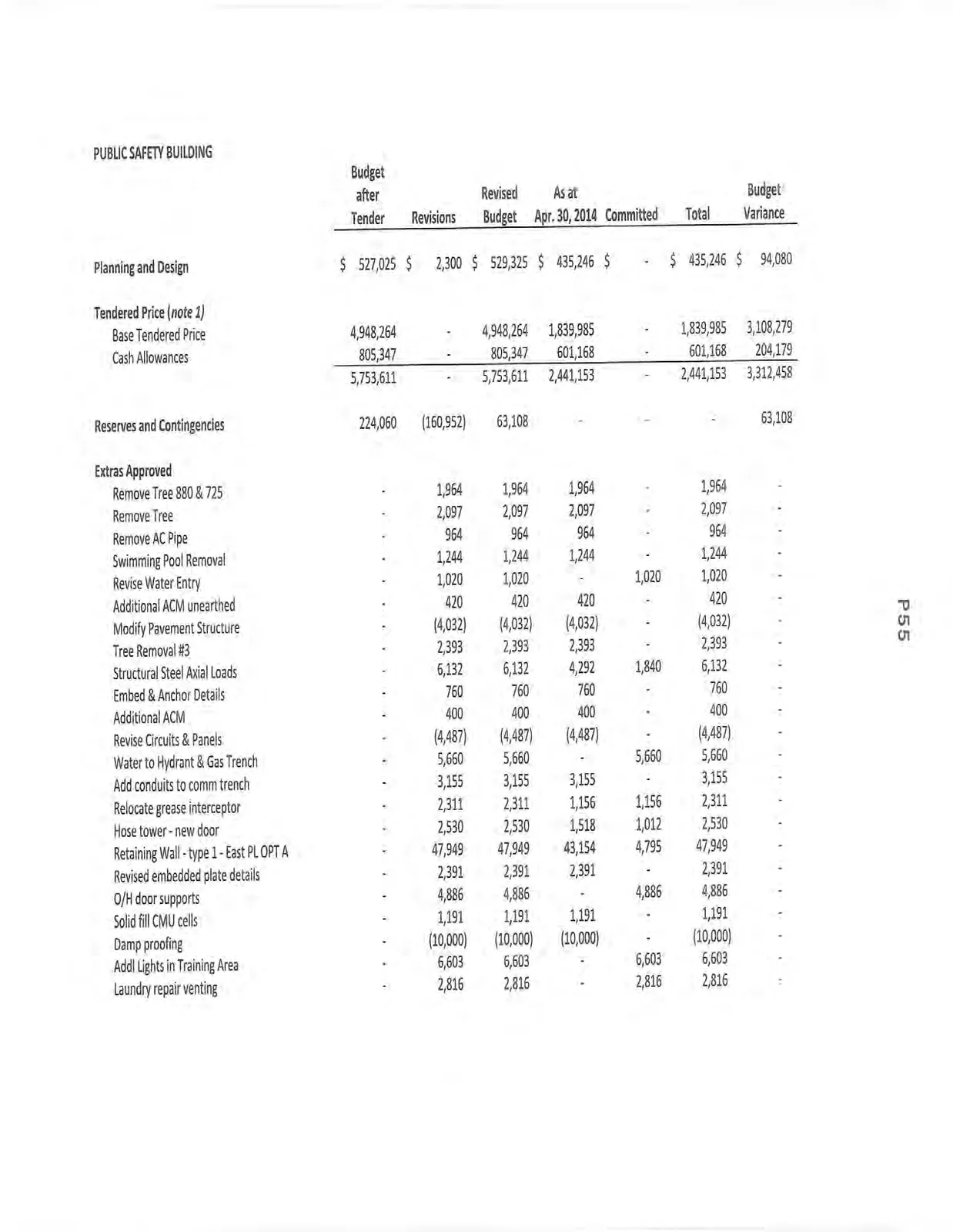

PUBLIC SAFETY BUILDING

Budget summary table for the Public Safety Building project showing Planning and Design, Tendered Price, and initial approved extras.
Budget summary table for the Public Safety Building project showing Planning and Design, Tendered Price, and initial approved extras.
Item Budget after Tender Revisions Revised Budget As at Apr. 30, 2014 Committed Total Budget Variance
Planning and Design $ 527,025 $ 2,300 $ 529,325 $ 435,246 $ - $ 435,246 $ 94,080
Tendered Price (note 1)
Base Tendered Price 4,948,264 - 4,948,264 1,839,985 - 1,839,985 3,108,279
Cash Allowances 805,347 - 805,347 601,168 - 601,168 204,179
5,753,611 - 5,753,611 2,441,153 - 2,441,153 3,312,458
Reserves and Contingencies 224,060 (160,952) 63,108 - - - 63,108
Extras Approved
Remove Tree 880 & 725 - 1,964 1,964 1,964 - 1,964 -
Remove Tree - 2,097 2,097 2,097 - 2,097 -
Remove AC Pipe - 964 964 964 - 964 -
Swimming Pool Removal - 1,244 1,244 1,244 - 1,244 -
Revise Water Entry - 1,020 1,020 - 1,020 1,020 -
Additional ACM unearthed - 420 420 420 - 420 -
Modify Pavement Structure - (4,032) (4,032) (4,032) - (4,032) -
Tree Removal #3 - 2,393 2,393 2,393 - 2,393 -
Structural Steel Axial Loads - 6,132 6,132 4,292 1,840 6,132 -
Embed & Anchor Details - 760 760 760 - 760 -
Additional ACM - 400 400 400 - 400 -
Revise Circuits & Panels - (4,487) (4,487) (4,487) - (4,487) -
Water to Hydrant & Gas Trench - 5,660 5,660 - 5,660 5,660 -
Add conduits to comm trench - 3,155 3,155 3,155 - 3,155 -
Relocate grease interceptor - 2,311 2,311 1,156 1,156 2,311 -
Hose tower - new door - 2,530 2,530 1,518 1,012 2,530 -
Retaining Wall - type 1 - East PL OPT A - 47,949 47,949 43,154 4,795 47,949 -
Revised embedded plate details - 2,391 2,391 2,391 - 2,391 -
O/H door supports - 4,886 4,886 - 4,886 4,886 -
Solid fill CMU cells - 1,191 1,191 1,191 - 1,191 -
Damp proofing - (10,000) (10,000) (10,000) - (10,000) -
Addl Lights in Training Area - 6,603 6,603 - 6,603 6,603 -
Laundry repair venting - 2,816 2,816 - 2,816 2,816 -
Continuation of the budget table including further approved extras, proposed extras, contemplated owner changes, and completion costs.
Continuation of the budget table including further approved extras, proposed extras, contemplated owner changes, and completion costs.
Item Budget after Tender Revisions Revised Budget As at Apr. 30, 2014 Committed Total Budget Variance
Flagpole lighting - 5,349 5,349 - 5,349 5,349 -
Add clean out - 777 777 777 - 777 -
Retain slope at Soil Valley - 3,051 3,051 - 3,051 3,051 -
Alternate locker finish - (16,617) (16,617) (16,617) - (16,617) -
Aluminum gate - (1,250) (1,250) (1,250) - (1,250) -
Rock Breaker - 4,166 4,166 - 4,166 4,166 -
Relocate Hose Tower FDC + revise FDC - - - - - - -
Plumbing Fixture clarification - 1,079 1,079 - 1,079 1,079 -
Misc Electrical - 15,393 15,393 - 15,393 15,393 -
Fire Extinguisher Clarification - (352) (352) - (352) (352) -
Embed Plate @ GL D & 5. Sprink - 3,584 3,584 - 3,584 3,584 -
Truck wash, hose bib & exhaust - 3,426 3,426 - 3,426 3,426 -
Revise laundry room slab - - - - - - -
Entry siding revise to red - 1,437 1,437 - 1,437 1,437 -
- 98,409 98,409 31,489 66,920 98,409 -
Extras Proposed - 30,257 30,257 - - - 30,257
Owner Changes Contemplated 386,599 - 386,599 - - - 386,599
Completion Costs
Furniture & Equipment 150,000 - 150,000 - - - 150,000
DCC 41,760 - 41,760 41,760 - 41,760 0
Building Permit/Testing Structural and Geotech. 25,750 12,000 37,750 37,733 - 37,733 17
Connection Fees (BC Hydro Fee) 48,115 15,986 64,101 52,101 - 52,101 12,000
Administration Costs 10,000 - 10,000 - - - 10,000
Legal Costs 8,000 - 8,000 5,862 - 5,862 2,138
Insurance Costs 11,340 - 11,340 11,340 (11,340) - 11,340
Public Art 35,000 - 35,000 - - - 35,000
Operation/Startup Costs 35,000 - 35,000 - - - 35,000
364,965 27,986 392,951 148,796 (11,340) 137,456 255,495
Adjusted Construction Cost Total $ 7,256,260 $ (2,000) $ 7,254,260 $ 3,056,684 $ 55,580 $ 3,112,264 $ 4,141,996
Off Site Services budget table and project accounting notes.
Off Site Services budget table and project accounting notes.

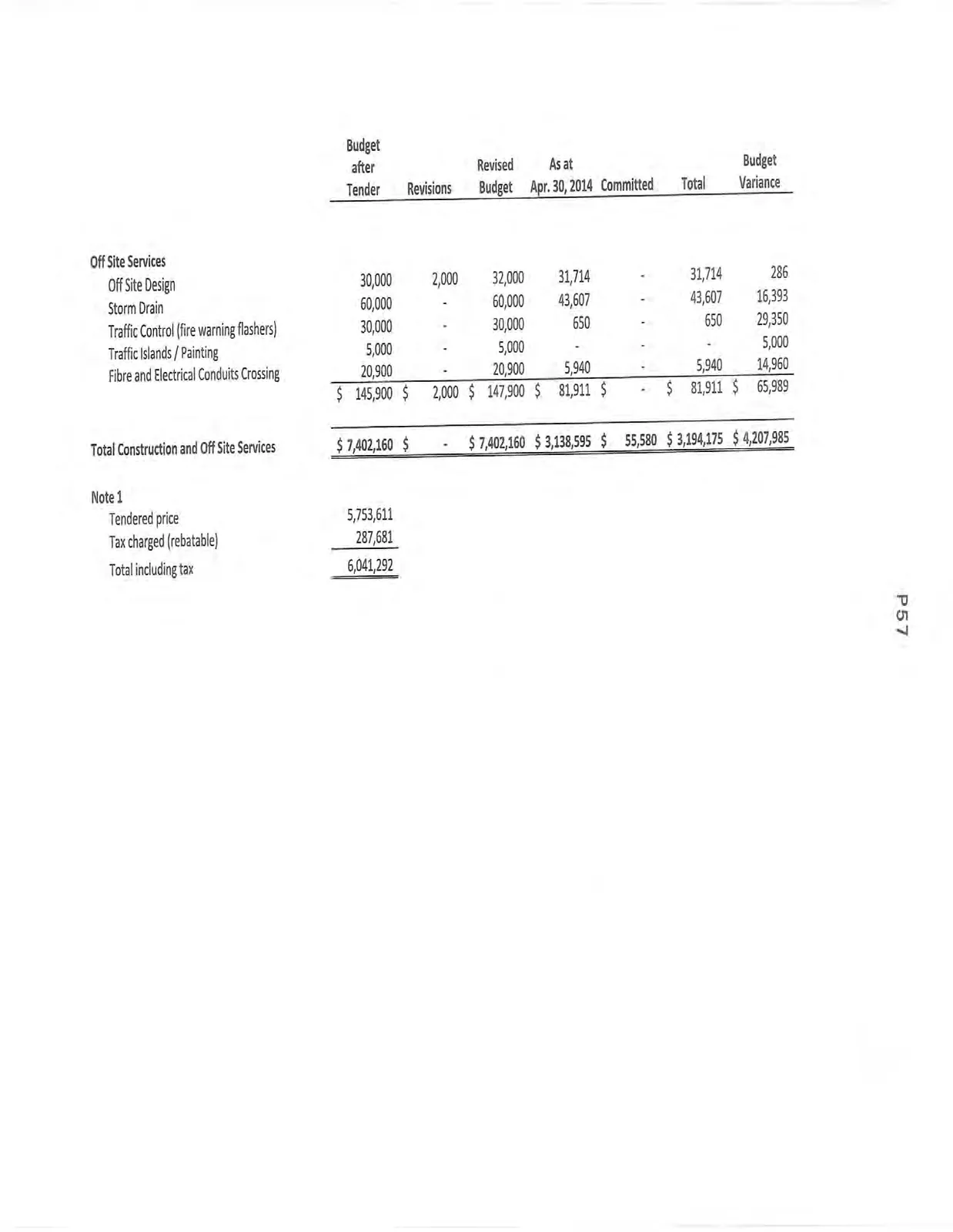

Off Site Services

Item Budget after Tender Revisions Revised Budget As at Apr. 30, 2014 Committed Total Budget Variance
Off Site Design 30,000 2,000 32,000 31,714 - 31,714 286
Storm Drain 60,000 - 60,000 43,607 - 43,607 16,393
Traffic Control (fire warning flashers) 30,000 - 30,000 650 - 650 29,350
Traffic Islands / Painting 5,000 - 5,000 - - - 5,000
Fibre and Electrical Conduits Crossing 20,900 - 20,900 5,940 - 5,940 14,960
$ 145,900 $ 2,000 $ 147,900 $ 81,911 $ - $ 81,911 $ 65,989
Total Construction and Off Site Services $ 7,402,160 $ - $ 7,402,160 $ 3,138,595 $ 55,580 $ 3,194,175 $ 4,207,985

Note 1

  • Tendered price: 5,753,611
  • Tax charged (rebatable): 287,681
  • Total including tax: 6,041,292
Page 59–61
Extracted from: 2014 05 13 Committee of the Whole Agenda
