Committee of the Whole/Documents/View Royal Public Safety Building Monthly Report for January 2014
Staff Report

View Royal Public Safety Building Monthly Report for January 2014

February 11, 2014Pages 58–6510 sections

Monthly progress report on the construction of the new Public Safety Building including work completed and supplemental instructions issued.

Report dated February 6, 2014Work includes concrete footings and east retaining wallSupplemental instructions SI No. 014 through 021 issued

View Royal Public Safety Building

Page 58–65

Town of View Royal

Page 58–65

Monthly Report for January 2014

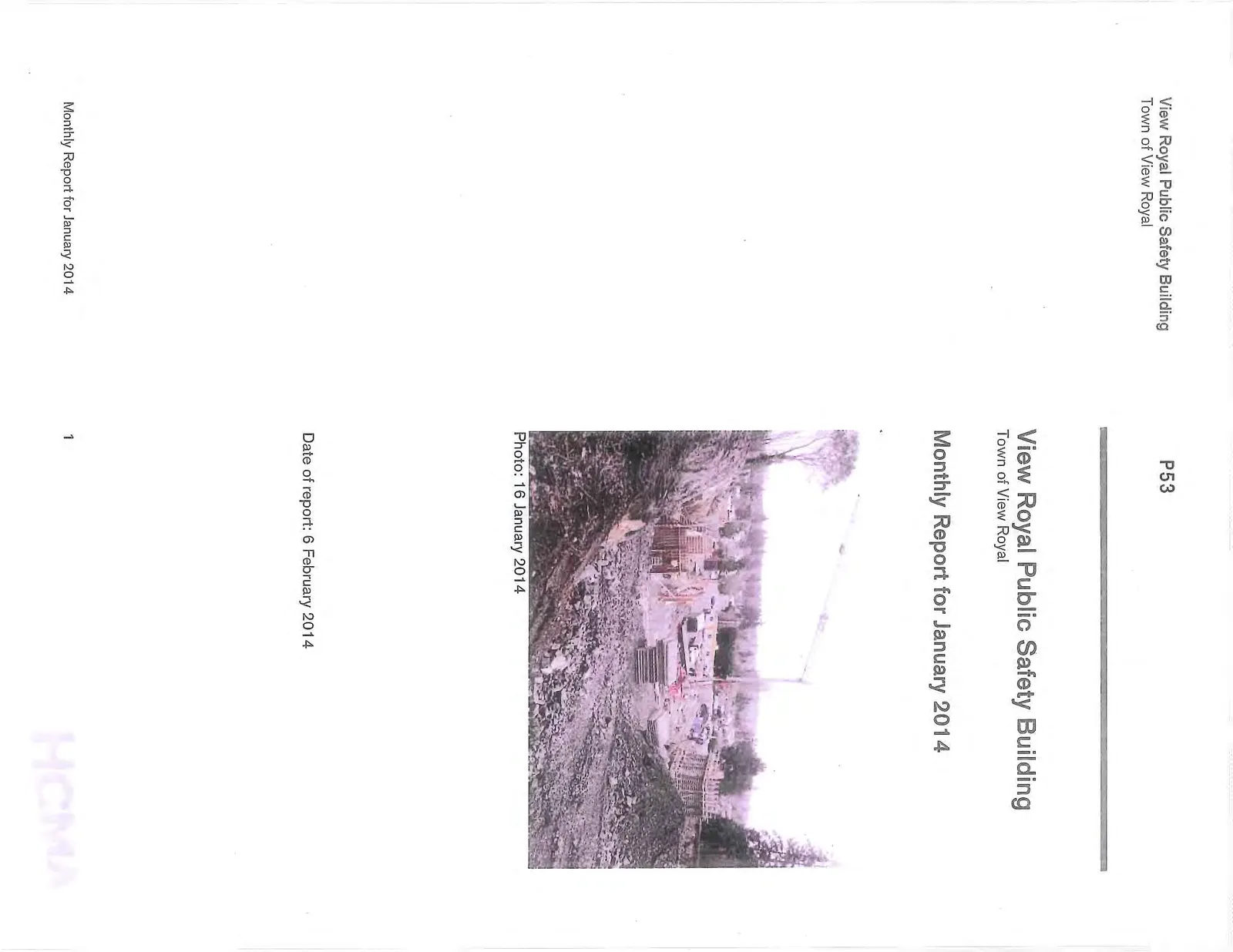

Construction site photograph dated 16 January 2014 showing early foundational work and a crane on site
Construction site photograph dated 16 January 2014 showing early foundational work and a crane on site

Date of report: 6 February 2014

PREPARED FOR:

  • Kim Anema, Chief Administrative Officer, Town of View Royal
  • Paul Hurst, Fire Chief, Emergency Program Coordinator, View Royal Fire Rescue

PREPARED BY:

  • Heather Spinney, Architect AIBC, Hughes Condon Marler Architects

CONTENTS:

  • Introduction — 3
  • Status of Project — 3
  • Work Progress — 3
  • Progress Photographs — 4-6
  • Supplemental Instructions — 7
  • Change Orders / Change Directives — 7
  • Appendix A Schedule
Page 58–65

INTRODUCTION

This report summarizes the progress and status of the View Royal Public Safety Building up to the end of the month of January 2014.

Page 58–65

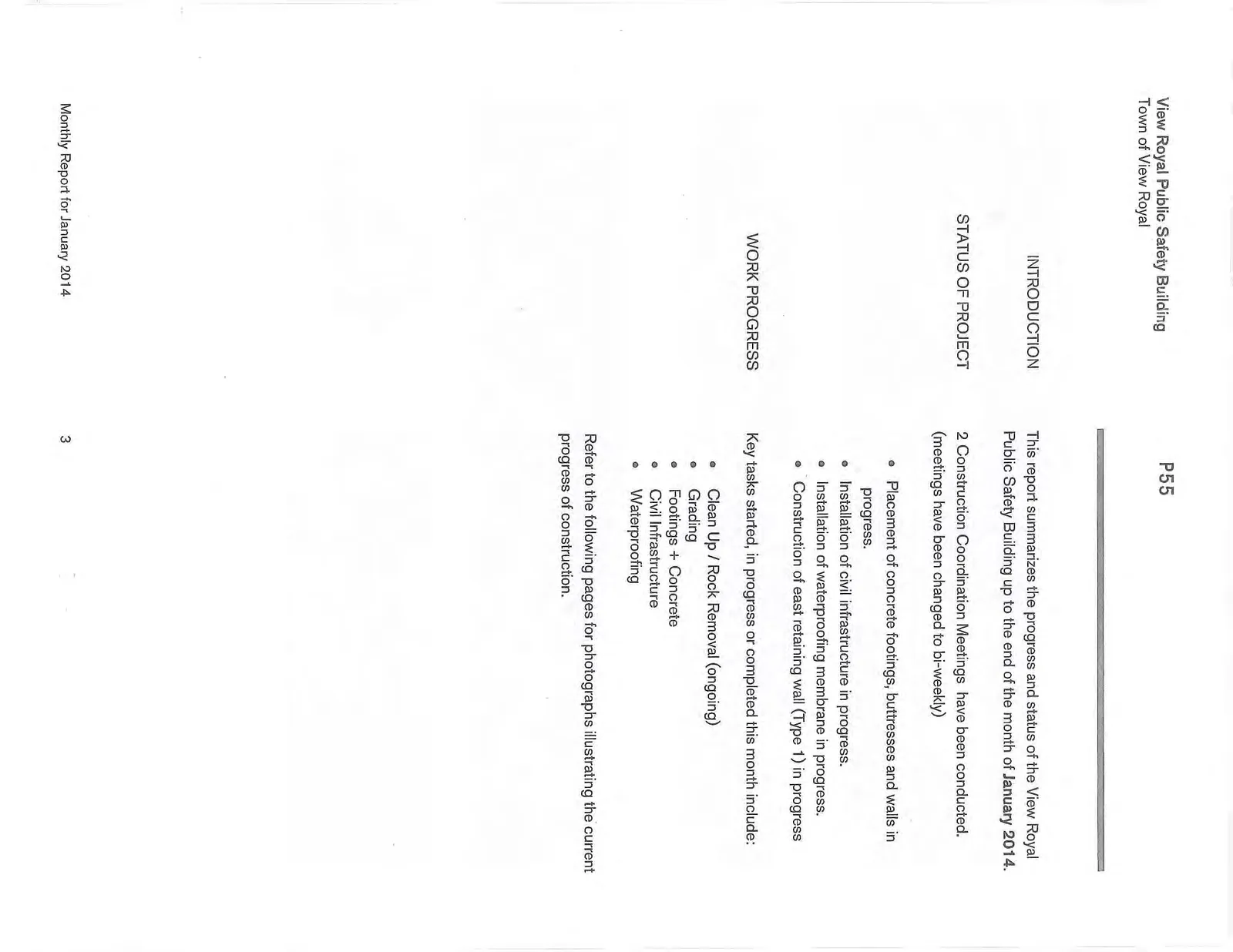

STATUS OF PROJECT

2 Construction Coordination Meetings have been conducted. (meetings have been changed to bi-weekly)

  • Placement of concrete footings, buttresses and walls in progress.
  • Installation of civil infrastructure in progress.
  • Installation of waterproofing membrane in progress.
  • Construction of east retaining wall (Type 1) in progress.
Page 58–65

WORK PROGRESS

Key tasks started, in progress or completed this month include:

  • Clean Up / Rock Removal (ongoing)
  • Grading
  • Footings + Concrete
  • Civil Infrastructure
  • Waterproofing

Refer to the following pages for photographs illustrating the current progress of construction.

Progress Photographs

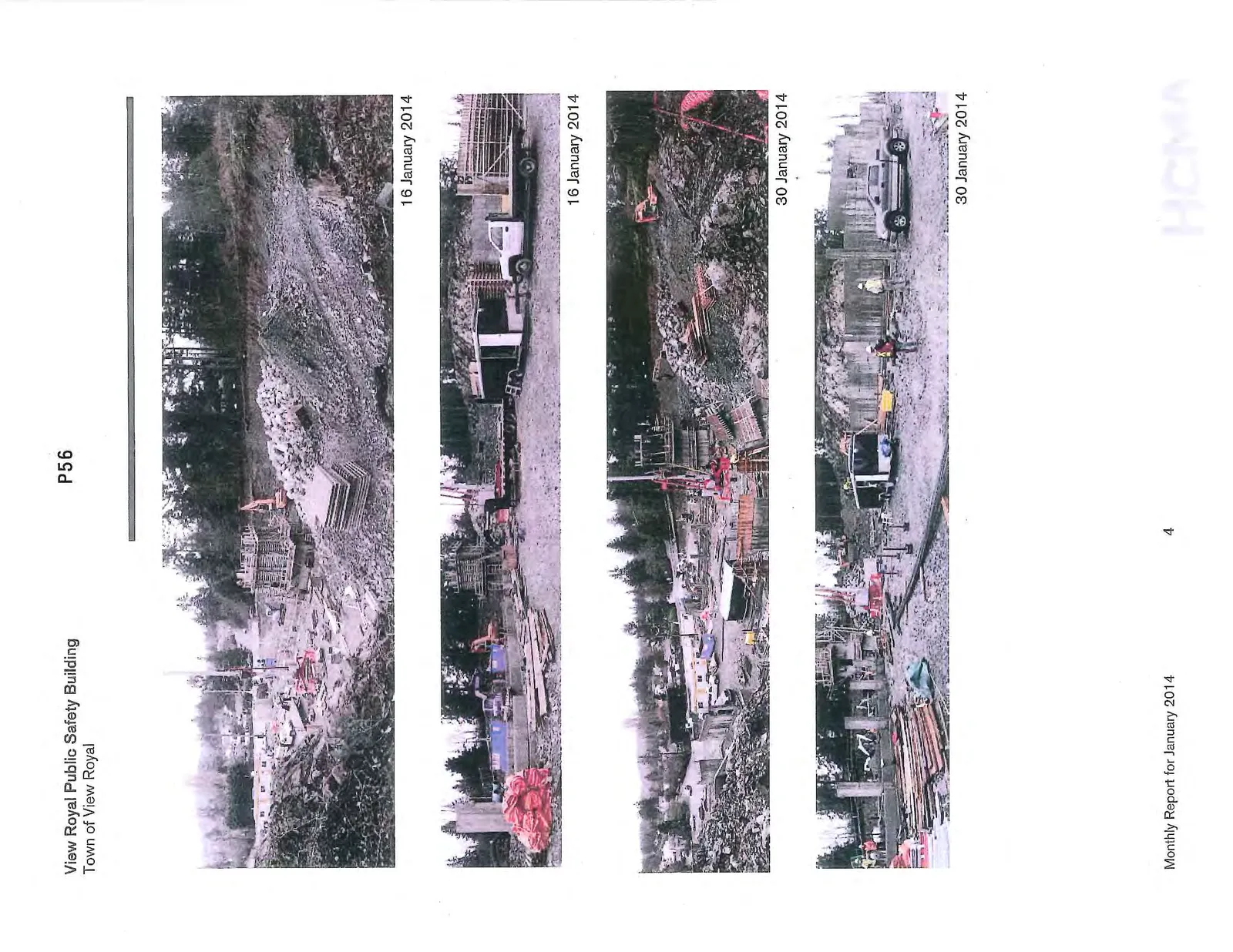

Panoramic construction site overview, 16 January 2014
Panoramic construction site overview, 16 January 2014

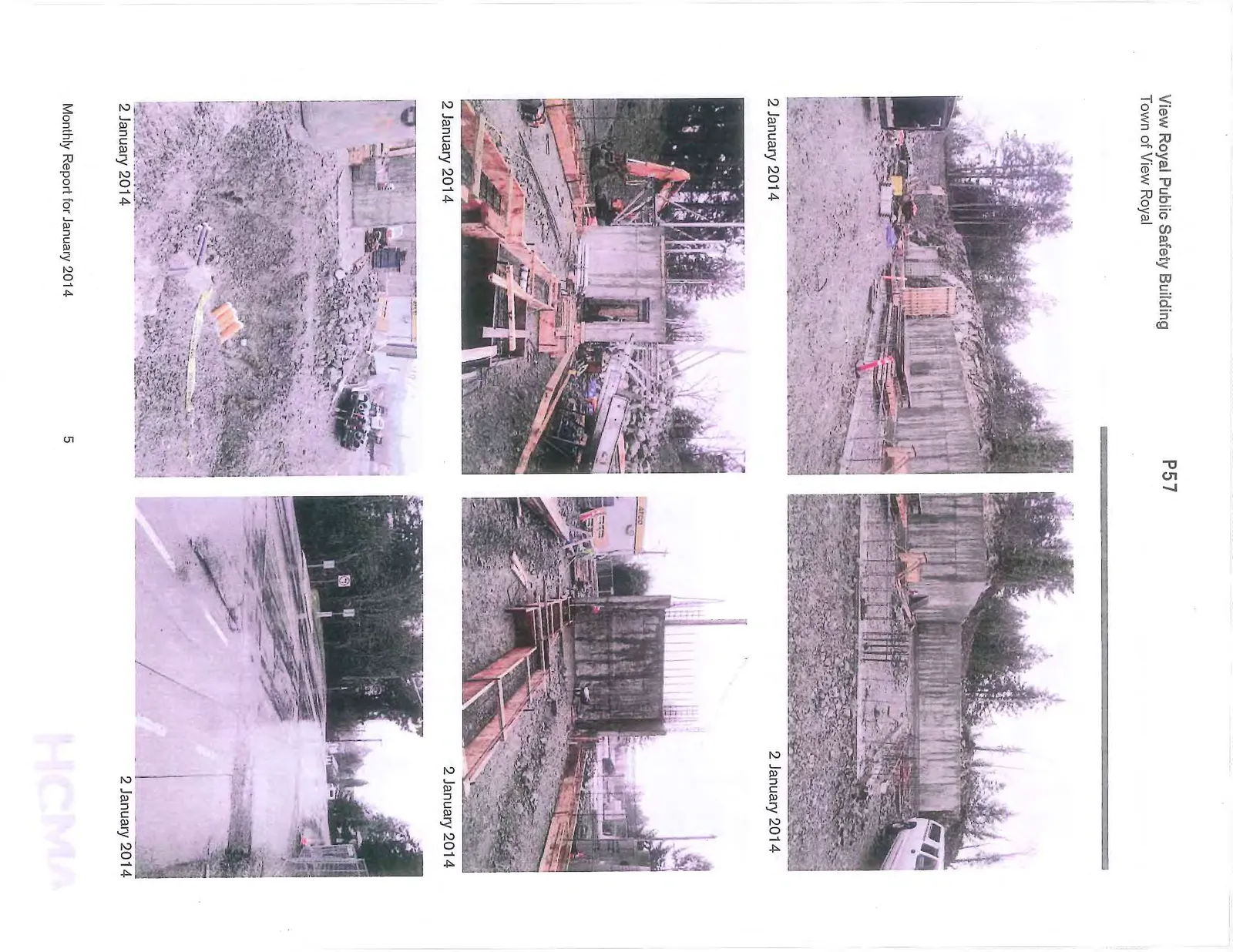

Panoramic construction site overview showing site office and equipment, 16 January 2014
Panoramic construction site overview showing site office and equipment, 16 January 2014

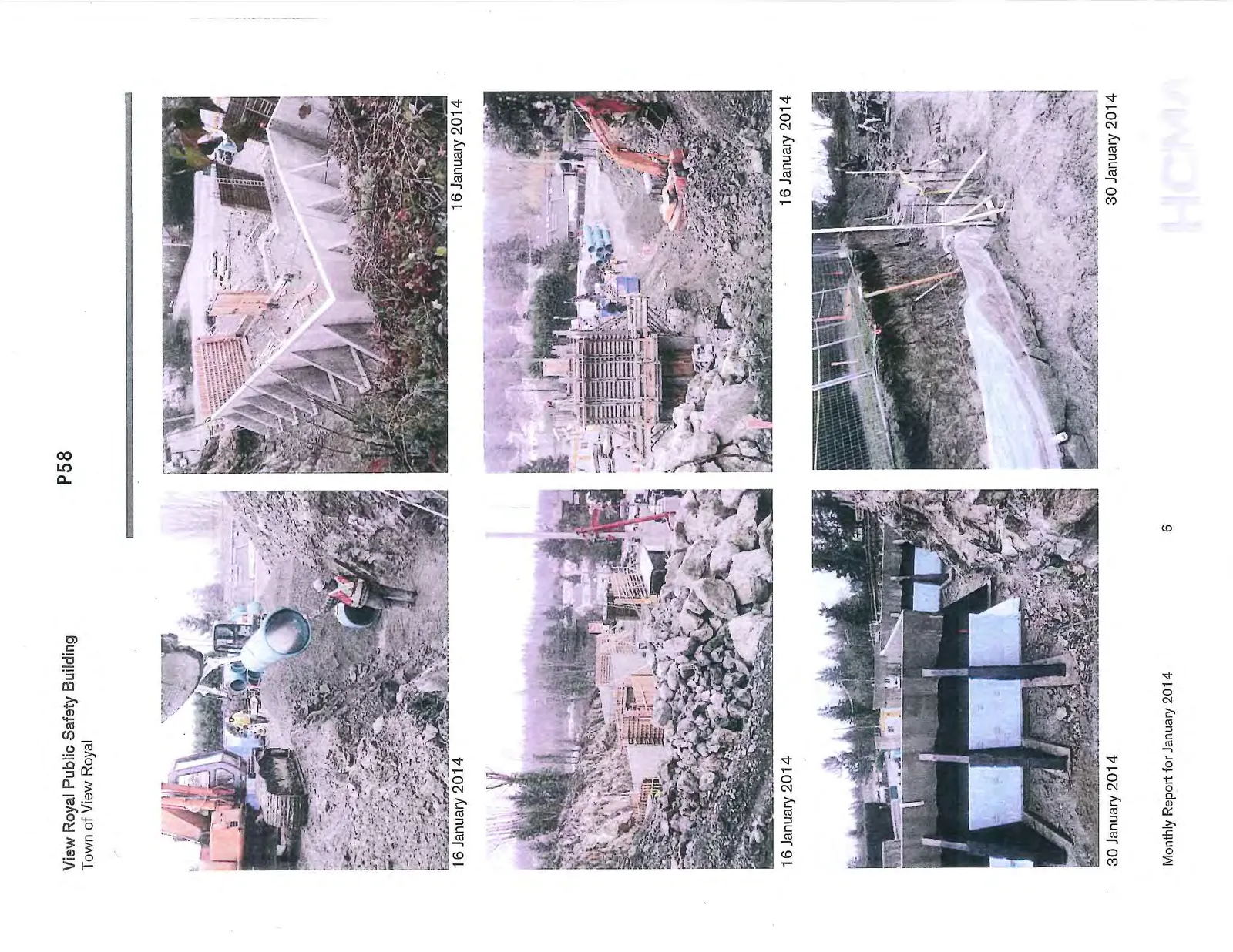

Panoramic construction site overview showing excavation area, 30 January 2014
Panoramic construction site overview showing excavation area, 30 January 2014
Page 58–65

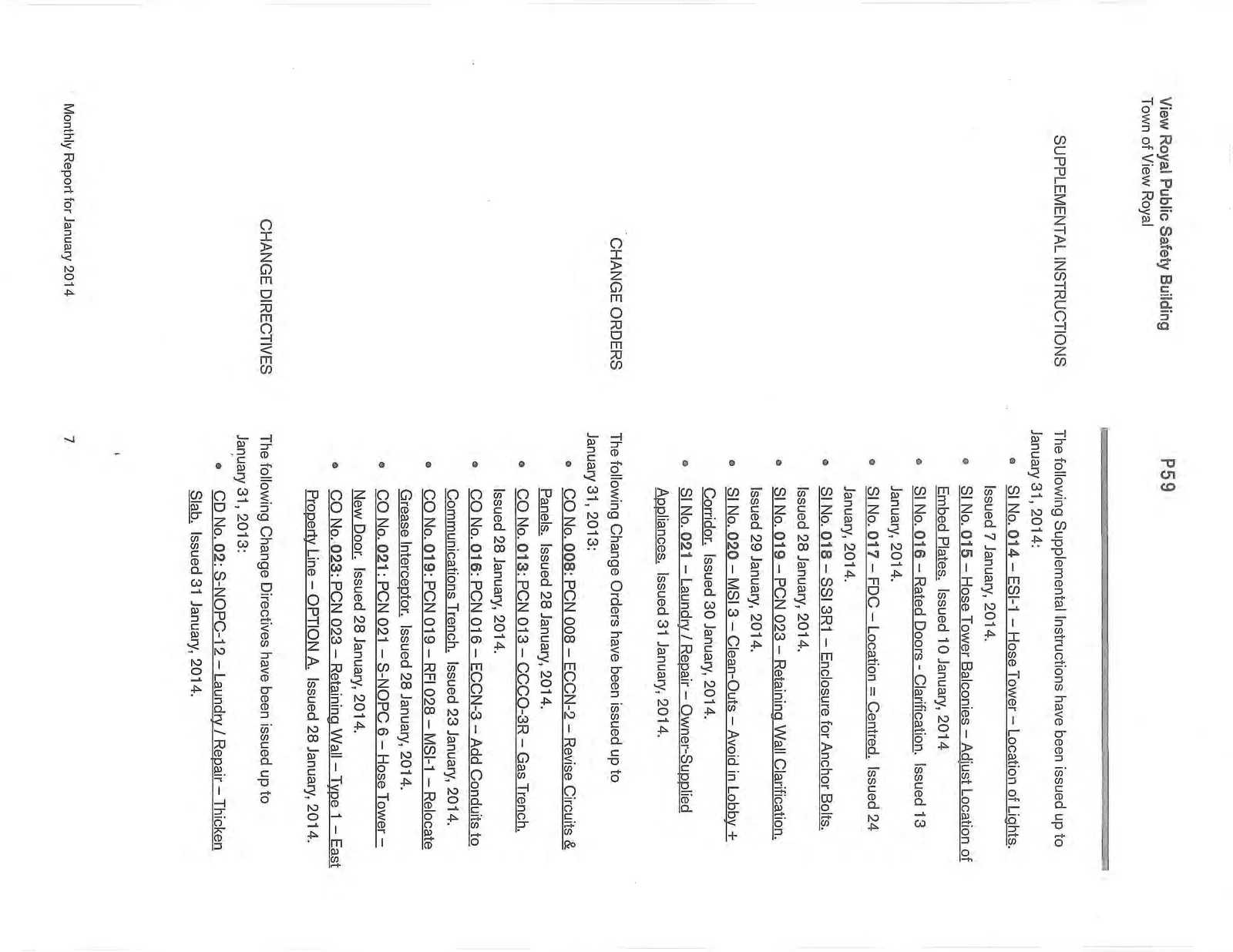

SUPPLEMENTAL INSTRUCTIONS

The following Supplemental Instructions have been issued up to January 31, 2014:

  • SI No. 014 – ESI-1 – Hose Tower – Location of Lights. Issued 7 January, 2014.
  • SI No. 015 – Hose Tower Balconies – Adjust Location of Embed Plates. Issued 10 January, 2014
  • SI No. 016 – Rated Doors – Clarification. Issued 13 January, 2014.
  • SI No. 017 – FDC – Location = Centred. Issued 24 January, 2014.
  • SI No. 018 – SSI 3R1 – Enclosure for Anchor Bolts. Issued 28 January, 2014.
  • SI No. 019 – PCN 023 – Retaining Wall Clarification. Issued 29 January, 2014.
  • SI No. 020 – MSI 3 – Clean-Outs – Avoid in Lobby + Corridor. Issued 30 January, 2014.
  • SI No. 021 – Laundry / Repair – Owner-Supplied Appliances. Issued 31 January, 2014.
Page 58–65

CHANGE ORDERS

The following Change Orders have been issued up to January 31, 2013:

  • CO No. 008: PCN 008 – ECCN-2 – Revise Circuits & Panels. Issued 28 January, 2014.
  • CO No. 013: PCN 013 – CCCO-3R – Gas Trench. Issued 28 January, 2014.
  • CO No. 016: PCN 016 – ECCN-3 – Add Conduits to Communications Trench. Issued 23 January, 2014.
  • CO No. 019: PCN 019 – RFI 028 – MSI-1 – Relocate Grease Interceptor. Issued 28 January, 2014.
  • CO No. 021: PCN 021 – S-NOPC 6 – Hose Tower – New Door. Issued 28 January, 2014.
  • CO No. 023: PCN 023 – Retaining Wall – Type 1 – East Property Line – OPTION A. Issued 28 January, 2014.
Page 58–65

CHANGE DIRECTIVES

The following Change Directives have been issued up to January 31, 2013:

  • CD No. 02: S-NOPC-12 – Laundry / Repair – Thicken Slab. Issued 31 January, 2014.
Page 58–65

Appendix A

Schedule

Page 58–65
