Committee of the Whole/Documents/View Royal Public Safety Building Monthly Report for August 2014
Staff Report

View Royal Public Safety Building Monthly Report for August 2014

September 9, 2014Pages 23–324 sections

Construction progress report for the new Public Safety Building, including budget variances and photo documentation of work on site.

1. CALL TO ORDER (Mayor Hill)
Total Construction and Off Site Services budget: $7,402,160Budget variance: $3,025,251Status: Building envelope and interior finishes in progress.

View Royal Public Safety Building

Town of View Royal

Page 23–32

Monthly Report for August 2014

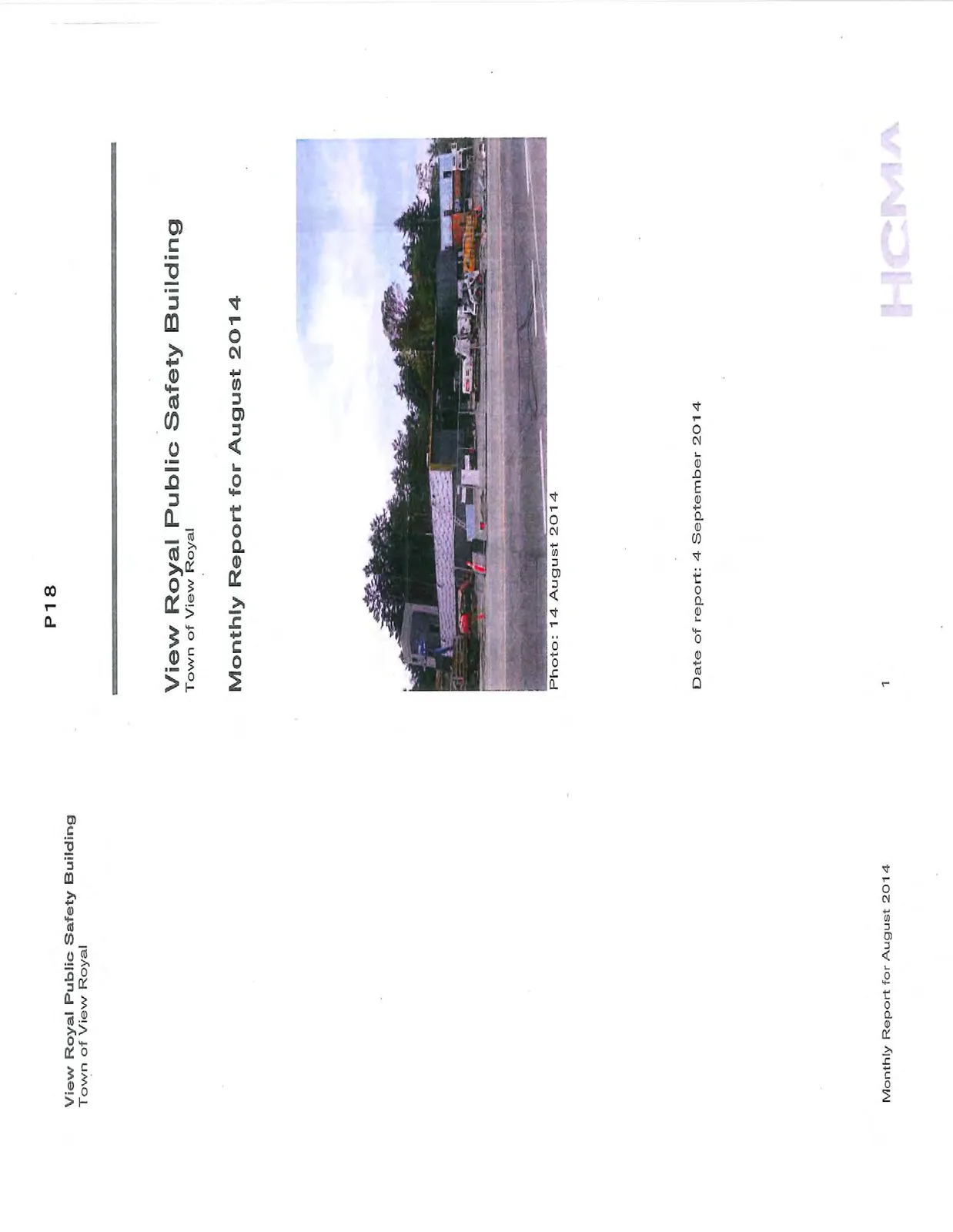

Exterior construction progress photo of the building, dated 14 August 2014
Exterior construction progress photo of the building, dated 14 August 2014

Date of report: 4 September 2014

Page 23–32

Monthly Report for August 2014

PREPARED FOR: Kim Anema, Chief Administrative Officer Town of View Royal

Paul Hurst, Fire Chief, Emergency Program Coordinator View Royal Fire Rescue

PREPARED BY: Heather Spinney, Architect AIBC Hughes Condon Marler Architects

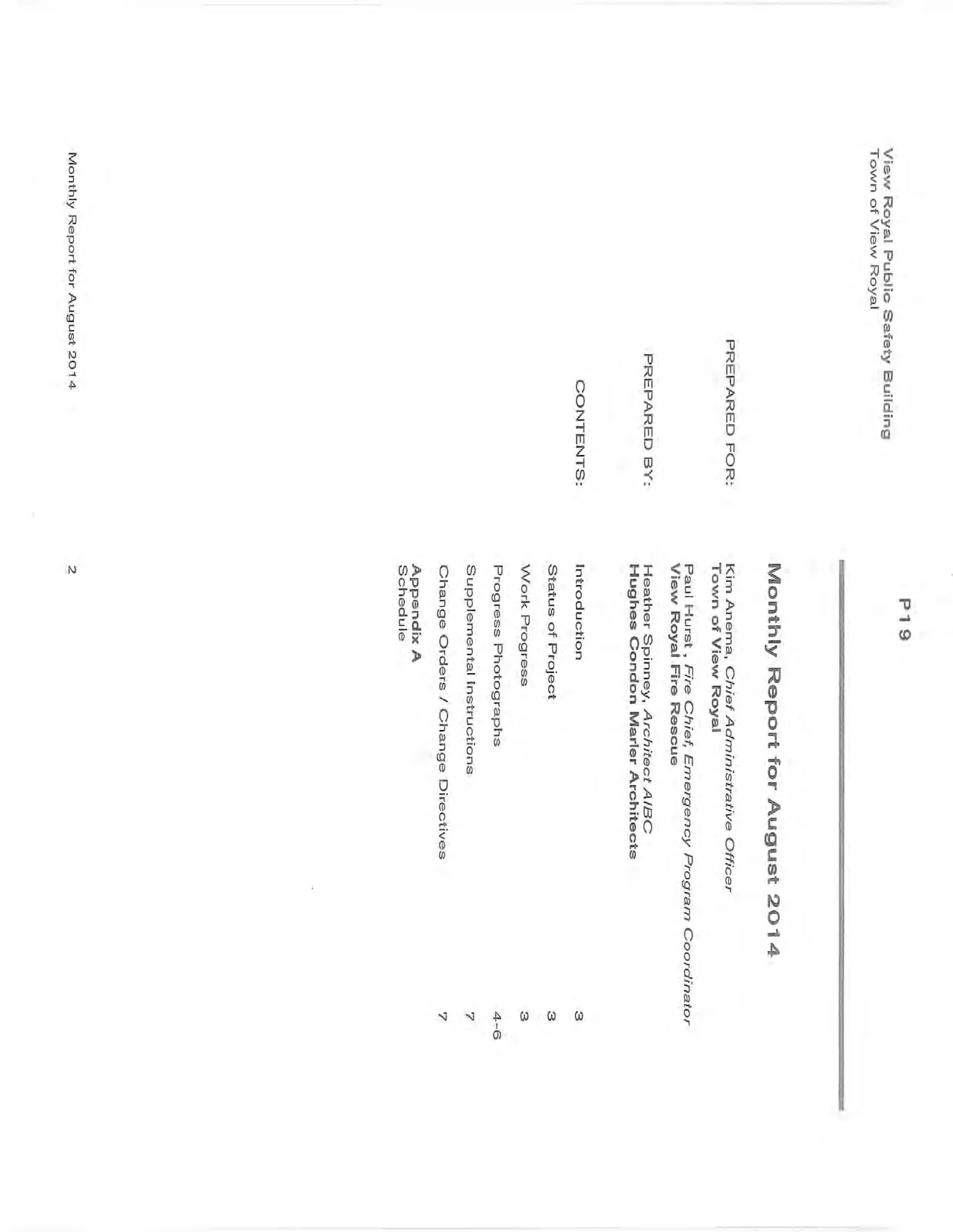

CONTENTS:

  • Introduction (3)
  • Status of Project (3)
  • Work Progress (3)
  • Progress Photographs (4-6)
  • Supplemental Instructions (7)
  • Change Orders / Change Directives (7)
  • Appendix A: Schedule

INTRODUCTION

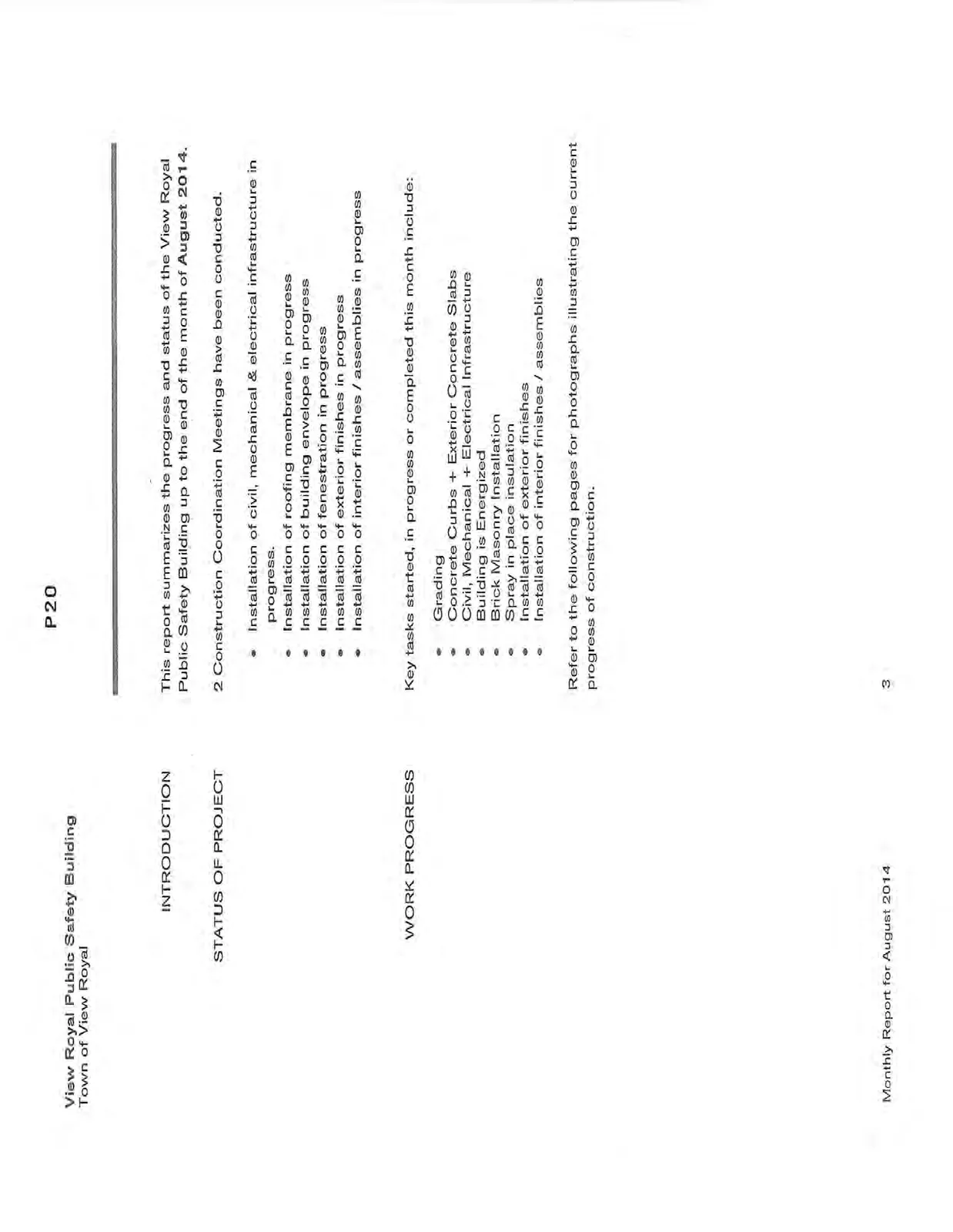

This report summarizes the progress and status of the View Royal Public Safety Building up to the end of the month of August 2014.

STATUS OF PROJECT

2 Construction Coordination Meetings have been conducted.

  • Installation of civil, mechanical & electrical infrastructure in progress.
  • Installation of roofing membrane in progress.
  • Installation of building envelope in progress.
  • Installation of fenestration in progress.
  • Installation of exterior finishes in progress.
  • Installation of interior finishes / assemblies in progress.

WORK PROGRESS

Key tasks started, in progress or completed this month include:

  • Grading
  • Concrete Curbs + Exterior Concrete Slabs
  • Civil, Mechanical + Electrical Infrastructure
  • Building is Energized
  • Brick Masonry Installation
  • Spray in place insulation
  • Installation of exterior finishes
  • Installation of interior finishes / assemblies

Refer to the following pages for photographs illustrating the current progress of construction.

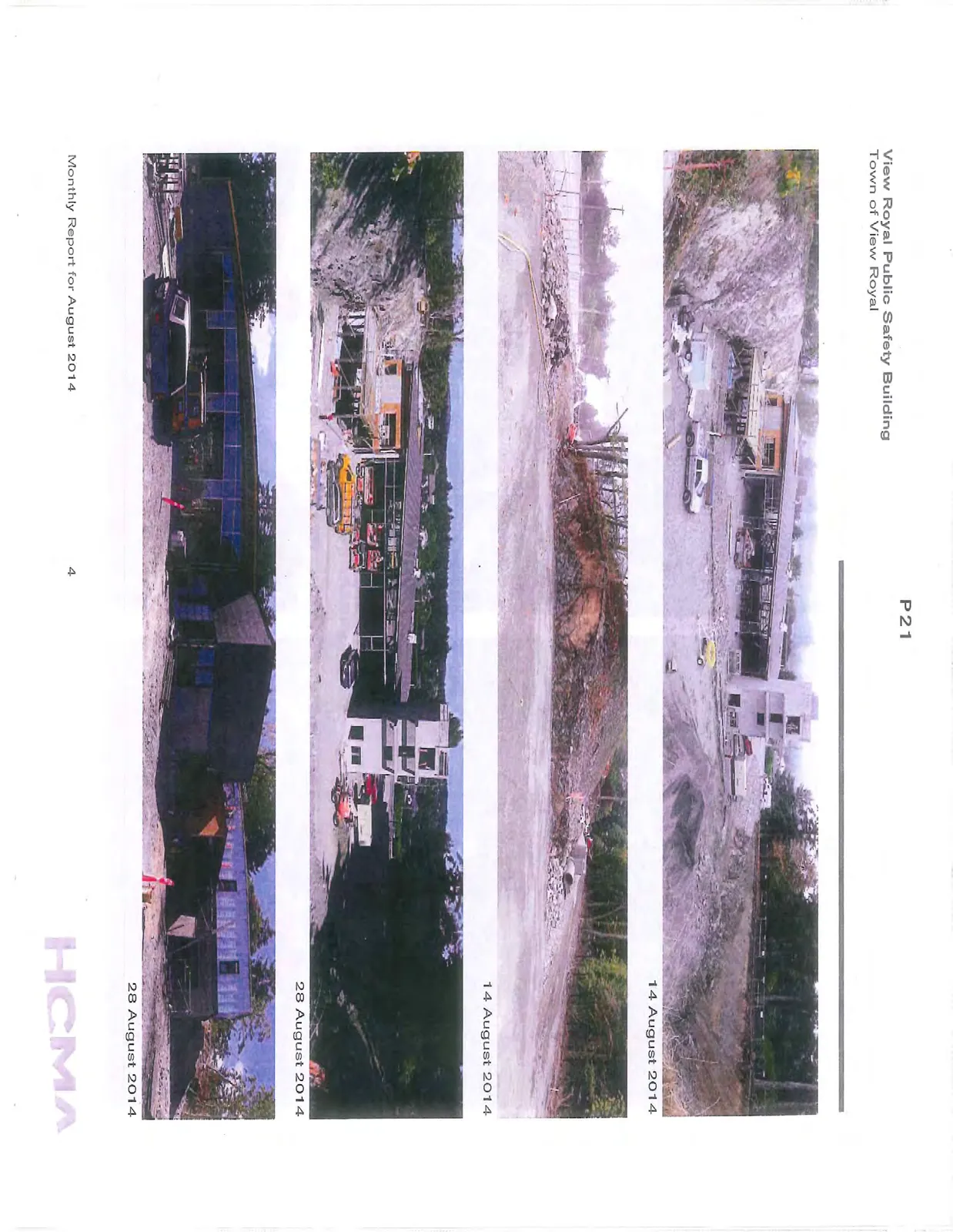

Top site overview photo showing the construction lot and building frame, dated 14 August 2014
Top site overview photo showing the construction lot and building frame, dated 14 August 2014
Second site overview photo showing the excavation and rock face, dated 14 August 2014
Second site overview photo showing the excavation and rock face, dated 14 August 2014

Third site overview photo showing building exterior and vehicles on site, dated 28 August 2014
Third site overview photo showing building exterior and vehicles on site, dated 28 August 2014

SUPPLEMENTAL INSTRUCTIONS

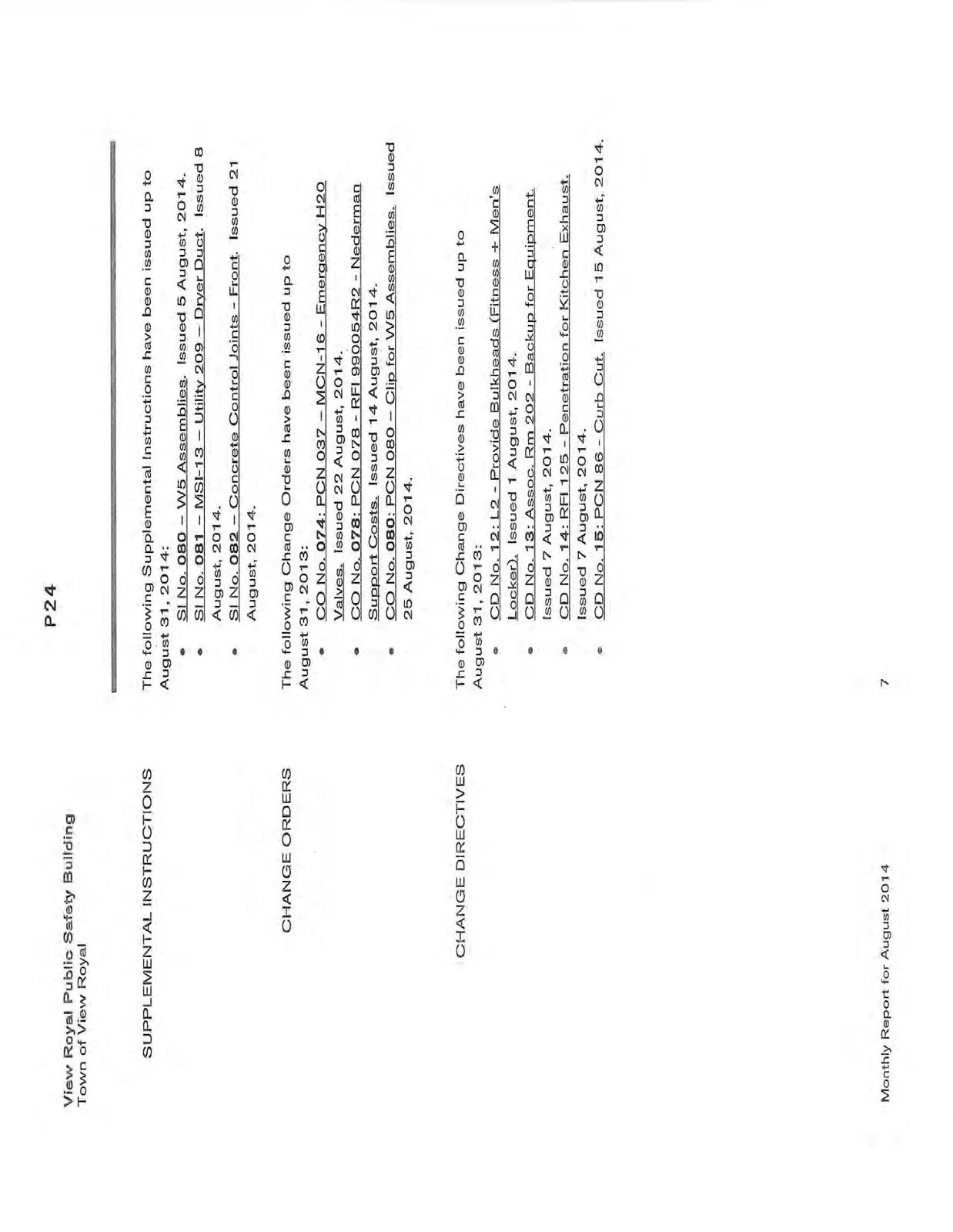

The following Supplemental Instructions have been issued up to August 31, 2014:

  • SI No. 080 - W5 Assemblies. Issued 5 August, 2014.
  • SI No. 081 - MSI-13 - Utility 209 - Dryer Duct. Issued 8 August, 2014.
  • SI No. 082 - Concrete Control Joints - Front. Issued 21 August, 2014.

CHANGE ORDERS

The following Change Orders have been issued up to August 31, 2013:

  • CO No. 074: PCN 037 - MCN-16 - Emergency H2O Valves. Issued 22 August, 2014.
  • CO No. 078: PCN 078 - RFI 990054R2 - Nederman Support Costs. Issued 14 August, 2014.
  • CO No. 080: PCN 080 - Clip for W5 Assemblies. Issued 25 August, 2014.

CHANGE DIRECTIVES

The following Change Directives have been issued up to August 31, 2013:

  • CD No. 12: L2 - Provide Bulkheads (Fitness + Men's Locker). Issued 1 August, 2014.
  • CD No. 13: Assoc. Rm 202 - Backup for Equipment. Issued 7 August, 2014.
  • CD No. 14: RFI 125 - Penetration for Kitchen Exhaust. Issued 7 August, 2014.
  • CD No. 15: PCN 86 - Curb Cut. Issued 15 August, 2014.

PUBLIC SAFETY BUILDING BUDGET

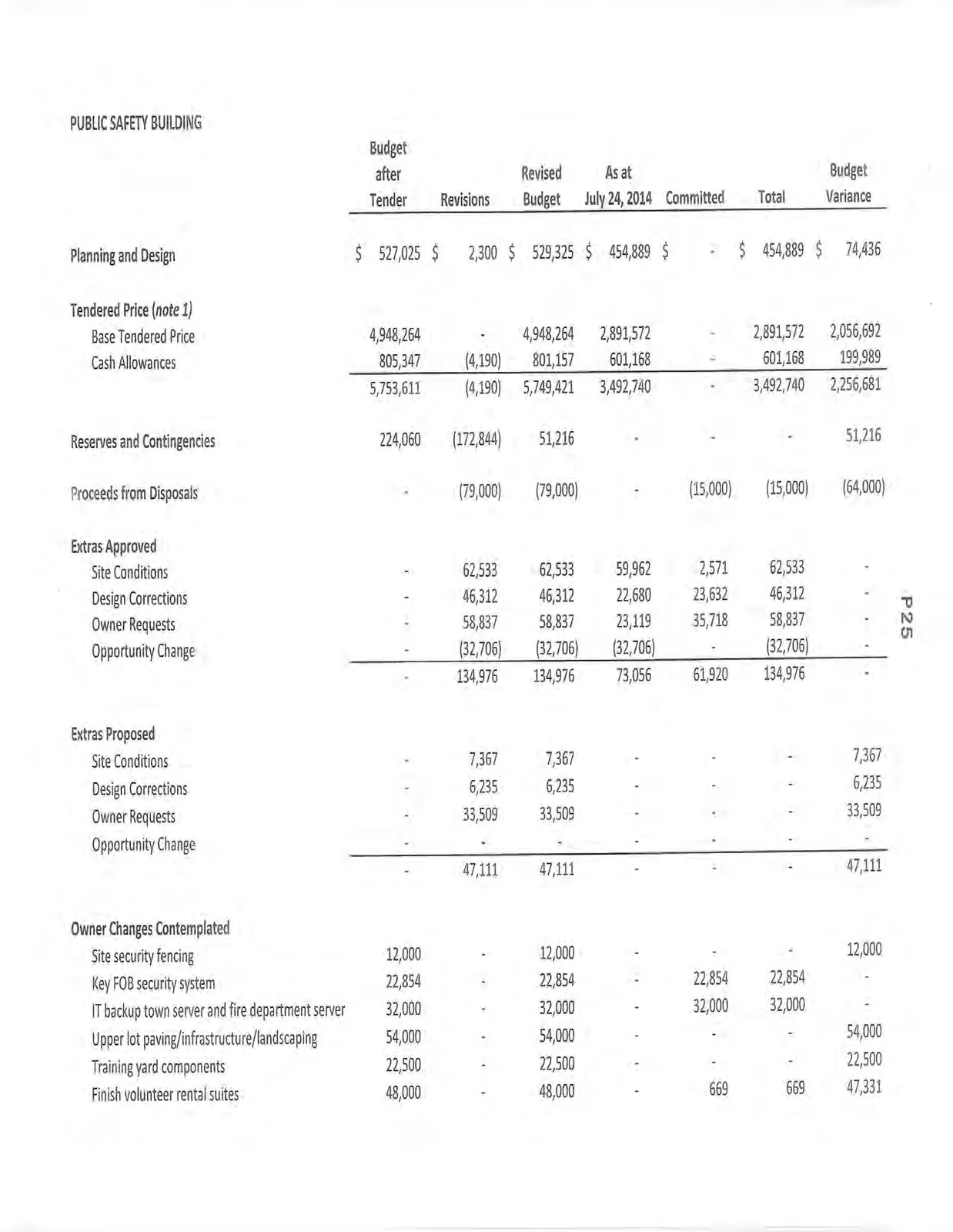

PUBLIC SAFETY BUILDING Budget after Tender Revisions Revised Budget As at July 24, 2014 Committed Total Budget Variance
Planning and Design $ 527,025 $ 2,300 $ 529,325 $ 454,889 $ - $ 454,889 $ 74,436
Tendered Price (note 1)
Base Tendered Price 4,948,264 - 4,948,264 2,891,572 - 2,891,572 2,056,692
Cash Allowances 805,347 (4,190) 801,157 601,168 - 601,168 199,989
5,753,611 (4,190) 5,749,421 3,492,740 - 3,492,740 2,256,681
Reserves and Contingencies 224,060 (172,844) 51,216 - - - 51,216
Proceeds from Disposals - (79,000) (79,000) - (15,000) (15,000) (64,000)
Extras Approved
Site Conditions - 62,533 62,533 59,962 2,571 62,533 -
Design Corrections - 46,312 46,312 22,680 23,632 46,312 -
Owner Requests - 58,837 58,837 23,119 35,718 58,837 -
Opportunity Change - (32,706) (32,706) (32,706) - (32,706) -
- 134,976 134,976 73,056 61,920 134,976 -
Extras Proposed
Site Conditions - 7,367 7,367 - - - 7,367
Design Corrections - 6,235 6,235 - - - 6,235
Owner Requests - 33,509 33,509 - - - 33,509
Opportunity Change - - - - - - -
- 47,111 47,111 - - - 47,111
Owner Changes Contemplated
Site security fencing 12,000 - 12,000 - - - 12,000
Key FOB security system 22,854 - 22,854 - 22,854 22,854 -
IT backup town server and fire department server 32,000 - 32,000 - 32,000 32,000 -
Upper lot paving/infrastructure/landscaping 54,000 - 54,000 - - - 54,000
Training yard components 22,500 - 22,500 - - - 22,500
Finish volunteer rental suites 48,000 - 48,000 - 669 669 47,331

Page 23–32
Budget after Tender Revisions Revised Budget As at July 24, 2014 Committed Total Budget Variance
LED community message board 40,000 - 40,000 - - - 40,000
Building maintenance equipment 6,000 - 6,000 - - - 6,000
Finish trailer enclosure 15,000 - 15,000 - - - 15,000
Mezzanine winch and beam 10,000 - 10,000 - - - 10,000
Amount available for overages 124,245 - 124,245 - - - 124,245
386,599 - 386,599 - 55,523 55,523 331,076
Completion Costs
Furniture & Equipment 150,000 - 150,000 18,971 - 18,971 131,029
DCC 41,760 - 41,760 41,760 - 41,760 0
Building Permit/Testing Structural and Geotech. 25,750 25,000 50,750 46,083 - 46,083 4,667
Connection Fees (BC Hydro Fee) 48,115 15,986 64,101 52,101 - 52,101 12,000
Administration Costs 10,000 - 10,000 - - - 10,000
Legal Costs 8,000 40,000 48,000 9,033 - 9,033 38,967
Insurance Costs 11,340 (11,340) - - - - -
Public Art 35,000 - 35,000 - - - 35,000
Operation/Startup Costs 35,000 - 35,000 - - - 35,000
364,965 69,646 434,611 167,947 - 167,947 266,664
Adjusted Construction Cost Total $ 7,256,260 $ (2,000) $ 7,254,260 $ 4,188,632 $ 102,444 $ 4,291,076 $ 2,963,184
Off Site Services
Off Site Design 30,000 2,000 32,000 32,802 - 32,802 (802)
Storm Drain 60,000 - 60,000 43,607 - 43,607 16,393
Traffic Control (fire warning flashers) 30,000 - 30,000 650 - 650 29,350
Traffic Islands / Painting 5,000 - 5,000 - - - 5,000
Fibre and Electrical Conduits Crossing 20,900 - 20,900 8,775 - 8,775 12,125
$ 145,900 $ 2,000 $ 147,900 $ 85,833 $ - $ 85,833 $ 62,067

Budget after Tender Revisions Revised Budget As at July 24, 2014 Committed Total Budget Variance

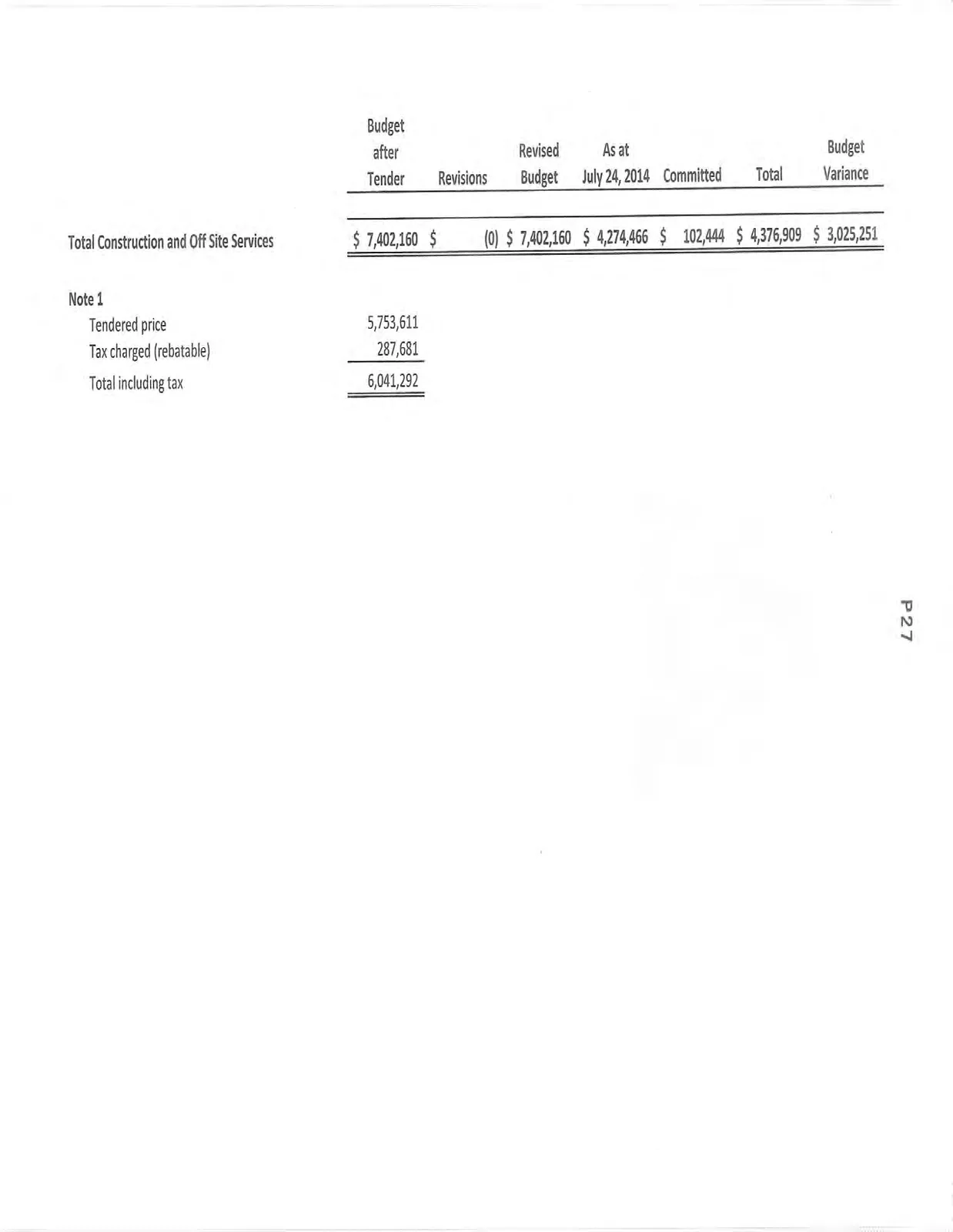

Total Construction and Off Site Services $ 7,402,160 $ (0) $ 7,402,160 $ 4,274,466 $ 102,444 $ 4,376,909 $ 3,025,251

Note 1 Tendered price: 5,753,611 Tax charged (rebatable): 287,681 Total including tax: 6,041,292

Page 23–32
