Committee of the Whole/Documents/View Royal Public Safety Building Monthly Report for November 2014
Staff Report

View Royal Public Safety Building Monthly Report for November 2014

December 9, 2014Pages 24–3211 sections

Architectural progress report for the construction of the new Public Safety Building, including site photos and construction status.

Date of report: 4 December 2014Owner deficiency walk through expected December 18Paving scheduled for December 15-19

View Royal Public Safety Building

Page 24–32

Town of View Royal

Page 24–32

Monthly Report for November 2014

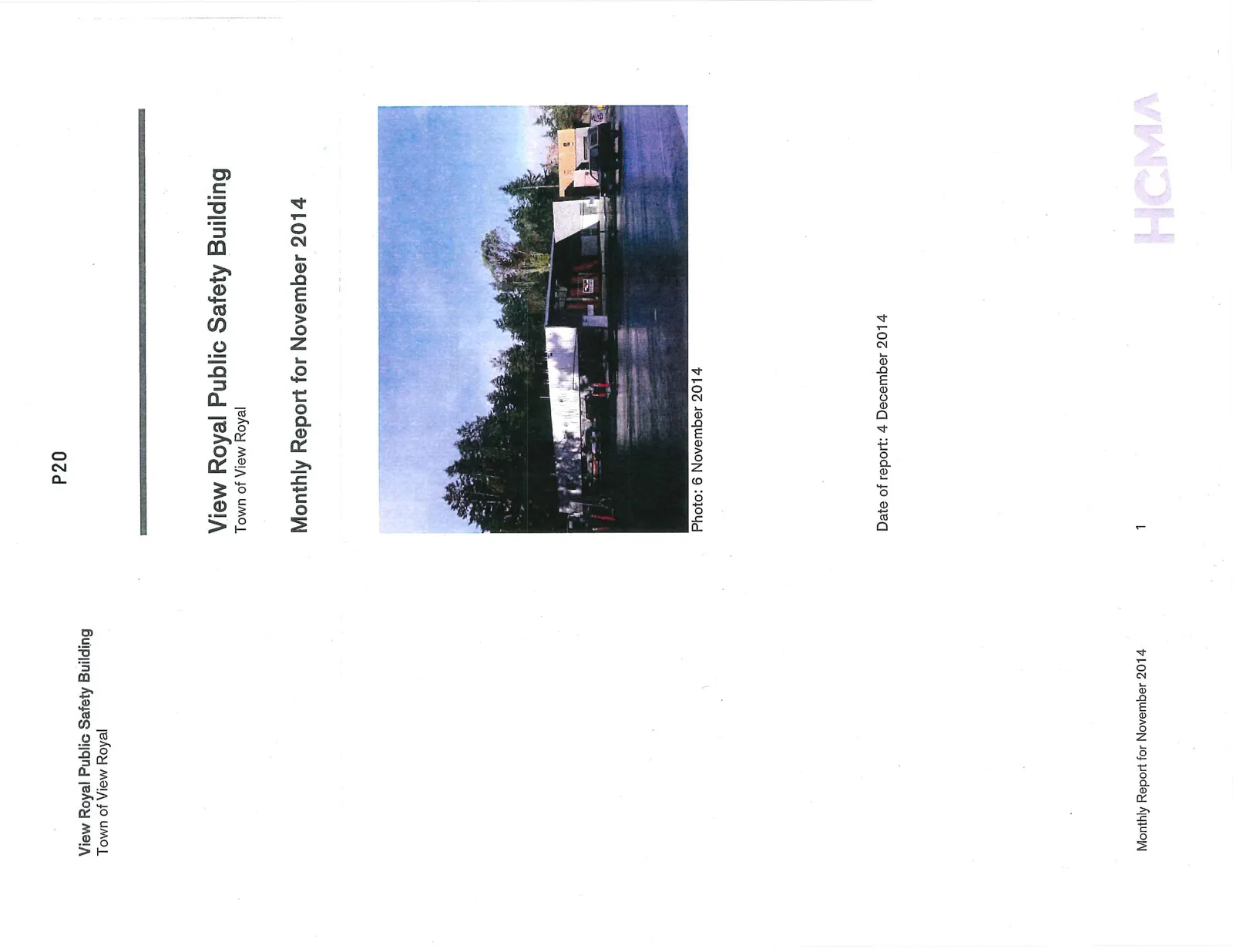

Exterior view of the Public Safety Building construction site, 6 November 2014
Exterior view of the Public Safety Building construction site, 6 November 2014

Date of report: 4 December 2014

Page 24–32

Monthly Report for November 2014

PREPARED FOR: Kim Anema, Chief Administrative Officer Town of View Royal

Paul Hurst, Fire Chief, Emergency Program Coordinator View Royal Fire Rescue

PREPARED BY: Heather Spinney, Architect AIBC Hughes Condon Marler Architects

CONTENTS:

  • Introduction: 3
  • Status of Project: 3
  • Work Progress: 3
  • Progress Photographs: 4-6
  • Supplemental Instructions: 7
  • Change Orders / Change Directives: 7
  • Appendix A Schedule

Page 24–32

INTRODUCTION

This report summarizes the progress and status of the View Royal Public Safety Building up to the end of the month of November 2014.

Page 24–32

STATUS OF PROJECT

2 Construction Coordination Meetings have been conducted.

  • Installation of civil, mechanical & electrical infrastructure in progress.
  • Installation of fenestration in progress
  • Installation of exterior finishes in progress
  • Installation of interior finishes / assemblies in progress
Page 24–32

WORK PROGRESS

Key tasks started, in progress or completed this month include:

  • Grading
  • Concrete Curbs + Exterior Concrete Slabs + Paving
  • Interior Concrete Slabs
  • Civil, Mechanical + Electrical Infrastructure
  • Installation of interior finishes / assemblies

Refer to the following pages for photographs illustrating the current progress of construction.

Progress Photographs

Aerial view of the construction site with concrete pump truck and curved driveway, 20 November 2014
Aerial view of the construction site with concrete pump truck and curved driveway, 20 November 2014

Interior construction area with overhead structures and orange plastic partitions, 6 November 2014
Interior construction area with overhead structures and orange plastic partitions, 6 November 2014

Close-up of interior floor rebar grid being prepared for concrete pour, 20 November 2014
Close-up of interior floor rebar grid being prepared for concrete pour, 20 November 2014

Page 24–32

SUPPLEMENTAL INSTRUCTIONS

The following Supplemental Instructions have been issued up to November 30, 2014:

  • SI No. 105R – ESI 14 – Relocate Type D Fixture to Utility 209. Issued 7 November, 2014.
  • SI No. 106 – Swale – Alternate Detail. Issued 4 November, 2014.
  • SI No. 107 – Window 101 – MDF Sill. Issued 4 November, 2014.
  • SI No. 108 – Corner Guard Locations. Issued 4 November, 2014.
  • SI No. 109 – Athletic Flooring – Joint Locations. Issued 12 November, 2014.
  • SI No. 110 – RFI 990155 – Western Sidewalk. Issued 18 November, 2014.
  • SI No. 111 – Relocated Fixture Type A. Issued 27 November, 2014.
  • SI No. 112 – Epoxy Flooring Location. Issued 27 November, 2014.
Page 24–32

CHANGE ORDERS

The following Change Orders have been issued up to November 30, 2014:

  • CO No. 100: CD 08 – Assoc. Rm – Extend Flat Ceiling. Issued 17 November, 2014.
  • CO No. 101: CD 11 – ECCN-16 - Conduit to Suites + Delete Exhaust Fan Switches. Issued 17 November, 2014.
  • CO No. 102: CD 13 – Assoc. Rm 202 - Backup for Equipment. Issued 18 November, 2014.
  • CO No. 103: CD 14 – RFI 125 - Penetration for Kitchen Exhaust. Issued 17 November, 2014.
  • CO No. 104: CD 15 – PCN 86 - Curb Cut. Issued 17 November, 2014.

Page 24–32

MECHANICAL SYSTEMS COMMISSIONING SCHEDULE

MECHANICAL CONTRACTOR: PROFESSIONAL MECHANICAL

COMMISSIONING SCHEDULE TASKS DATES
GENERAL
Building Clean For HVAC Start-Ups Dec. 8
Substantial Completion Dec. 15
ELECTRICAL
Building Mechanical Connected Dec. 8
Building Mechanical Energized Dec. 8
Fire & Life Safety Systems Verified Dec. 11
CONTROLS
Building Installation Complete Dec. 8
Building Equipment Activation Dec. 8
Commissioning Dec. 8 - 12
MECHANICAL
Equipment Installation Complete Nov. 19
PRE-START CHECKS
Pumps Nov. 24
Air Handler Nov. 24
Exhaust Fans Nov. 24
Heat Pump Units Nov. 24
Boilers Nov. 24
START-UPS
Pumps Dec. 4
Air Handler Dec. 9
Exhaust Fans Dec. 9
Heat Pump Units Dec. 9
Boilers Dec. 5
Chemical Cleaning Dec. 12
BALANCING
Air Balance Dec. 9 - 12
Water Balance Dec. 9 - 12

Page 24–32

Ledcor projection for building during December (from December 4 meeting)

Paving will take place December 15 – 19. All concrete issues will be previously concluded.

Garage Door install begins December 8 duration for the install is 2-3 weeks

Apparatus Bay GWB to be removed beginning Dec 6

December 15 Ledcor will establish a deficiency list

The Owner will do a deficiency walk through December 18 expecting to establish the agreed upon deficiency list

December 19 Commissioning of the building

Soffit material at the front of the building is still an issue to be concluded. Install of soffits will likely be the new year.

Page 24–32
