Appendix
PUBLIC SAFETY BUILDING - Budget Analysis
December 9, 2014Pages 33–351 section
Detailed financial breakdown of the project budget, revisions, and actual expenditures for the Public Safety Building.
Adjusted Construction Cost Total: $7,256,260Total Construction and Off Site Services Budget: $7,402,160

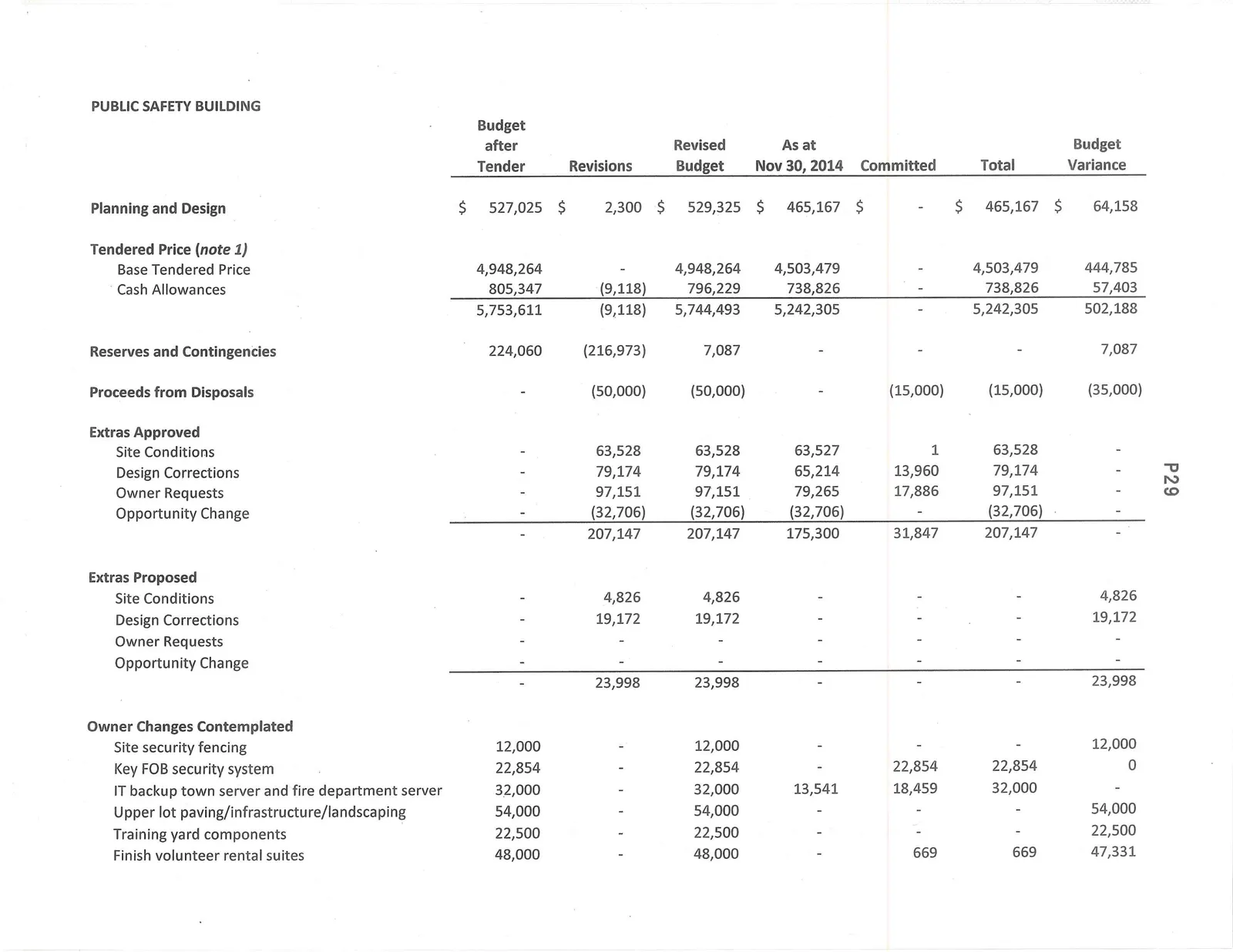

PUBLIC SAFETY BUILDING

| Description | Budget after Tender | Revisions | Revised Budget | As at Nov 30, 2014 | Committed | Total | Budget Variance |
|---|---|---|---|---|---|---|---|
| Planning and Design | $ 527,025 | $ 2,300 | $ 529,325 | $ 465,167 | $ - | $ 465,167 | $ 64,158 |
| Tendered Price (note 1) | |||||||
| Base Tendered Price | 4,948,264 | - | 4,948,264 | 4,503,479 | - | 4,503,479 | 444,785 |
| Cash Allowances | 805,347 | (9,118) | 796,229 | 738,826 | - | 738,826 | 57,403 |
| Subtotal Tendered Price | 5,753,611 | (9,118) | 5,744,493 | 5,242,305 | - | 5,242,305 | 502,188 |
| Reserves and Contingencies | 224,060 | (216,973) | 7,087 | - | - | - | 7,087 |
| Proceeds from Disposals | - | (50,000) | (50,000) | - | (15,000) | (15,000) | (35,000) |
| Extras Approved | |||||||
| Site Conditions | - | 63,528 | 63,528 | 63,527 | 1 | 63,528 | - |
| Design Corrections | - | 79,174 | 79,174 | 65,214 | 13,960 | 79,174 | - |
| Owner Requests | - | 97,151 | 97,151 | 79,265 | 17,886 | 97,151 | - |
| Opportunity Change | - | (32,706) | (32,706) | (32,706) | - | (32,706) | - |
| Subtotal Extras Approved | - | 207,147 | 207,147 | 175,300 | 31,847 | 207,147 | - |
| Extras Proposed | |||||||
| Site Conditions | - | 4,826 | 4,826 | - | - | - | 4,826 |
| Design Corrections | - | 19,172 | 19,172 | - | - | - | 19,172 |
| Owner Requests | - | - | - | - | - | - | - |
| Opportunity Change | - | - | - | - | - | - | - |
| Subtotal Extras Proposed | - | 23,998 | 23,998 | - | - | - | 23,998 |
| Owner Changes Contemplated | |||||||
| Site security fencing | 12,000 | - | 12,000 | - | - | - | 12,000 |
| Key FOB security system | 22,854 | - | 22,854 | - | 22,854 | 22,854 | 0 |
| IT backup town server and fire department server | 32,000 | - | 32,000 | 13,541 | 18,459 | 32,000 | - |
| Upper lot paving/infrastructure/landscaping | 54,000 | - | 54,000 | - | - | - | 54,000 |
| Training yard components | 22,500 | - | 22,500 | - | - | - | 22,500 |
| Finish volunteer rental suites | 48,000 | - | 48,000 | - | 669 | 669 | 47,331 |

| Description | Budget after Tender | Revisions | Revised Budget | As at Nov 30, 2014 | Committed | Total | Budget Variance |
|---|---|---|---|---|---|---|---|
| LED community message board | 40,000 | - | 40,000 | - | - | - | 40,000 |
| Building maintenance equipment | 6,000 | - | 6,000 | - | - | - | 6,000 |
| Finish trailer enclosure | 15,000 | - | 15,000 | - | - | - | 15,000 |
| Mezzanine winch and beam | 10,000 | - | 10,000 | - | - | - | 10,000 |
| Amount available for overages | 124,245 | (29,000) | 95,245 | - | - | - | 95,245 |
| Subtotal Owner Changes Contemplated | 386,599 | (29,000) | 357,599 | 13,541 | 41,982 | 55,523 | 302,076 |
| Completion Costs | |||||||
| Furniture & Equipment | 150,000 | - | 150,000 | 63,517 | - | 63,517 | 86,483 |
| DCC | 41,760 | - | 41,760 | 41,760 | - | 41,760 | 0 |
| Building Permit/Testing Structural and Geotech. | 25,750 | 25,000 | 50,750 | 59,528 | - | 59,528 | (8,778) |
| Connection Fees (BC Hydro Fee) | 48,115 | 15,986 | 64,101 | 59,896 | - | 59,896 | 4,205 |
| Administration Costs | 10,000 | - | 10,000 | 425 | - | 425 | 9,575 |
| Legal Costs | 8,000 | 40,000 | 48,000 | 9,033 | - | 9,033 | 38,967 |
| Insurance Costs | 11,340 | (11,340) | - | - | - | - | - |
| Public Art | 35,000 | - | 35,000 | - | - | - | 35,000 |
| Operation/Startup Costs | 35,000 | - | 35,000 | 819 | - | 819 | 34,181 |
| Subtotal Completion Costs | 364,965 | 69,646 | 434,611 | 234,977 | - | 234,977 | 199,634 |
| Adjusted Construction Cost Total | $ 7,256,260 | $ (2,000) | $ 7,254,260 | $ 6,131,290 | $ 58,829 | $ 6,190,119 | $ 1,064,141 |

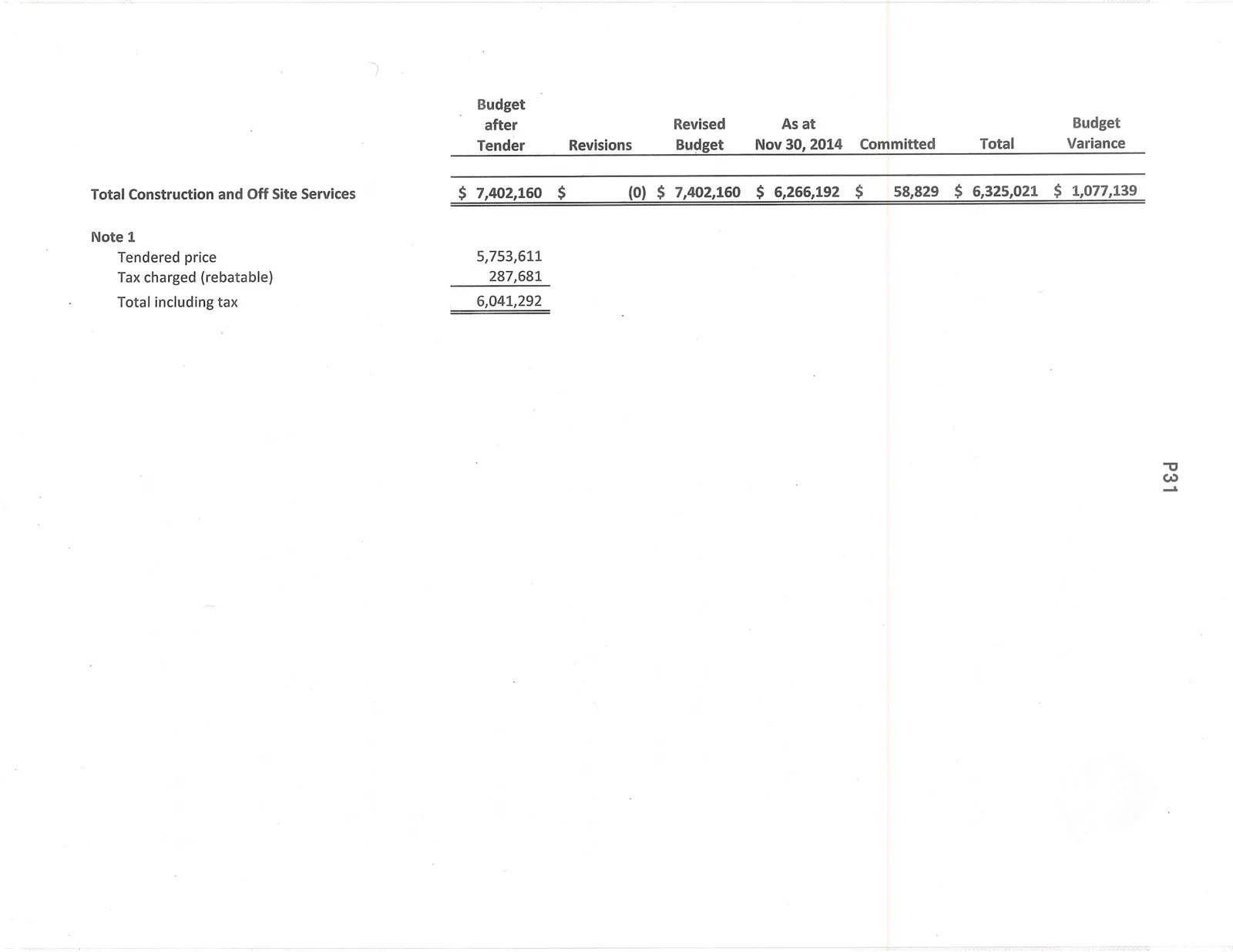

| Off Site Services | |||||||
| Off Site Design | 30,000 | 2,000 | 32,000 | 42,832 | - | 42,832 | (10,832) |
| Storm Drain | 60,000 | - | 60,000 | 45,427 | - | 45,427 | 14,573 |
| Traffic Control (fire warning flashers) | 30,000 | - | 30,000 | 37,868 | - | 37,868 | (7,868) |
| Traffic Islands / Painting | 5,000 | - | 5,000 | - | - | - | 5,000 |
| Fibre and Electrical Conduits Crossing | 20,900 | - | 20,900 | 8,775 | - | 8,775 | 12,125 |
| Subtotal Off Site Services | $ 145,900 | $ 2,000 | $ 147,900 | $ 134,901 | $ - | $ 134,901 | $ 12,999 |

| Description | Budget after Tender | Revisions | Revised Budget | As at Nov 30, 2014 | Committed | Total | Budget Variance |
|---|---|---|---|---|---|---|---|
| Total Construction and Off Site Services | $ 7,402,160 | $ (0) | $ 7,402,160 | $ 6,266,192 | $ 58,829 | $ 6,325,021 | $ 1,077,139 |
Note 1
| Description | Amount |
|---|---|
| Tendered price | 5,753,611 |
| Tax charged (rebatable) | 287,681 |
| Total including tax | 6,041,292 |
Page 33–35
Extracted from: 2014 12 09 Committee of the Whole Agenda
