Appendix
PUBLIC SAFETY BUILDING BUDGET SUMMARY (As at Feb 28, 2015)
March 10, 2015Pages 35–371 section
Financial summary of the Public Safety Building project budget, revisions, and variances.
Total Construction and Off Site Services Revised Budget: $7,402,160Total Variance: $595,873

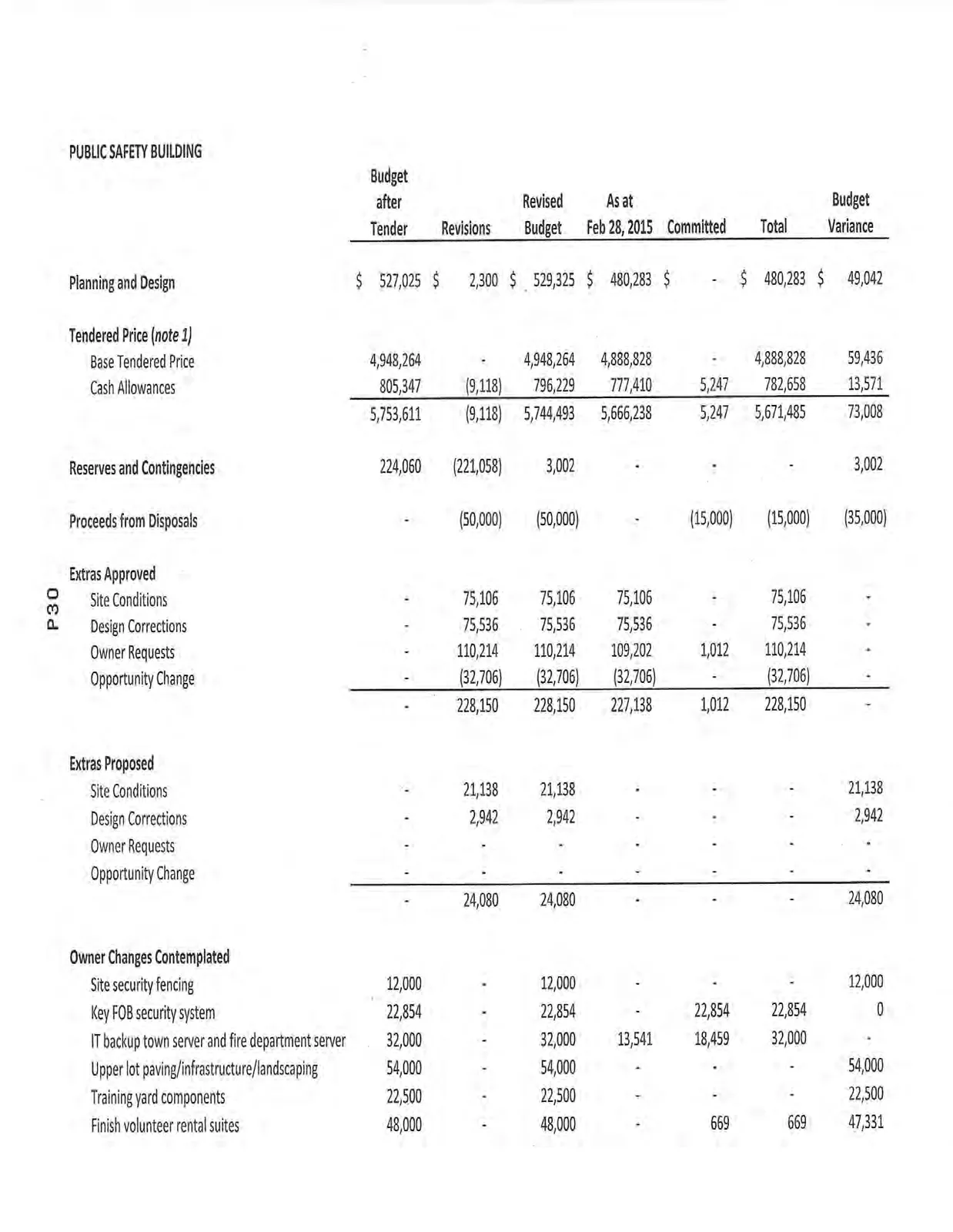

PUBLIC SAFETY BUILDING

| Item | Budget after Tender | Revisions | Revised Budget | As at Feb 28, 2015 | Committed | Total | Budget Variance |
|---|---|---|---|---|---|---|---|
| Planning and Design | $ 527,025 | $ 2,300 | $ 529,325 | $ 480,283 | $ - | $ 480,283 | $ 49,042 |
| Tendered Price (note 1) | |||||||
| Base Tendered Price | 4,948,264 | - | 4,948,264 | 4,888,828 | - | 4,888,828 | 59,436 |
| Cash Allowances | 805,347 | (9,118) | 796,229 | 777,410 | 5,247 | 782,658 | 13,571 |
| Total Tendered Price | 5,753,611 | (9,118) | 5,744,493 | 5,666,238 | 5,247 | 5,671,485 | 73,008 |
| Reserves and Contingencies | 224,060 | (221,058) | 3,002 | - | - | - | 3,002 |
| Proceeds from Disposals | - | (50,000) | (50,000) | - | (15,000) | (15,000) | (35,000) |
| Extras Approved | |||||||
| Site Conditions | - | 75,106 | 75,106 | 75,106 | - | 75,106 | - |
| Design Corrections | - | 75,536 | 75,536 | 75,536 | - | 75,536 | - |
| Owner Requests | - | 110,214 | 110,214 | 109,202 | 1,012 | 110,214 | - |
| Opportunity Change | - | (32,706) | (32,706) | (32,706) | - | (32,706) | - |
| Total Extras Approved | - | 228,150 | 228,150 | 227,138 | 1,012 | 228,150 | - |
| Extras Proposed | |||||||
| Site Conditions | - | 21,138 | 21,138 | - | - | - | 21,138 |
| Design Corrections | - | 2,942 | 2,942 | - | - | - | 2,942 |
| Owner Requests | - | - | - | - | - | - | - |
| Opportunity Change | - | - | - | - | - | - | - |
| Total Extras Proposed | - | 24,080 | 24,080 | - | - | - | 24,080 |
| Owner Changes Contemplated | |||||||
| Site security fencing | 12,000 | - | 12,000 | - | - | - | 12,000 |
| Key FOB security system | 22,854 | - | 22,854 | - | 22,854 | 22,854 | 0 |
| IT backup town server and fire department server | 32,000 | - | 32,000 | 13,541 | 18,459 | 32,000 | - |
| Upper lot paving/infrastructure/landscaping | 54,000 | - | 54,000 | - | - | - | 54,000 |
| Training yard components | 22,500 | - | 22,500 | - | - | - | 22,500 |
| Finish volunteer rental suites | 48,000 | - | 48,000 | - | 669 | 669 | 47,331 |

| Item | Budget after Tender | Revisions | Revised Budget | As at Feb 28, 2015 | Committed | Total | Budget Variance |
|---|---|---|---|---|---|---|---|
| LED community message board | 40,000 | - | 40,000 | - | - | - | 40,000 |
| Building maintenance equipment | 6,000 | - | 6,000 | - | - | - | 6,000 |
| Finish trailer enclosure | 15,000 | - | 15,000 | - | - | - | 15,000 |
| Mezzanine winch and beam | 10,000 | - | 10,000 | - | - | - | 10,000 |
| Amount available for overages | 124,245 | (46,000) | 78,245 | - | - | - | 78,245 |
| Total (Contemplated/Overages) | 386,599 | (46,000) | 340,599 | 13,541 | 41,982 | 55,523 | 285,076 |
| Completion Costs | |||||||
| Furniture & Equipment | 150,000 | - | 150,000 | 117,556 | - | 117,556 | 32,444 |
| DCC | 41,760 | - | 41,760 | 41,760 | - | 41,760 | 0 |
| Building Permit/Testing Structural and Geotech. | 25,750 | 25,000 | 50,750 | 63,533 | - | 63,533 | (12,783) |
| Connection Fees (BC Hydro Fee) | 48,115 | 15,986 | 64,101 | 59,896 | - | 59,896 | 4,205 |
| Administration Costs | 10,000 | - | 10,000 | 3,876 | - | 3,876 | 6,124 |
| Legal Costs | 8,000 | 40,000 | 48,000 | 22,275 | - | 22,275 | 25,725 |
| Insurance Costs | 11,340 | (11,340) | - | - | - | - | - |
| Public Art | 35,000 | - | 35,000 | - | - | - | 35,000 |
| Operation/Startup Costs | 35,000 | - | 35,000 | 819 | - | 819 | 34,181 |
| Total Completion Costs | 364,965 | 69,646 | 434,611 | 309,714 | - | 309,714 | 124,897 |
| Adjusted Construction Cost Total | $ 7,256,260 | $ (2,000) | $ 7,254,260 | $ 6,696,914 | $ 33,242 | $ 6,730,155 | $ 524,105 |
| Off Site Services | |||||||
| Off Site Design | 30,000 | 2,000 | 32,000 | 25,800 | - | 25,800 | 6,200 |
| Storm Drain | 60,000 | - | 60,000 | - | - | - | 60,000 |
| Traffic Control (fire warning flashers) | 30,000 | - | 30,000 | 39,407 | - | 39,407 | (9,407) |
| Traffic Islands / Painting | 5,000 | - | 5,000 | 2,150 | - | 2,150 | 2,850 |
| Fibre and Electrical Conduits Crossing | 20,900 | - | 20,900 | 8,775 | - | 8,775 | 12,125 |
| Total Off Site Services | $ 145,900 | $ 2,000 | $ 147,900 | $ 76,132 | $ - | $ 76,132 | $ 71,768 |

| Item | Budget after Tender | Revisions | Revised Budget | As at Feb 28, 2015 | Committed | Total | Budget Variance |
|---|---|---|---|---|---|---|---|

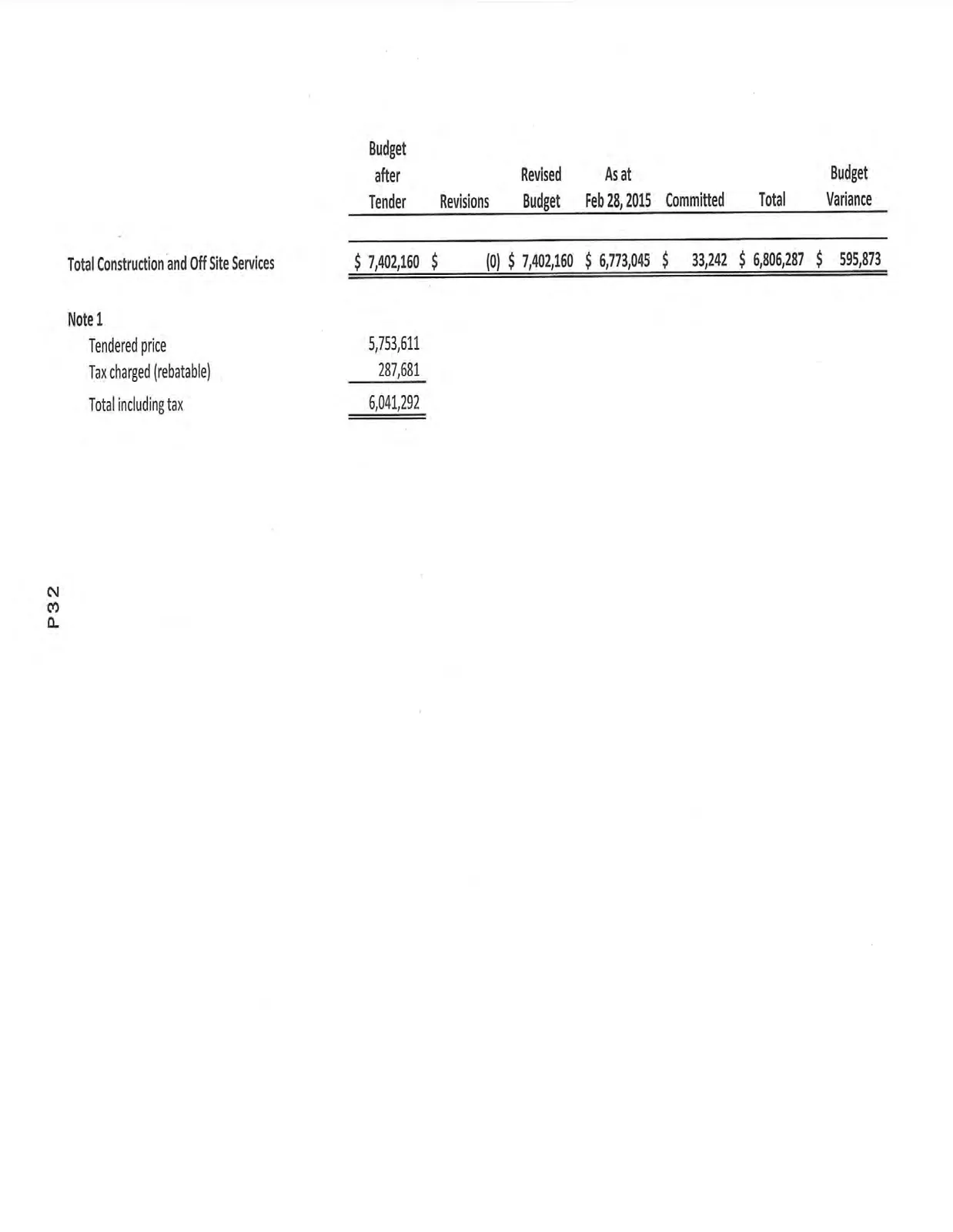

| Total Construction and Off Site Services | $ 7,402,160 | $ (0) | $ 7,402,160 | $ 6,773,045 | $ 33,242 | $ 6,806,287 | $ 595,873 |
Note 1
- Tendered price: 5,753,611
- Tax charged (rebatable): 287,681
- Total including tax: 6,041,292
Page 35–37
Extracted from: 2015 03 10 Committee of the Whole Agenda
