Appendix
PUBLIC SAFETY BUILDING Financial Summary
February 10, 2015Pages 29–311 section
Financial ledger detailing the budget, revisions, and actual costs for the Public Safety Building project as of January 31, 2015.
Revised Budget: $7,402,160Total actuals as of Jan 31, 2015: $6,548,588Adjusted Construction Cost Total: $6,523,607
PUBLIC SAFETY BUILDING

| Description | Budget after Tender | Revisions | Revised Budget | As at Jan 31, 2015 | Committed | Total | Budget Variance |
|---|---|---|---|---|---|---|---|

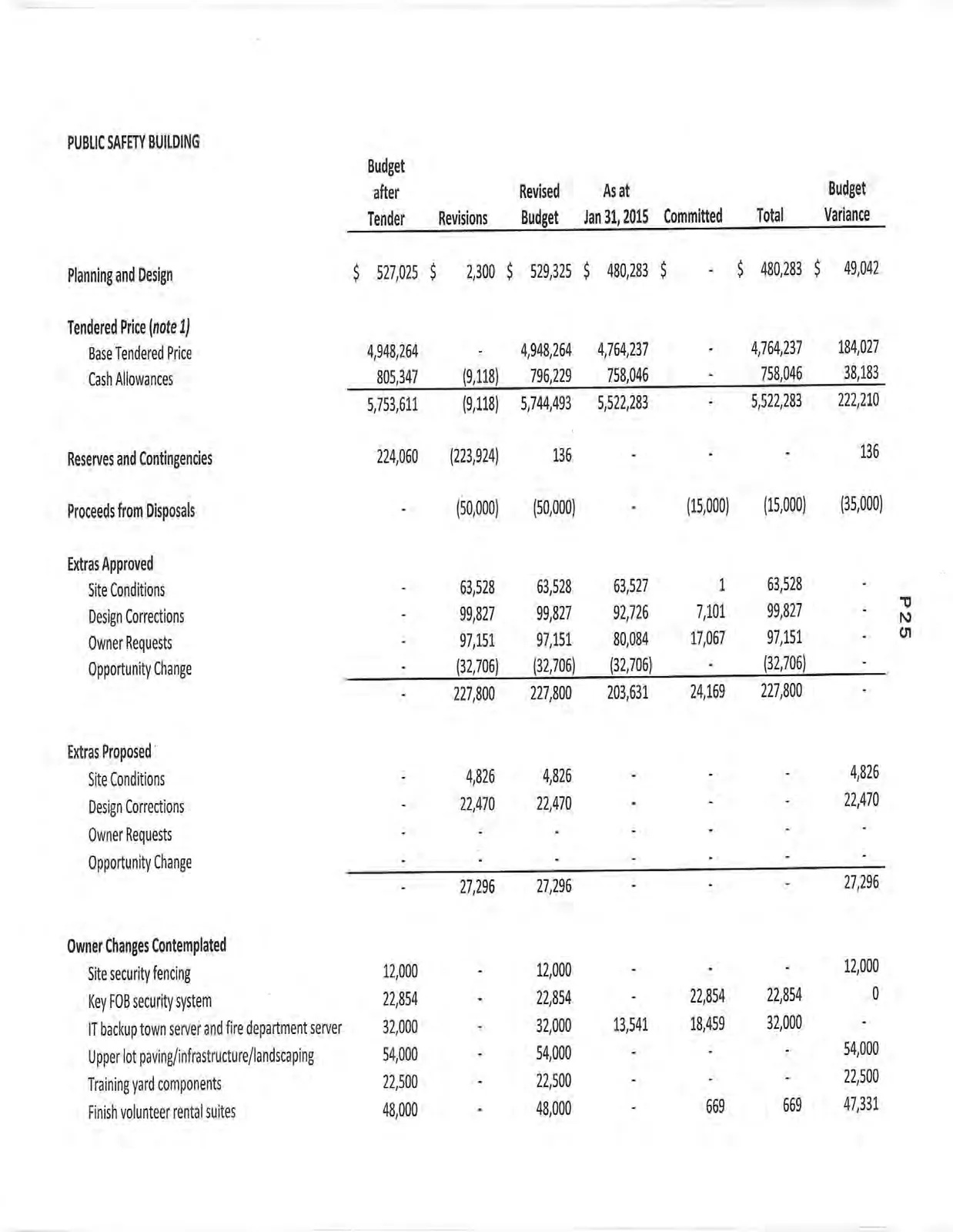

| Planning and Design | $ 527,025 | $ 2,300 | $ 529,325 | $ 480,283 | $ - | $ 480,283 | $ 49,042 |
| Tendered Price (note 1) | |||||||
| Base Tendered Price | 4,948,264 | - | 4,948,264 | 4,764,237 | - | 4,764,237 | 184,027 |
| Cash Allowances | 805,347 | (9,118) | 796,229 | 758,046 | - | 758,046 | 38,183 |
| Subtotal Tendered Price | 5,753,611 | (9,118) | 5,744,493 | 5,522,283 | - | 5,522,283 | 222,210 |
| Reserves and Contingencies | 224,060 | (223,924) | 136 | - | - | - | 136 |
| Proceeds from Disposals | - | (50,000) | (50,000) | - | (15,000) | (15,000) | (35,000) |
| Extras Approved | |||||||
| Site Conditions | - | 63,528 | 63,528 | 63,527 | 1 | 63,528 | - |
| Design Corrections | - | 99,827 | 99,827 | 92,726 | 7,101 | 99,827 | - |
| Owner Requests | - | 97,151 | 97,151 | 80,084 | 17,067 | 97,151 | - |
| Opportunity Change | - | (32,706) | (32,706) | (32,706) | - | (32,706) | - |
| Subtotal Extras Approved | - | 227,800 | 227,800 | 203,631 | 24,169 | 227,800 | - |
| Extras Proposed | |||||||
| Site Conditions | - | 4,826 | 4,826 | - | - | - | 4,826 |
| Design Corrections | - | 22,470 | 22,470 | - | - | - | 22,470 |
| Owner Requests | - | - | - | - | - | - | - |
| Opportunity Change | - | - | - | - | - | - | - |
| Subtotal Extras Proposed | - | 27,296 | 27,296 | - | - | - | 27,296 |
| Owner Changes Contemplated | |||||||
| Site security fencing | 12,000 | - | 12,000 | - | - | - | 12,000 |
| Key FOB security system | 22,854 | - | 22,854 | - | 22,854 | 22,854 | 0 |
| IT backup town server and fire department server | 32,000 | - | 32,000 | 13,541 | 18,459 | 32,000 | - |
| Upper lot paving/infrastructure/landscaping | 54,000 | - | 54,000 | - | - | - | 54,000 |
| Training yard components | 22,500 | - | 22,500 | - | - | - | 22,500 |
| Finish volunteer rental suites | 48,000 | - | 48,000 | - | 669 | 669 | 47,331 |

| Description | Budget after Tender | Revisions | Revised Budget | As at Jan 31, 2015 | Committed | Total | Budget Variance |
|---|---|---|---|---|---|---|---|
| LED community message board | 40,000 | - | 40,000 | - | - | - | 40,000 |
| Building maintenance equipment | 6,000 | - | 6,000 | - | - | - | 6,000 |
| Finish trailer enclosure | 15,000 | - | 15,000 | - | - | - | 15,000 |
| Mezzanine winch and beam | 10,000 | - | 10,000 | - | - | - | 10,000 |
| Amount available for overages | 124,245 | (46,000) | 78,245 | - | - | - | 78,245 |
| Subtotal Owner Changes | 386,599 | (46,000) | 340,599 | 13,541 | 41,982 | 55,523 | 285,076 |
| Completion Costs | |||||||
| Furniture & Equipment | 150,000 | - | 150,000 | 67,650 | - | 67,650 | 82,350 |
| DCC | 41,760 | - | 41,760 | 41,760 | - | 41,760 | 0 |
| Building Permit/Testing Structural and Geotech. | 25,750 | 25,000 | 50,750 | 63,533 | - | 63,533 | (12,783) |
| Connection Fees (BC Hydro Fee) | 48,115 | 15,986 | 64,101 | 59,896 | - | 59,896 | 4,205 |
| Administration Costs | 10,000 | - | 10,000 | 1,041 | - | 1,041 | 8,959 |
| Legal Costs | 8,000 | 40,000 | 48,000 | 18,020 | - | 18,020 | 29,980 |
| Insurance Costs | 11,340 | (11,340) | - | - | - | - | - |
| Public Art | 35,000 | - | 35,000 | - | - | - | 35,000 |
| Operation/Startup Costs | 35,000 | - | 35,000 | 819 | - | 819 | 34,181 |
| Subtotal Completion Costs | 364,965 | 69,646 | 434,611 | 252,719 | - | 252,719 | 181,892 |
| Adjusted Construction Cost Total | $ 7,256,260 | $ (2,000) | $ 7,254,260 | $ 6,472,456 | $ 51,151 | $ 6,523,607 | $ 730,653 |
| Off Site Services | |||||||
| Off Site Design | 30,000 | 2,000 | 32,000 | 25,800 | - | 25,800 | 6,200 |
| Storm Drain | 60,000 | - | 60,000 | - | - | - | 60,000 |
| Traffic Control (fire warning flashers) | 30,000 | - | 30,000 | 39,407 | - | 39,407 | (9,407) |
| Traffic Islands / Painting | 5,000 | - | 5,000 | 2,150 | - | 2,150 | 2,850 |
| Fibre and Electrical Conduits Crossing | 20,900 | - | 20,900 | 8,775 | - | 8,775 | 12,125 |
| Subtotal Off Site Services | $ 145,900 | $ 2,000 | $ 147,900 | $ 76,132 | $ - | $ 76,132 | $ 71,768 |

| Description | Budget after Tender | Revisions | Revised Budget | As at Jan 31, 2015 | Committed | Total | Budget Variance |
|---|---|---|---|---|---|---|---|

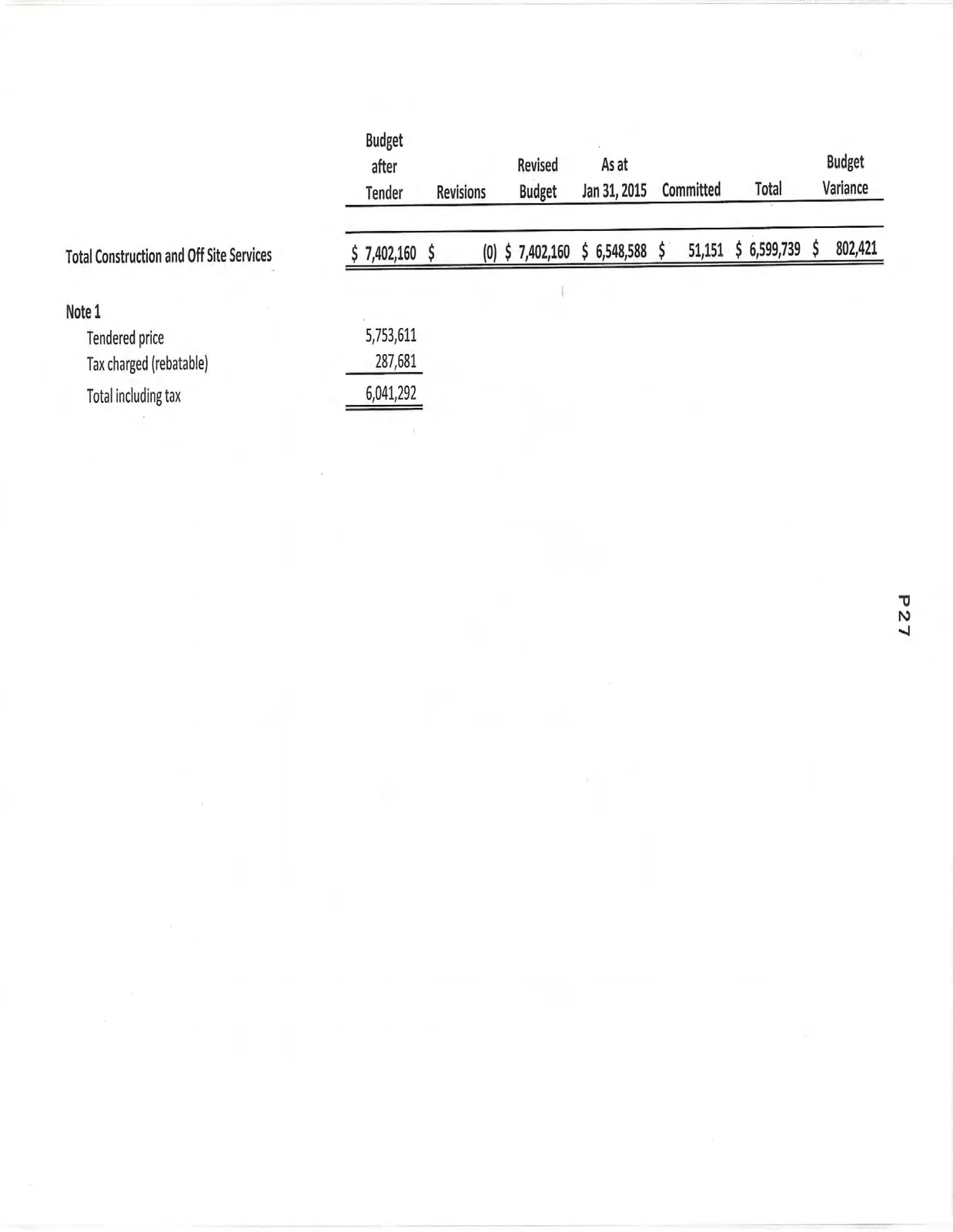

| Total Construction and Off Site Services | $ 7,402,160 | $ (0) | $ 7,402,160 | $ 6,548,588 | $ 51,151 | $ 6,599,739 | $ 802,421 |
Note 1
| Description | Amount |
|---|---|
| Tendered price | 5,753,611 |
| Tax charged (rebatable) | 287,681 |
| Total including tax | 6,041,292 |
Page 29–31
