Committee of the Whole/Documents/Presentation: West Shore RCMP Facility Expansion Council Validation
Presentation
Presentation: West Shore RCMP Facility Expansion Council Validation
January 13, 2026Pages 462–4697 sections
Presentation slides summarizing the project summary, financial implications, and justification for the RCMP facility expansion.
View Royal share of debt-servicing: $1,095,000 per yearEarly cost estimate: $180/year per representative homeCombined structure size: 81,665 square feet
West Shore RCMP Facility Expansion
Council Validation

Committee of the Whole – January 13th, 2026
Page 462–469
Project Summary
The West Shore RCMP Facility Expansion Project will consist of:

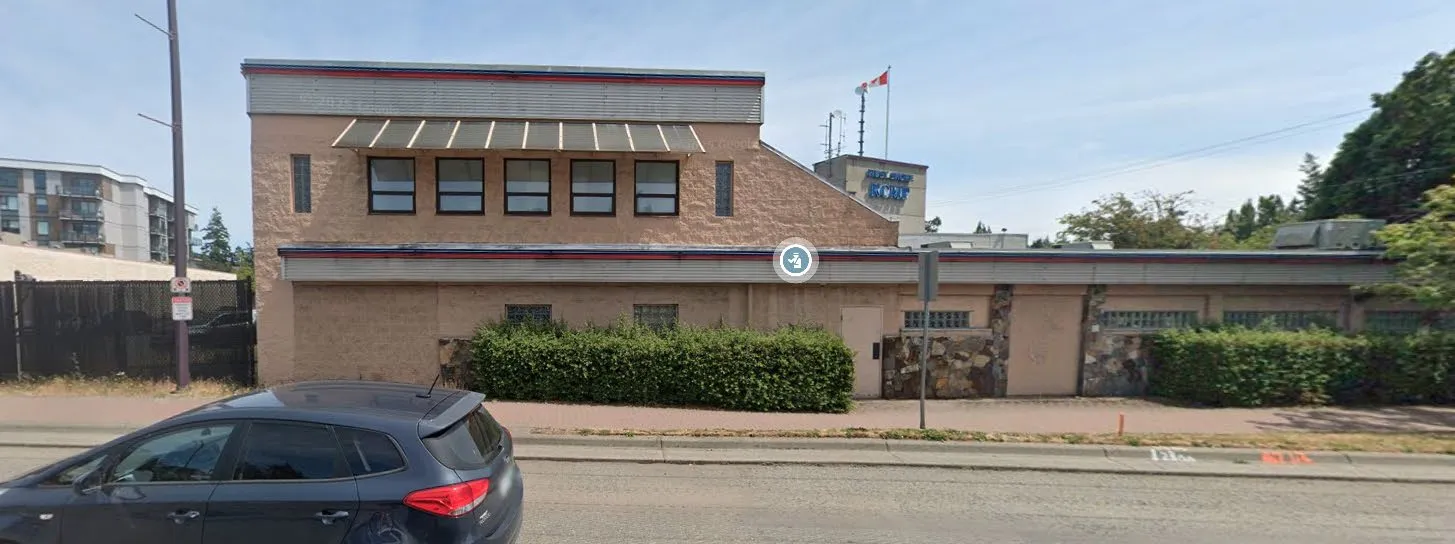

- the demolition of the 1966 portion of the facility (7,642 square feet)

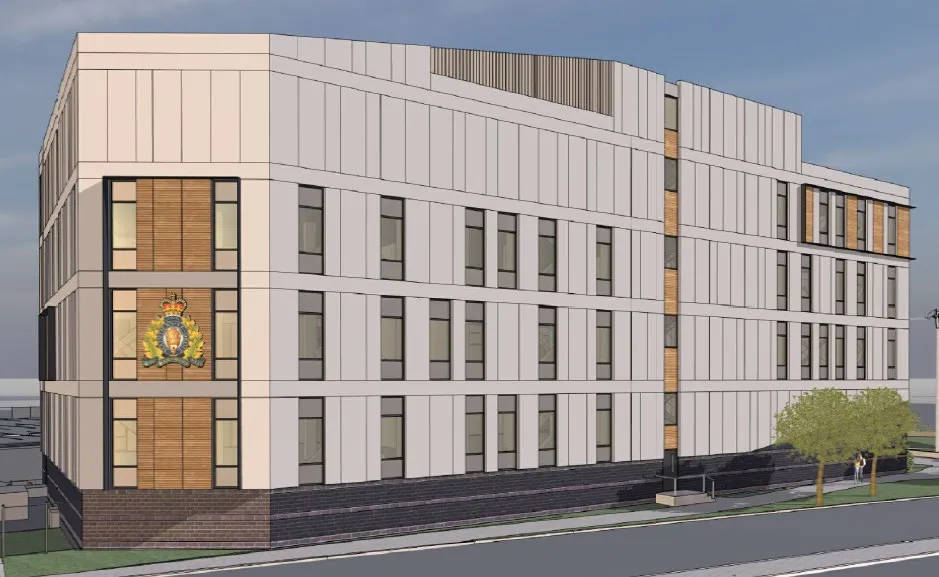

- the construction of a new facility in its place (55,714 square feet) to current post-disaster, accessibility, and Step Code sustainability standards
- renovations to the 1999 portion of the facility (25,941 square feet)

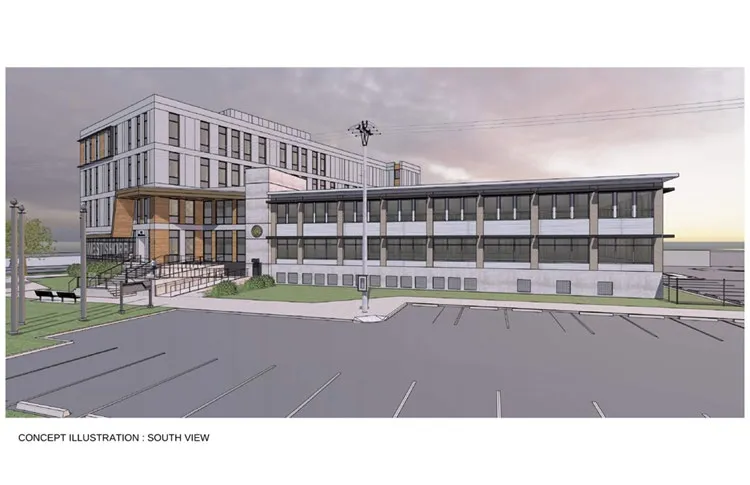

- the development of a combined structure (81,665 square feet) to accommodate the RCMP for the next 25 years
Page 462–469
Financial Implications
- The CRD estimates the annual debt-servicing on $103M over 25 years at $7.3M per year.
- The apportionment between the Owners is based 50% on population and 50% on assessments
- Current apportionments are approximately 60% Langford, 25% Colwood, and 15% View Royal
- View Royal’s 15% share of $7.3M per year equates to a requisition of $1,095,000 per year.
- The requisition will be offset from leases to Metchosin, the Province, and the Firearms program.
- The CRD will consider a Development Cost Charge (DCC) program to offset capital costs related to growth, although requiring considerable staff resources.
- Early estimates are $180/year per representative home without factoring in offsets.
Page 462–469
Project Justification
- The 1966 portion of the facility is reaching the end of its 60-year expected life.
- The last expansion of the RCMP building was in 1999 and was expected to provide adequate space for 12-15 years.
- The population of the West Shore communities has grown from 46,387 (2001) to 104,188 (2025) with a resulting increase in officers and support staff.
- The population of the West Shore is expected to grow to approximately 150,000 by 2050 with a resulting increase in officers and support staff.
- Post-disaster construction ensures the safety and readiness of the RCMP in the event of a disaster
- Providing “adequate accommodations” is a contractual obligation under the Police Act and the Municipal Police Unit Agreement.
Page 462–469
Project Background
- The West Shore RCMP facility is co-owned by Langford, Colwood, and View Royal.
- West Shore RCMP also serve Metchosin, Highlands, Songhees Nation, and Xwspesum Nation.
- Superintendent Preston brought forward his concerns about insufficient space in 2019.
- RCMP provided Space Needs Assessments and architectural concepts in 2019 and 2020.
- Owner’s feasibility study recommended redeveloping the existing site in 2021.
- Joint Police Services Steering Committee (3 Mayors & 3 CAOs) was established in 2022.
- A Class D estimate of $82.4M plus 25% contingency ($103M) was recommended.
- Project plans were presented to the Steering Committee before and after the 2022 election.
- Steering Committee selects Integrated Project Delivery (IPD) procurement in 2023.
- View Royal, Langford and Colwood passed resolutions requesting the CRD to establish a sub-regional service to finance the expansion debt in 2023.

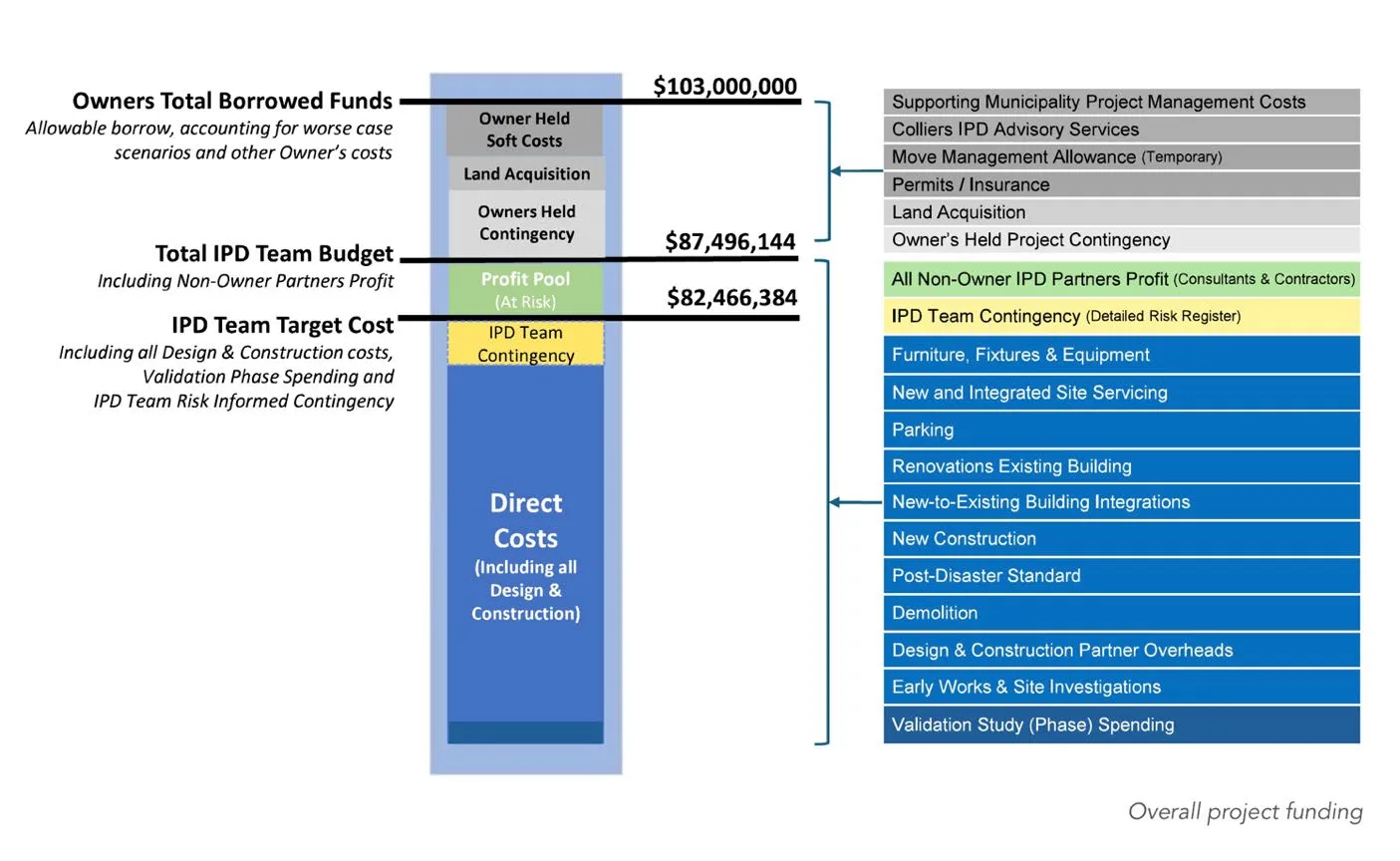

- A project budget of up to $103M was established with $87.5M for construction, and the remaining $15.5M for land, project management, insurance and contingency.
- A Validation budget of $1.2M was established in 2023, later increased to $2.1M in 2025.
- Colliers Project Leaders was selected as IPD Advisor in April 2024 through public procurement.
- General Contractor (Kinetic) and Architect (Group 2 & Stantec) were selected in September 2024.
- Engineers and Trades were selected through a public procurement process in November 2024
- The assembled IPD Team obtained security clearances and commenced the Validation Phase in late January 2025.
Page 462–469
Validation
- Validation is a process to determine if the project can be delivered for the target cost of $87.5M while meeting the Owner’s Conditions of Satisfaction
- The Conditions of Satisfaction include operational continuity, functional design, facility access, future-proofing to accommodate future growth, post-disaster resilience, and sustainability.
- The Validation Report represents the IPD partners commitment to design, construct and deliver the project that meets the Conditions of Satisfaction for the target cost of $87.5M.

Page 462–469
Recommendation
THAT the Committee recommends the following to Council:
a) Endorse the West Shore RCMP Facility Expansion Council Validation Report; and
b) Direct the CAO to prepare the necessary contracts for execution; and
c) Approve moving forward with the detailed design and construction of the project.


Page 462–469
Extracted from: 2026 01 13 Committee of the Whole Meeting - Agenda - Pdf
