VIEW ROYAL LIME KILN HERITAGE CONSERVATION PLAN TERMS OF REFERENCE - ESTIMATED BUDGET

March 10, 2020Page 2241 section

A detailed cost estimate for the Lime Kiln conservation project, broken down by professional fees and investigation stages.

2. APPROVAL OF AGENDA
Total Estimated Budget: $40,000Principal Fee: $150/hrHeritage Consultant Fee: $90/hr

VIEW ROYAL LIME KILN HERITAGE CONSERVATION PLAN TERMS OF REFERENCE

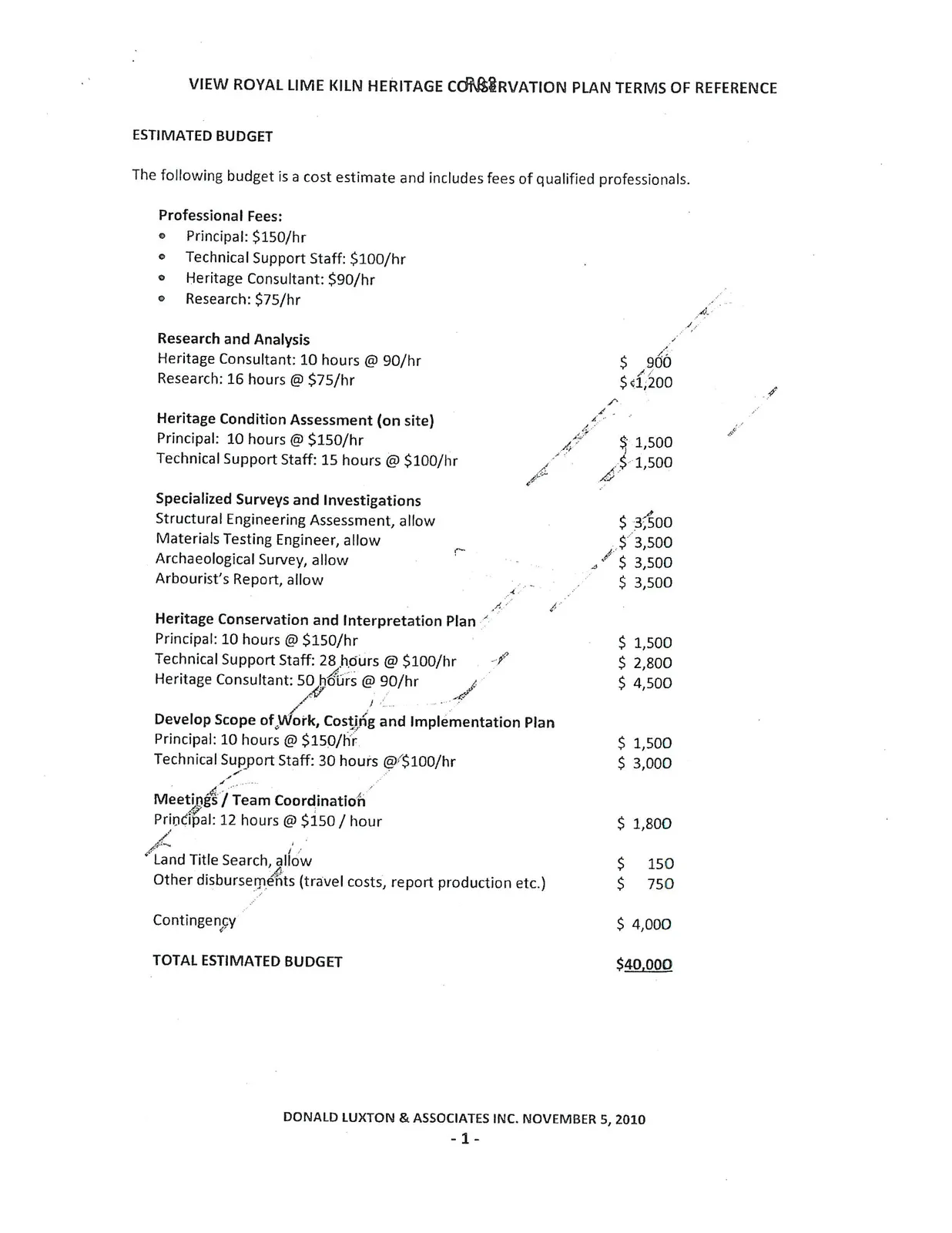

ESTIMATED BUDGET

The following budget is a cost estimate and includes fees of qualified professionals.

Professional Fees:

  • Principal: $150/hr
  • Technical Support Staff: $100/hr
  • Heritage Consultant: $90/hr
  • Research: $75/hr
Item Cost
Research and Analysis
Heritage Consultant: 10 hours @ 90/hr $ 900
Research: 16 hours @ $75/hr $ 1,200
Heritage Condition Assessment (on site)
Principal: 10 hours @ $150/hr $ 1,500
Technical Support Staff: 15 hours @ $100/hr $ 1,500
Specialized Surveys and Investigations
Structural Engineering Assessment, allow $ 3,500
Materials Testing Engineer, allow $ 3,500
Archaeological Survey, allow $ 3,500
Arbourist's Report, allow $ 3,500
Heritage Conservation and Interpretation Plan
Principal: 10 hours @ $150/hr $ 1,500
Technical Support Staff: 28 hours @ $100/hr $ 2,800
Heritage Consultant: 50 hours @ 90/hr $ 4,500
Develop Scope of Work, Costing and Implementation Plan
Principal: 10 hours @ $150/hr $ 1,500
Technical Support Staff: 30 hours @ $100/hr $ 3,000
Meetings / Team Coordination
Principal: 12 hours @ $150 / hour $ 1,800
Land Title Search, allow $ 150
Other disbursements (travel costs, report production etc.) $ 750
Contingency $ 4,000
TOTAL ESTIMATED BUDGET $40,000
