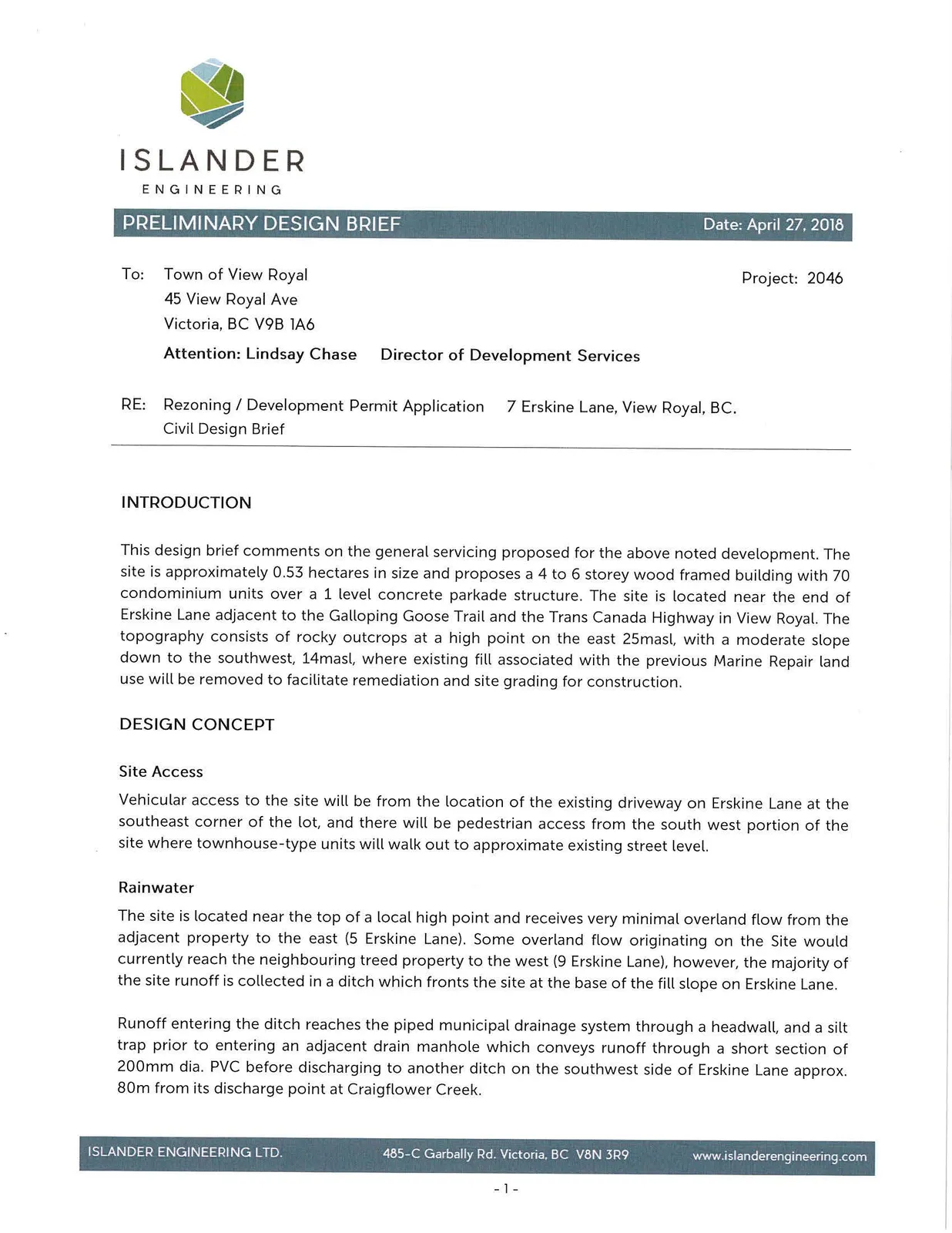

PRELIMINARY DESIGN BRIEF

Date: April 27, 2018 Project: 2046

To: Town of View Royal 45 View Royal Ave Victoria, BC V9B 1A6 Attention: Lindsay Chase, Director of Development Services

RE: Rezoning / Development Permit Application — 7 Erskine Lane, View Royal, BC. Civil Design Brief

Page 122–125

INTRODUCTION

This design brief comments on the general servicing proposed for the above noted development. The site is approximately 0.53 hectares in size and proposes a 4 to 6 storey wood framed building with 70 condominium units over a 1 level concrete parkade structure. The site is located near the end of Erskine Lane adjacent to the Galloping Goose Trail and the Trans Canada Highway in View Royal. The topography consists of rocky outcrops at a high point on the east 25masl, with a moderate slope down to the southwest, 14masl, where existing fill associated with the previous Marine Repair land use will be removed to facilitate remediation and site grading for construction.

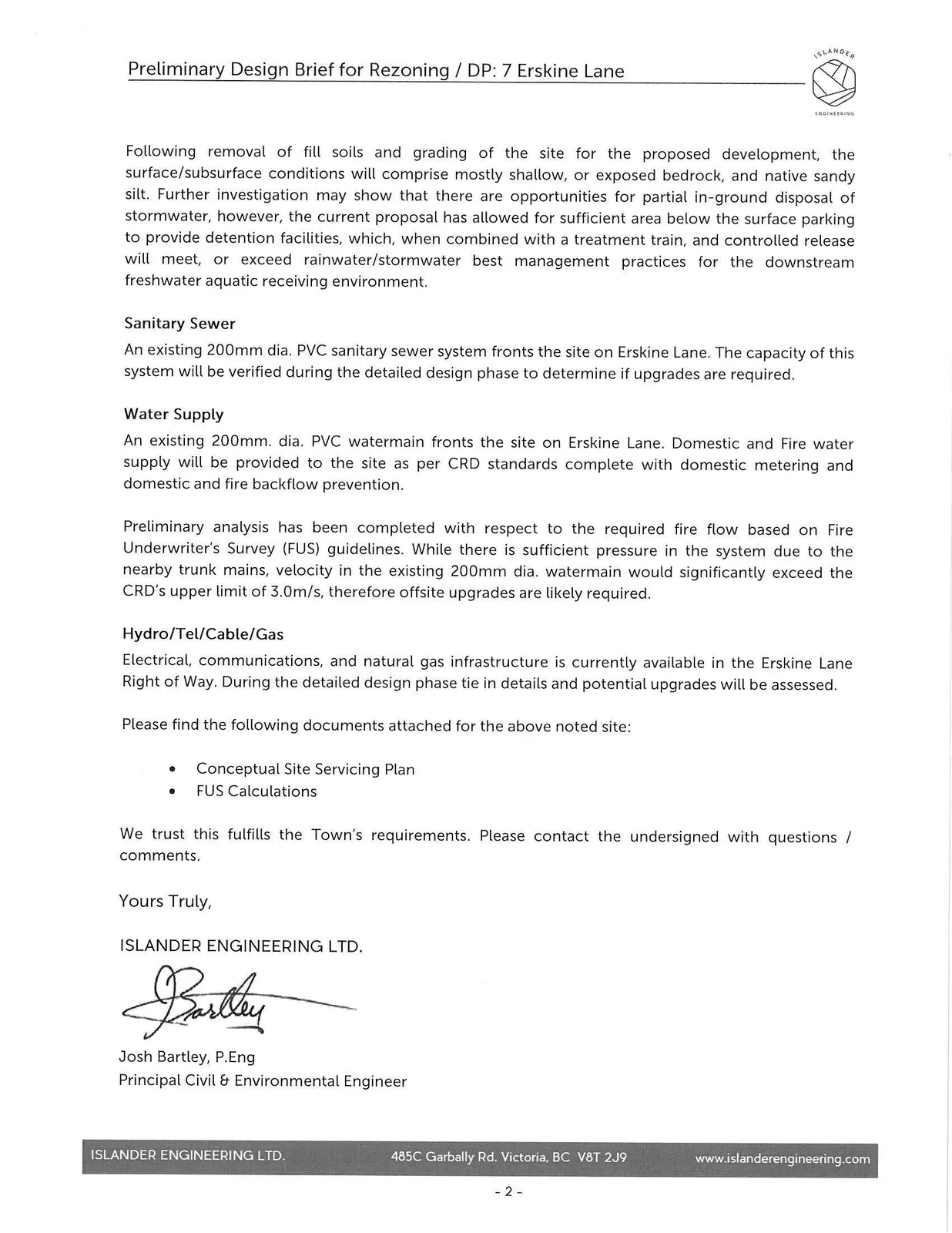

Page 122–125

DESIGN CONCEPT

Site Access

Vehicular access to the site will be from the location of the existing driveway on Erskine Lane at the southeast corner of the lot, and there will be pedestrian access from the south west portion of the site where townhouse-type units will walk out to approximate existing street level.

Rainwater

The site is located near the top of a local high point and receives very minimal overland flow from the adjacent property to the east (5 Erskine Lane). Some overland flow originating on the Site would currently reach the neighbouring treed property to the west (9 Erskine Lane), however, the majority of the site runoff is collected in a ditch which fronts the site at the base of the fill slope on Erskine Lane.

Runoff entering the ditch reaches the piped municipal drainage system through a headwall, and a silt trap prior to entering an adjacent drain manhole which conveys runoff through a short section of 200mm dia. PVC before discharging to another ditch on the southwest side of Erskine Lane approx. 80m from its discharge point at Craigflower Creek.

Following removal of fill soils and grading of the site for the proposed development, the surface/subsurface conditions will comprise mostly shallow, or exposed bedrock, and native sandy silt. Further investigation may show that there are opportunities for partial in-ground disposal of stormwater, however, the current proposal has allowed for sufficient area below the surface parking to provide detention facilities, which, when combined with a treatment train, and controlled release will meet, or exceed rainwater/stormwater best management practices for the downstream freshwater aquatic receiving environment.

Sanitary Sewer

An existing 200mm dia. PVC sanitary sewer system fronts the site on Erskine Lane. The capacity of this system will be verified during the detailed design phase to determine if upgrades are required.

Water Supply

An existing 200mm. dia. PVC watermain fronts the site on Erskine Lane. Domestic and Fire water supply will be provided to the site as per CRD standards complete with domestic metering and domestic and fire backflow prevention.

Preliminary analysis has been completed with respect to the required fire flow based on Fire Underwriter's Survey (FUS) guidelines. While there is sufficient pressure in the system due to the nearby trunk mains, velocity in the existing 200mm dia. watermain would significantly exceed the CRD's upper limit of 3.0m/s, therefore offsite upgrades are likely required.

Hydro/Tel/Cable/Gas

Electrical, communications, and natural gas infrastructure is currently available in the Erskine Lane Right of Way. During the detailed design phase tie in details and potential upgrades will be assessed.

Please find the following documents attached for the above noted site:

  • Conceptual Site Servicing Plan
  • FUS Calculations

We trust this fulfills the Town's requirements. Please contact the undersigned with questions / comments.

Yours Truly,

ISLANDER ENGINEERING LTD.

Josh Bartley, P.Eng Principal Civil & Environmental Engineer


Page 122–125

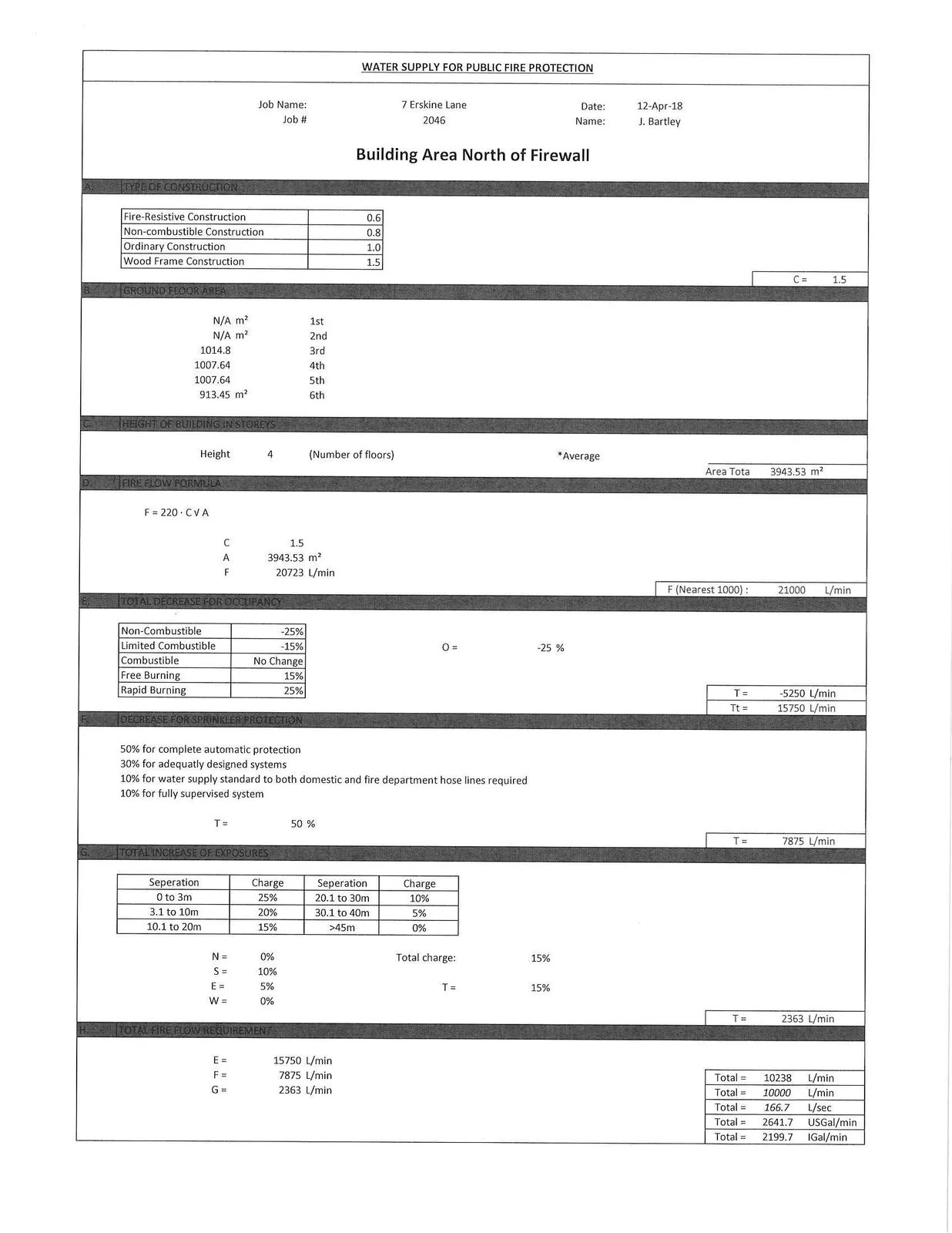

WATER SUPPLY FOR PUBLIC FIRE PROTECTION

Job Name: 7 Erskine Lane Date: 12-Apr-18 Job #: 2046 Name: J. Bartley

Building Area North of Firewall

A. TYPE OF CONSTRUCTION
Fire-Resistive Construction 0.6
Non-combustible Construction 0.8
Ordinary Construction 1.0
Wood Frame Construction 1.5
C = 1.5
B. GROUND FLOOR AREA
N/A m² 1st
N/A m² 2nd
1014.8 3rd
1007.64 4th
1007.64 5th
913.45 m² 6th
C. HEIGHT OF BUILDING IN STOREYS
Height 4 (Number of floors) *Average
Area Tota 3943.53 m²
D. FIRE FLOW FORMULA
F = 220 · C √A
C 1.5
A 3943.53 m²
F 20723 L/min
F (Nearest 1000): 21000 L/min
E. TOTAL DECREASE FOR OCCUPANCY
Non-Combustible -25%
Limited Combustible -15% O = -25 %
Combustible No Change
Free Burning 15%
Rapid Burning 25% T =
Tt =
F. DECREASE FOR SPRINKLER PROTECTION
50% for complete automatic protection
30% for adequately designed systems
10% for water supply standard to both domestic and fire department hose lines required
10% for fully supervised system
T = 50 %
T = 7875 L/min
G. TOTAL INCREASE OF EXPOSURES
Seperation Charge Seperation Charge
0 to 3m 25% 20.1 to 30m 10%
3.1 to 10m 20% 30.1 to 40m 5%
10.1 to 20m 15% >45m 0%
N = 0% Total charge: 15%
S = 10%
E = 5% T = 15%
W = 0%
T = 2363 L/min
H. TOTAL FIRE FLOW REQUIREMENT
E = 15750 L/min
F = 7875 L/min Total = 10238 L/min
G = 2363 L/min Total = 10000 L/min
Total = 166.7 L/sec
Total = 2641.7 USGal/min
Total = 2199.7 IGal/min

Page 122–125

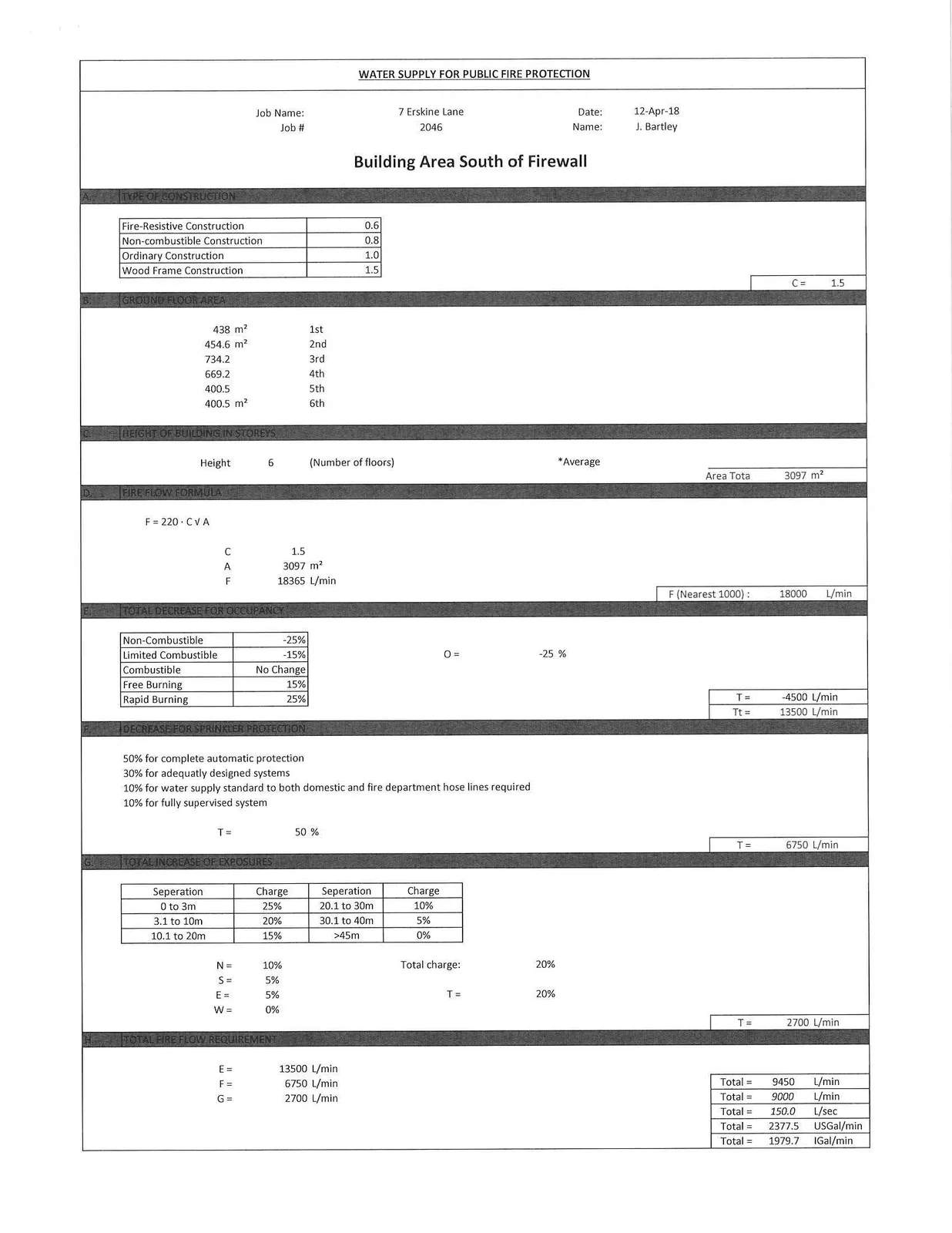

WATER SUPPLY FOR PUBLIC FIRE PROTECTION

Job Name: 7 Erskine Lane Date: 12-Apr-18 Job #: 2046 Name: J. Bartley

Building Area South of Firewall

A. TYPE OF CONSTRUCTION
Fire-Resistive Construction 0.6
Non-combustible Construction 0.8
Ordinary Construction 1.0
Wood Frame Construction 1.5
C = 1.5
B. GROUND FLOOR AREA
438 m² 1st
454.6 m² 2nd
734.2 3rd
669.2 4th
400.5 5th
400.5 m² 6th
C. HEIGHT OF BUILDING IN STOREYS
Height 6 (Number of floors) *Average
Area Tota 3097 m²
D. FIRE FLOW FORMULA
F = 220 · C √A
C 1.5
A 3097 m²
F 18365 L/min
F (Nearest 1000): 18000 L/min
E. TOTAL DECREASE FOR OCCUPANCY
Non-Combustible -25%
Limited Combustible -15% O = -25 %
Combustible No Change
Free Burning 15%
Rapid Burning 25% T =
Tt =
F. DECREASE FOR SPRINKLER PROTECTION
50% for complete automatic protection
30% for adequately designed systems
10% for water supply standard to both domestic and fire department hose lines required
10% for fully supervised system
T = 50 %
T = 6750 L/min
G. TOTAL INCREASE OF EXPOSURES
Seperation Charge Seperation Charge
0 to 3m 25% 20.1 to 30m 10%
3.1 to 10m 20% 30.1 to 40m 5%
10.1 to 20m 15% >45m 0%
N = 10% Total charge: 20%
S = 5%
E = 5% T = 20%
W = 0%
T = 2700 L/min
H. TOTAL FIRE FLOW REQUIREMENT
E = 13500 L/min
F = 6750 L/min Total = 9450 L/min
G = 2700 L/min Total = 9000 L/min
Total = 150.0 L/sec
Total = 2377.5 USGal/min
Total = 1979.7 IGal/min
Page 122–125
