Presentation
Presentation: Draft Building Bylaw
March 14, 2023Pages 114–1296 sections
A 16-slide presentation summarizing key changes to the current Building Bylaw No. 786, including updated fees, enforcement tools, and administrative changes.
Minimum 'Work Without Permit' penalty proposed at $1000, maximum $25,000Proposed re-inspection fee of $100/hrRecommended enactment date: September 5, 2023Current Building Bylaw was enacted 12 years ago
Purpose of Report
- Present Council with information regarding an update to the current Building Bylaw No. 786
- Discuss key changes to the Bylaw
- Outline outstanding tasks and consequential amendments to other bylaws that are needed to support this project.
Page 114–129
BACKGROUND:
- The current Building Bylaw No. 786 was enacted 12 years ago and has not had a substantive review since its adoption.
- The Municipal Insurance Association (MIA) developed an updated draft model Building Bylaw in 2018. The draft Building Bylaw is based on this MIA model bylaw, which will strengthen the policy defences as recommended by MIA.
Page 114–129
General Notes on Changes
- Mostly housekeeping changes
- The Fees and Charges Bylaw No. 958 and the Municipal Ticketing Information (MTI) Bylaw No. 643 must be amended in conjunction with the revised Building Bylaw
- Recommending that bylaw enactment date of the new Building Bylaw is September 5, 2023 to enable smooth transition.
Page 114–129
Key Changes:
- Scopes and Exemptions (4.1-4.3) –
- specific scopes of work where a building permit is required and not required such as a fence, tent, paving, etc.
- Refusal and Revocation of Permits (7.6) –
- Permits are revoked when they are issued in error or for serious violations after a permit has been issued.
- Demolition Requirements (8.8, 8.9) –
- should construction not commence within 6 months: clear and make levelled the site, install security fencing and provide an interim landscaping plan.
- Professional Engineer’s Review (10.3) –
- P.Eng. For a building envelope design and retaining walls over 1.2m (change from 1.5m currently)
- a separate independent check of structural design of a complex building
- Intake Screening (11.1-11.3) –
- new intake procedure to better manage workflow
- an approved development permit and a conditional approval of the Servicing Agreement must be in place at BP application
- Certified Professionals (CP) (11.8-11.20) –
- for administering permits for complex building permits
- CPs are Registered Architects or Professional Engineers
- an added layer of expertise for the permit issuance of complex buildings
- Only CP projects be allowed for phased permits (excavation/foundation/full)
- Using CPs is optional for owners
- Cost of Construction (definition & 11.22) –
- include most hard and soft costs
- building permit fee may be higher
- re-evaluation of construction cost at occupancy
- Excavation Securities (11.28) –
- increase to 2x the cost of site restoration, minimum $50,000
- Bad Faith Clause (11.45) –
- Optional enforcement tool: stop services pertaining to any permit activities if same owner or constructor has violations in another site
- Permit Expirations and Extensions (11.47 & 11.48) –
- 2 years from the date of issuance + 2 x 1 year extension = 4 years for project completion.
- any remaining work under new permit
- may apply to Council to further extend their permit
- Expiry of Permit Applications (11.50) –
- 60 days to respond to an application review notice
- 30 days to pick up the permit once the permit is readied
- Revisions (11.52-11.54) -
- parameters for revisions include: change to volumetric shape, form and character, grading, siting, parking, unit counts, etc.
- Alternative Solutions (11.55) –
- new fee for the review of the alternative solution report for cost recovery
- Plumbing Permits (Part 13) –
- only licenced plumbing contractors to obtain the plumbing permits
- set up a certification acceptance system, if needed
- Monitoring check (definition & 14.4) –
- building inspector is clarified to perform a "monitoring check" for complex buildings
- clearly excludes building envelope, mechanical systems and structural elements that are under the design of a Registered Professional
- Safe Worksites (8.4, Part 16) –
- owner is responsible for Worksafe regulations, manage construction parking & materials storage, provide sanitary facilities, and deal with hazardous materials
- stipulate asbestos abatement work for buildings older than 1990
- Administrative Changes for Occupancy (18.1-18.10) –
- new “final inspection notice” to authorize an occupancy if outstanding items that are not life safety related, such as paving and landscaping.
- approval for a “shell building”
- allow unfinished suites, of not more than 10% of the total units, in residential buildings to accommodate future work
- Temporary Buildings (Part 19) –
- may include construction trailers, school portables, or pre-fabricated housing unit
- prudent for future project proposals
- Pools (Part 23) –
- mainly about fencing to minimize accidents
- Work Without Permit Penalty (25.3) –
- minimum penalty of $1000
- maximum penalty of $25,000

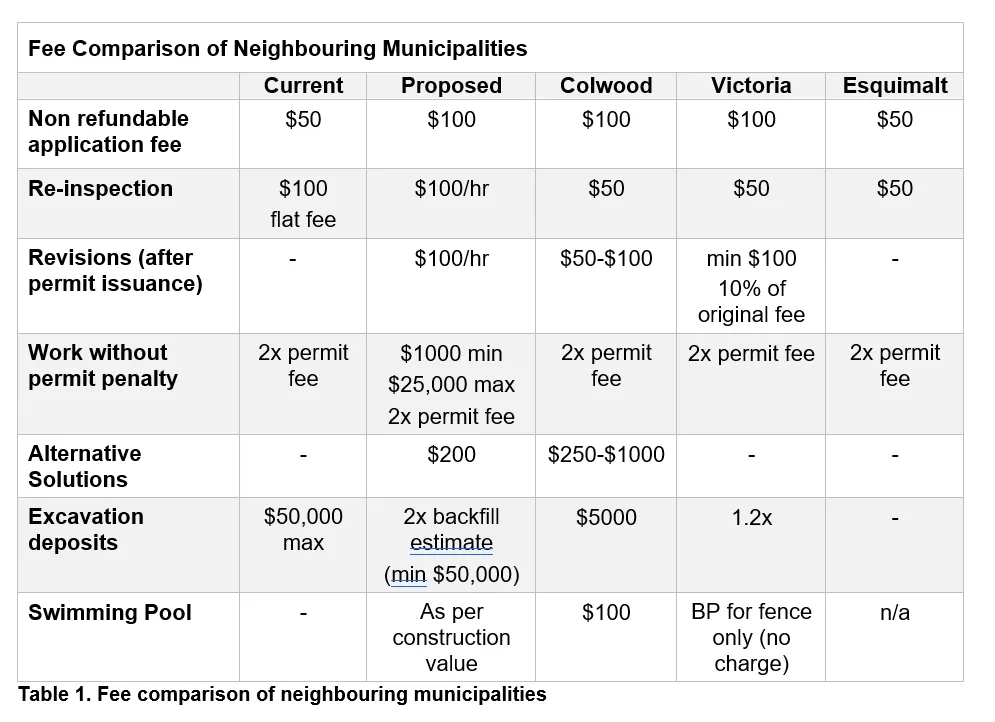

Fee Comparison of Neighbouring Municipalities
| Current | Proposed | Colwood | Victoria | Esquimalt | |
|---|---|---|---|---|---|
| Non refundable application fee | $50 | $100 | $100 | $100 | $50 |
| Re-inspection | $100 flat fee | $100/hr | $50 | $50 | $50 |
| Revisions (after permit issuance) | - | $100/hr | $50-$100 | min $100 10% of original fee | - |
| Work without permit penalty | 2x permit fee | $1000 min $25,000 max 2x permit fee | 2x permit fee | 2x permit fee | 2x permit fee |
| Alternative Solutions | - | $200 | $250-$1000 | - | - |
| Excavation deposits | $50,000 max | 2x backfill estimate (min $50,000) | $5000 | 1.2x | - |
| Swimming Pool | - | As per construction value | $100 | BP for fence only (no charge) | n/a |
Table 1. Fee comparison of neighbouring municipalities

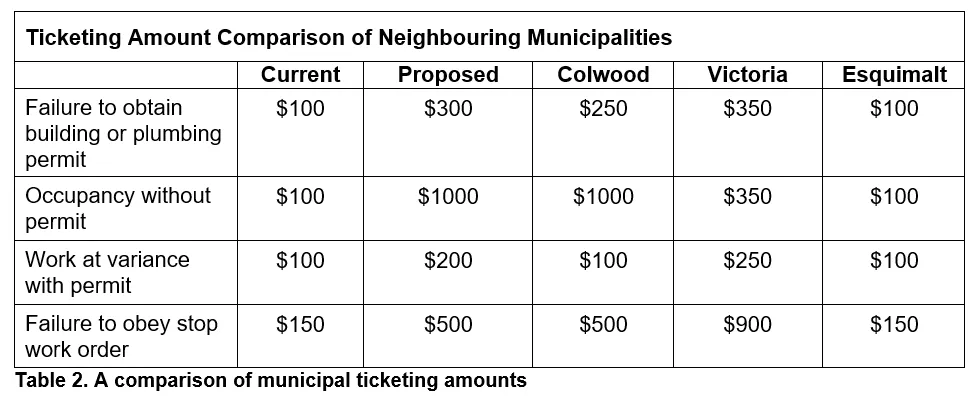

Ticketing Amount Comparison of Neighbouring Municipalities
| Current | Proposed | Colwood | Victoria | Esquimalt | |
|---|---|---|---|---|---|
| Failure to obtain building or plumbing permit | $100 | $300 | $250 | $350 | $100 |
| Occupancy without permit | $100 | $1000 | $1000 | $350 | $100 |
| Work at variance with permit | $100 | $200 | $100 | $250 | $100 |
| Failure to obey stop work order | $150 | $500 | $500 | $900 | $150 |
Table 2. A comparison of municipal ticketing amounts
- Other administrative changes:
- unsafe to occupy notice – for structurally unsafe buildings (definition, 7.4(d), 24.7)
- application to existing building (4.4-4.7)
- types of permits (6.1)
- pre-construction and pre-occupancy meetings (14.9)
- tree protection reference (11.46)
- site drainage considerations (17.1)
- retaining walls requiring professional designs– (20.1-20.2)
Page 114–129
NEXT STEPS:
- Enactment date of September 5, 2023 to give time for resource support.
- No additional Energy Step Code changes with this update. Staff will bring a report forward to Council in the future.
- Staff will bring the Building Bylaw, changes to the Fees and Charges Bylaw and MTI Bylaw for 1st, 2nd, 3rd reading.
Page 114–129
RECOMMENDATION:
THAT Committee of the Whole receive this report for information.
Page 114–129
